Pepys Restoration Project Progress
Pepys Progress
Welcome to the Pepys Restoration Project update page.
The restoration of the Grade I listed Pepys Building is progressing steadily, and we are excited to share the journey with you. This page brings together photographs and updates from the project so far, offering a behind-the-scenes look at the craftsmanship and care involved in preserving this historic landmark.
From structural repairs to the installation of modern features that will enhance accessibility and sustainability, every stage of the work reflects our commitment to safeguarding the Pepys Building and the treasures it contains for generations.
Support the Pepys Restoration Project
If you would like to support the Pepys Restoration Project, please consider making an online donation. Contributions of £1,000 or more will be recognised by listing your name in the Pepys Book of Benefactors.
November 2025

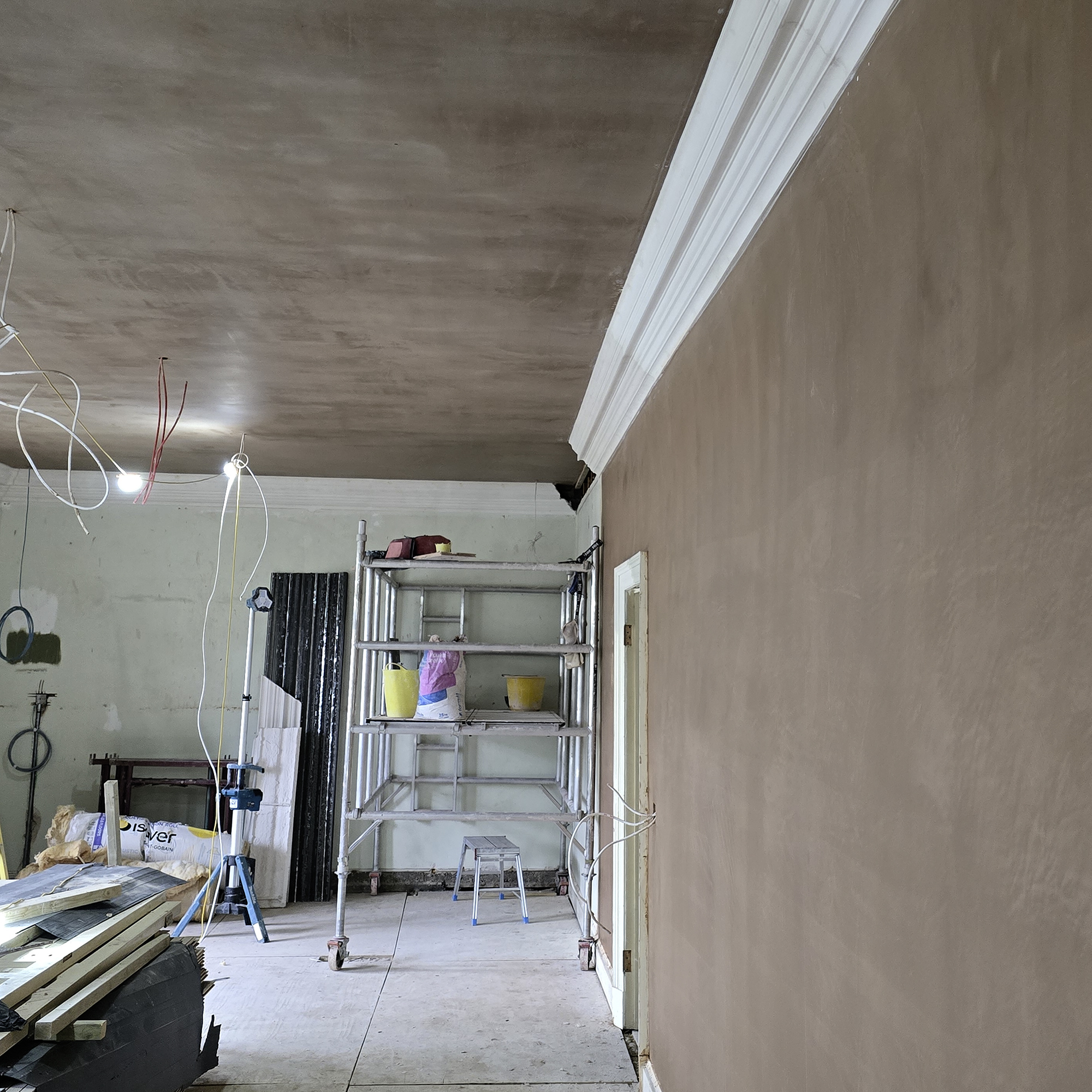

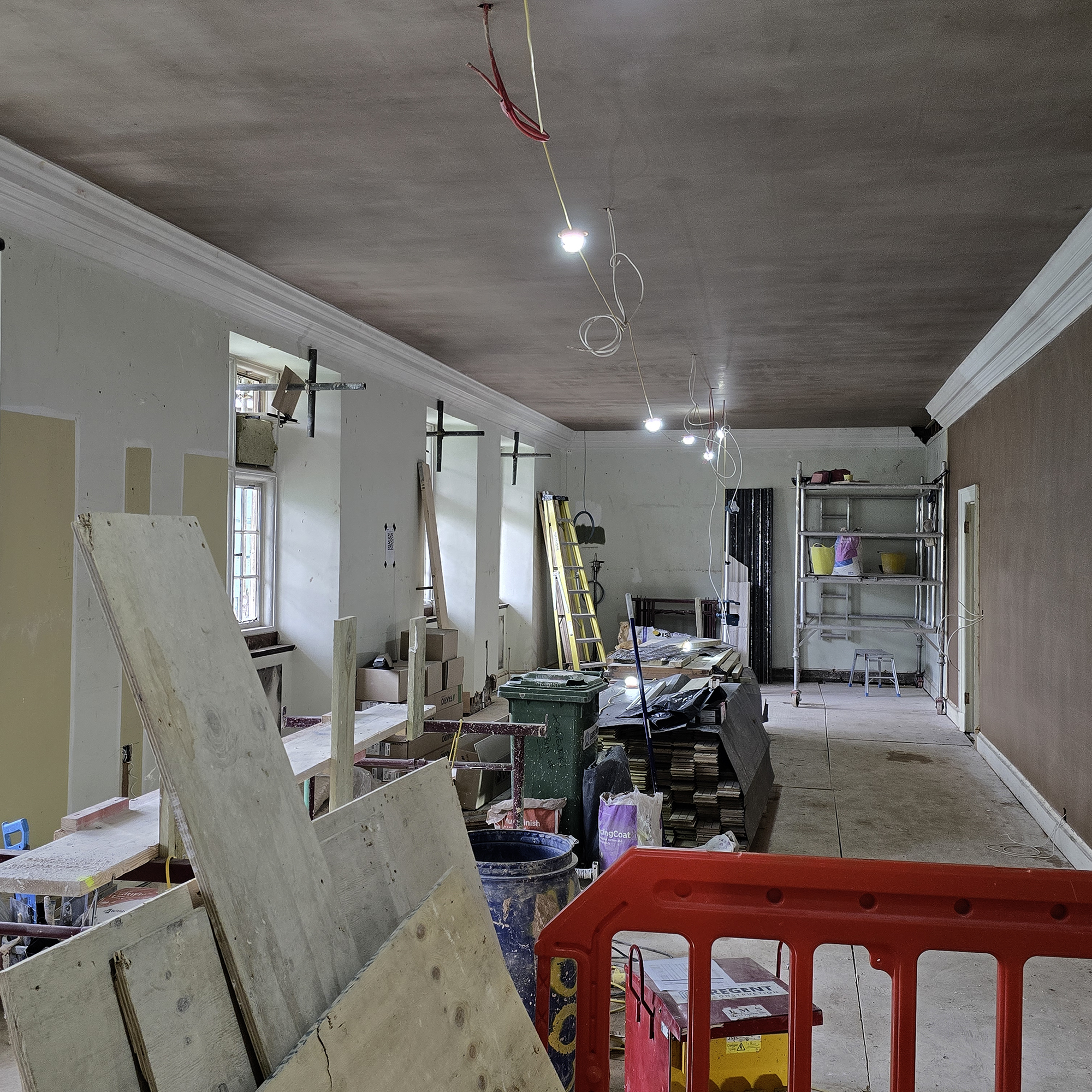

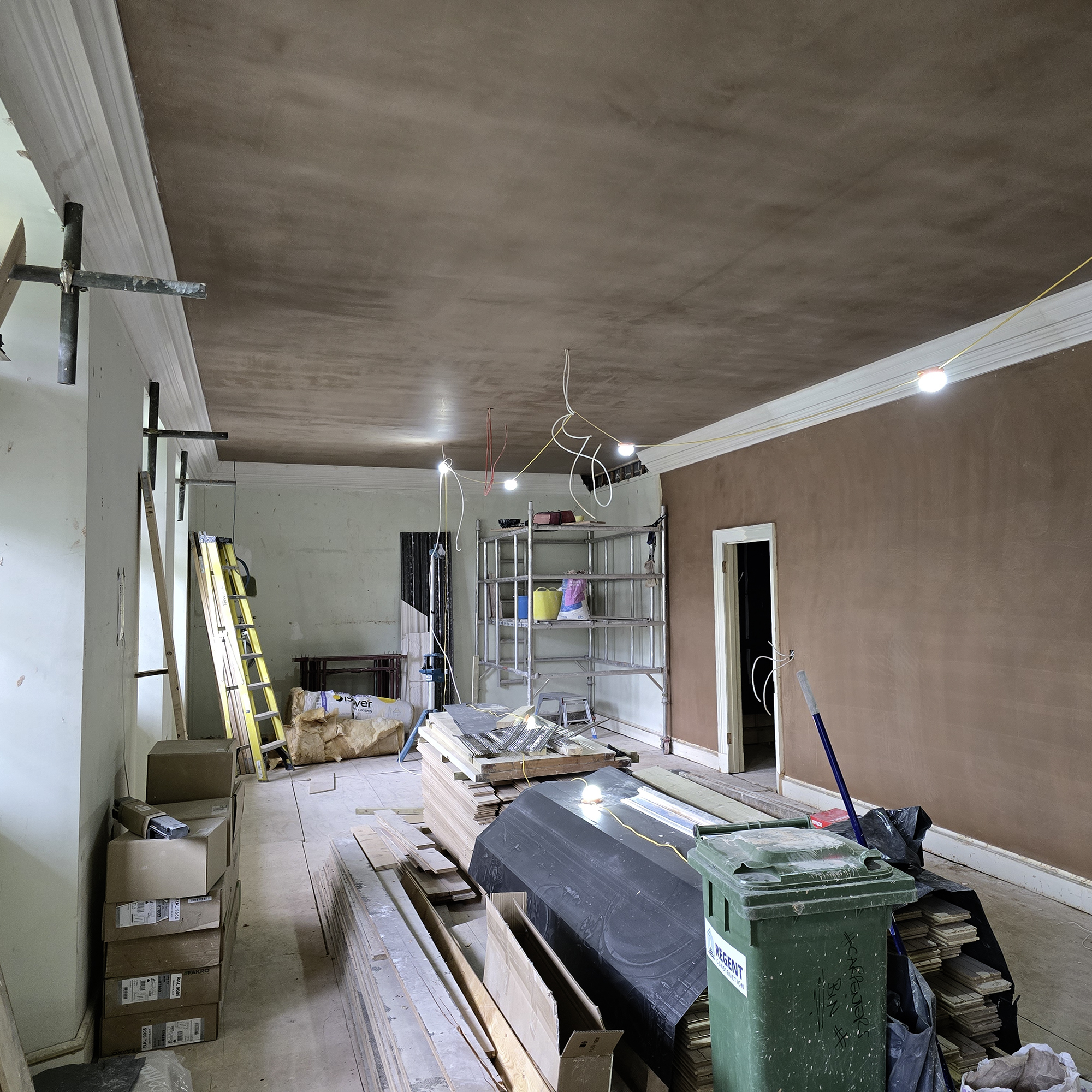

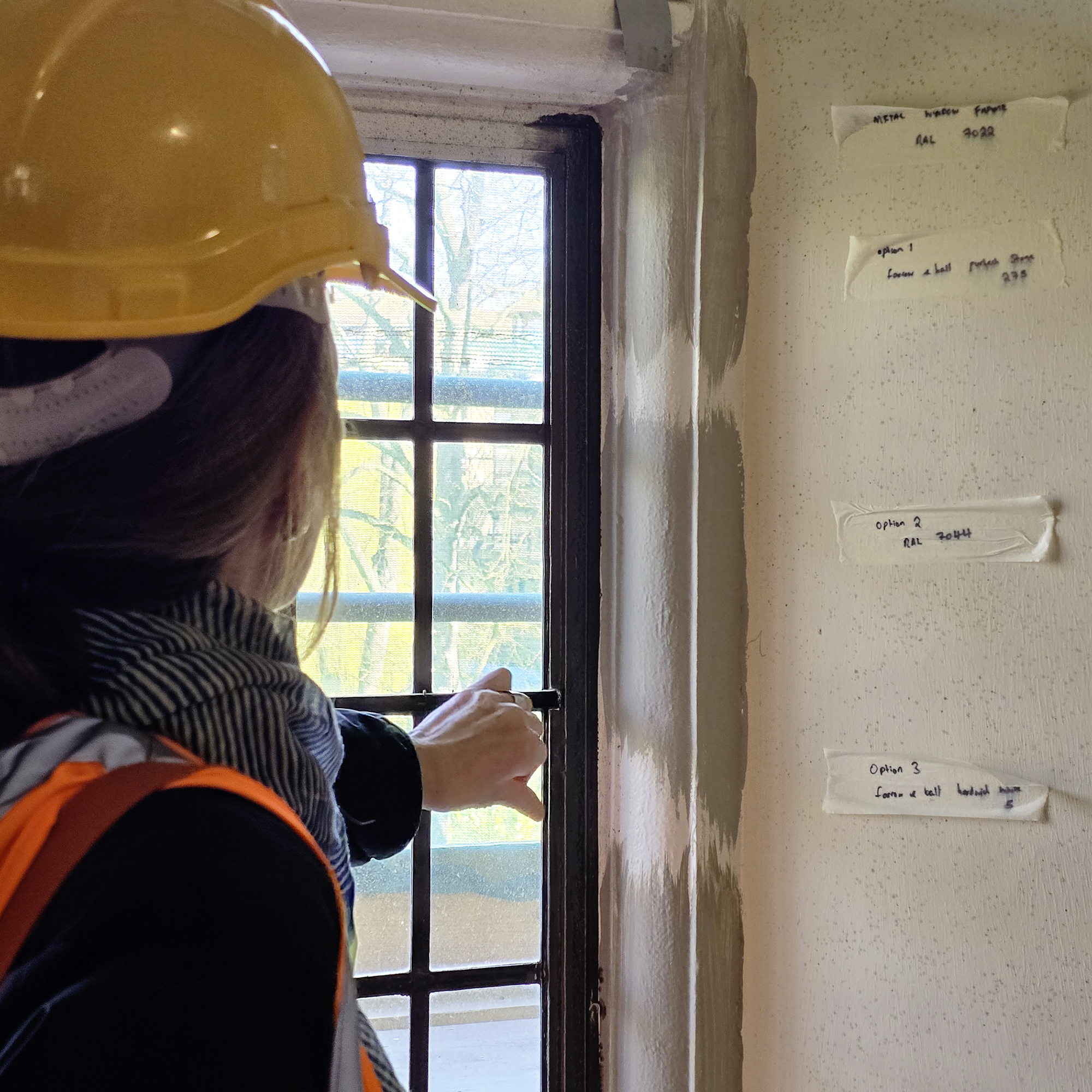

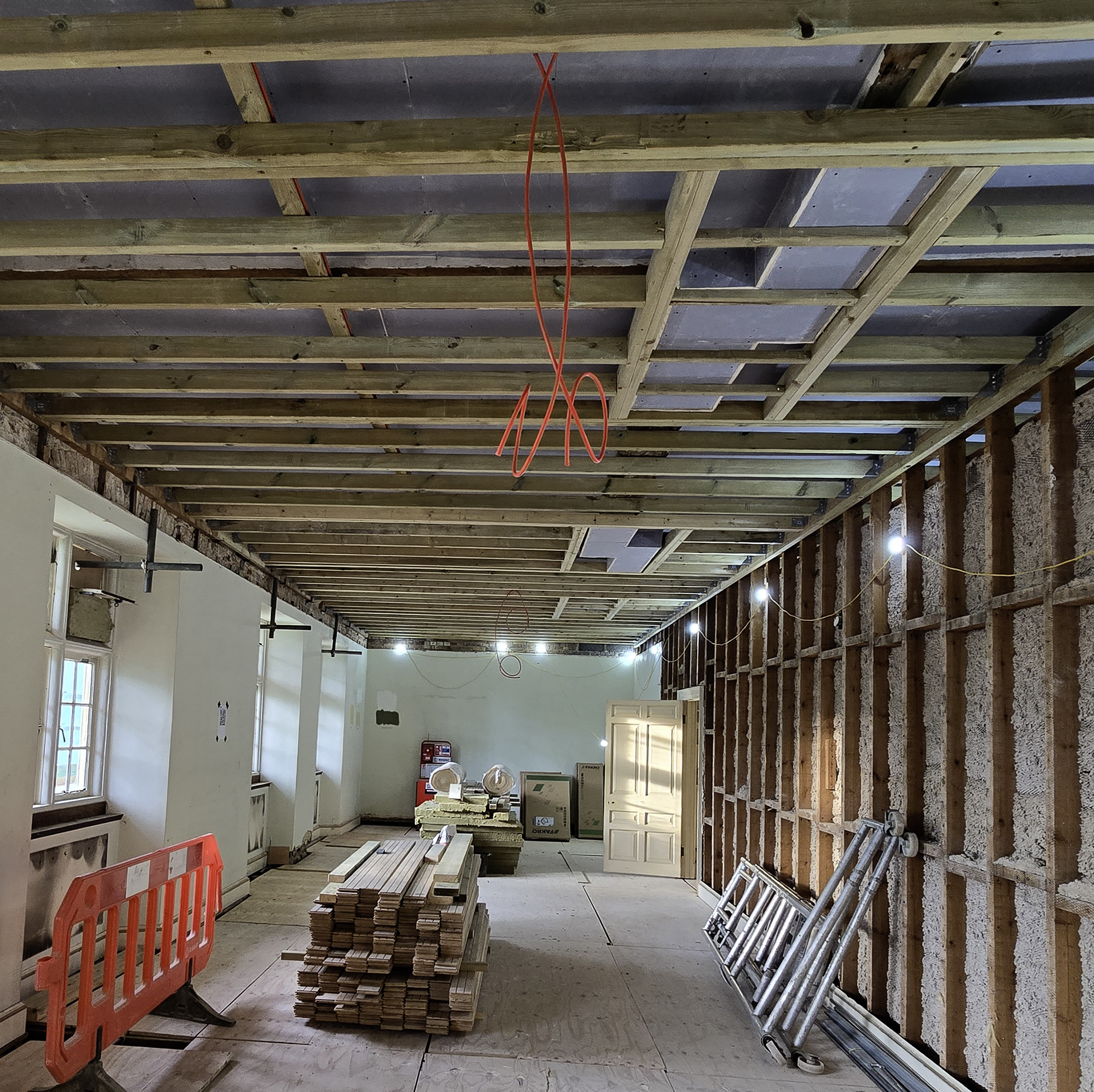

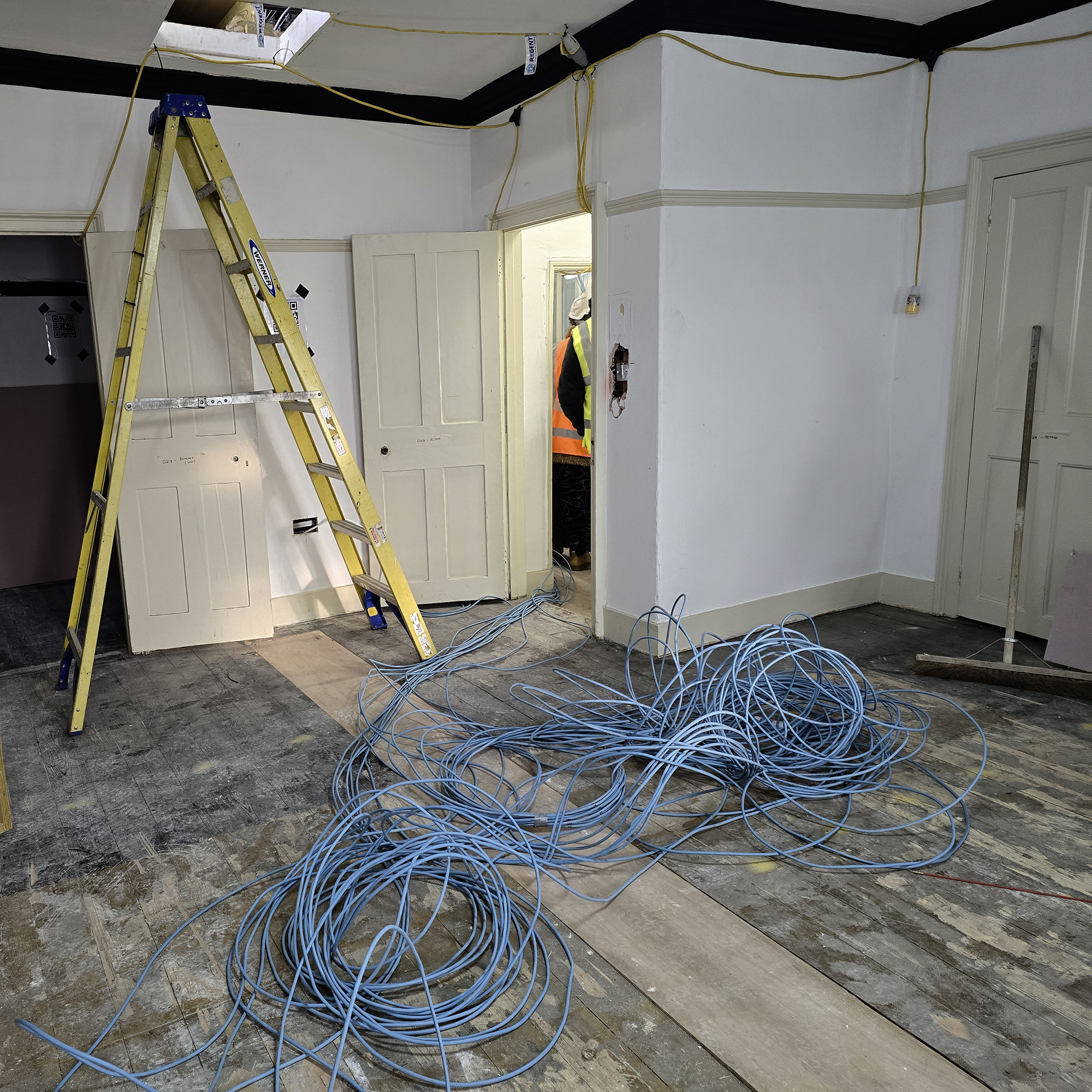

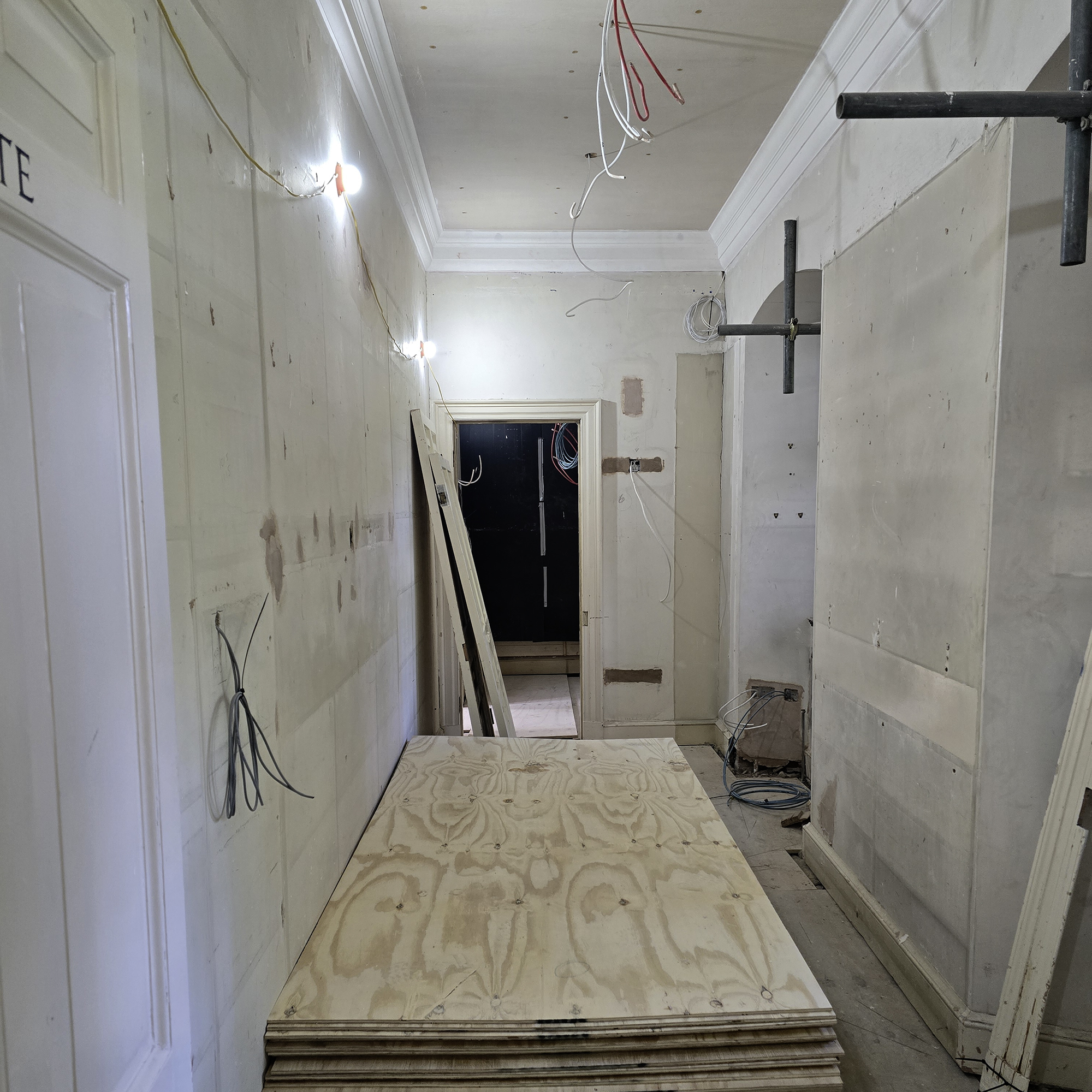

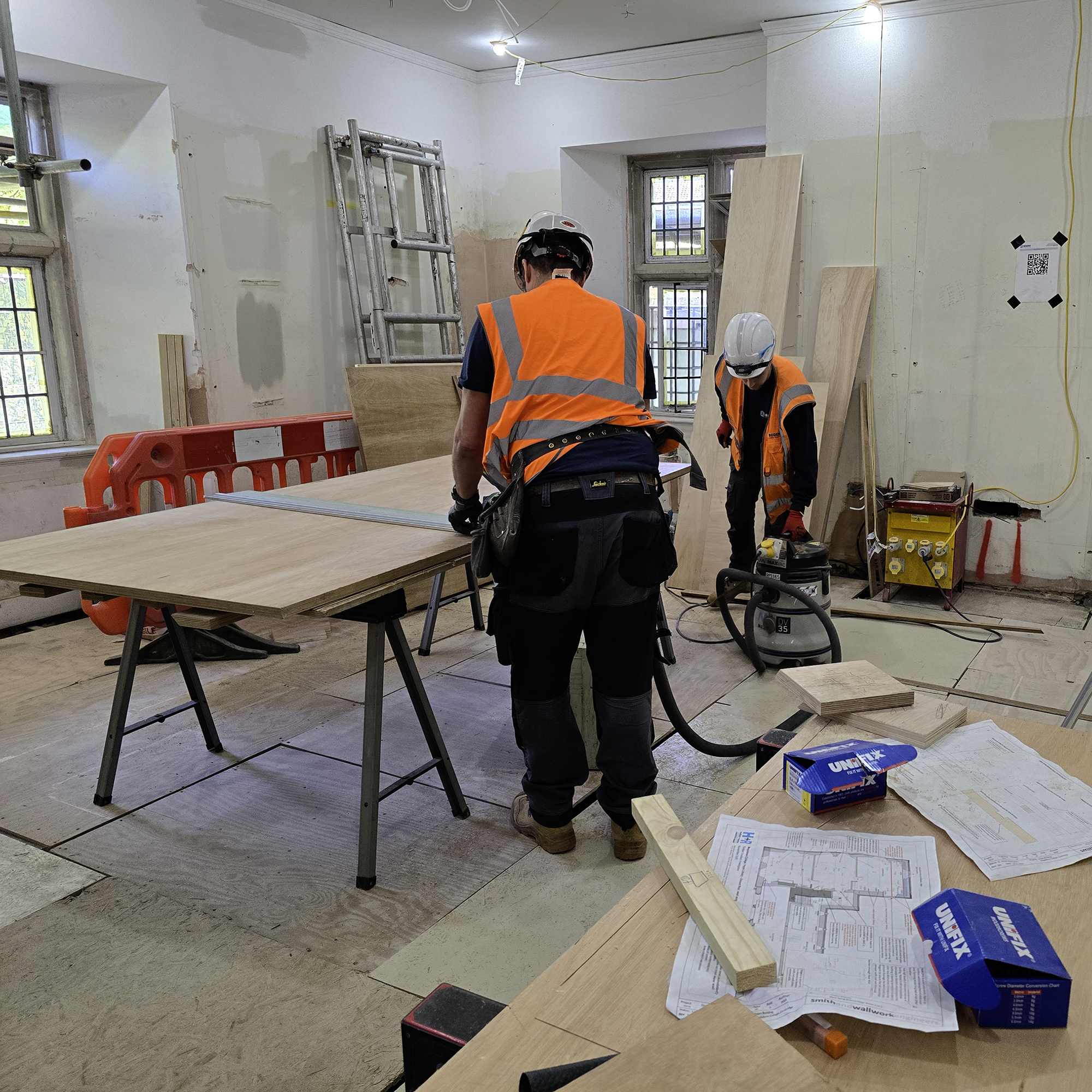

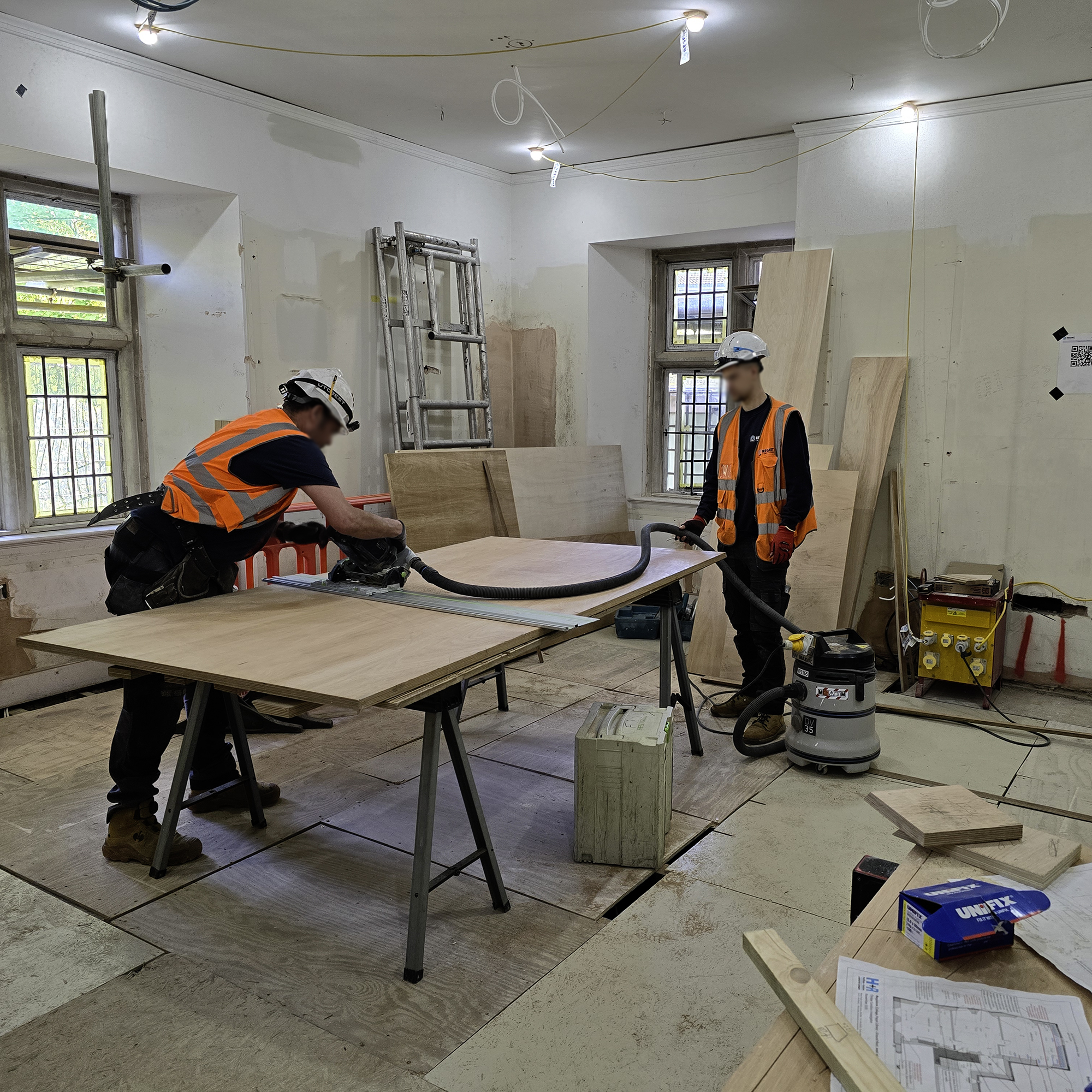

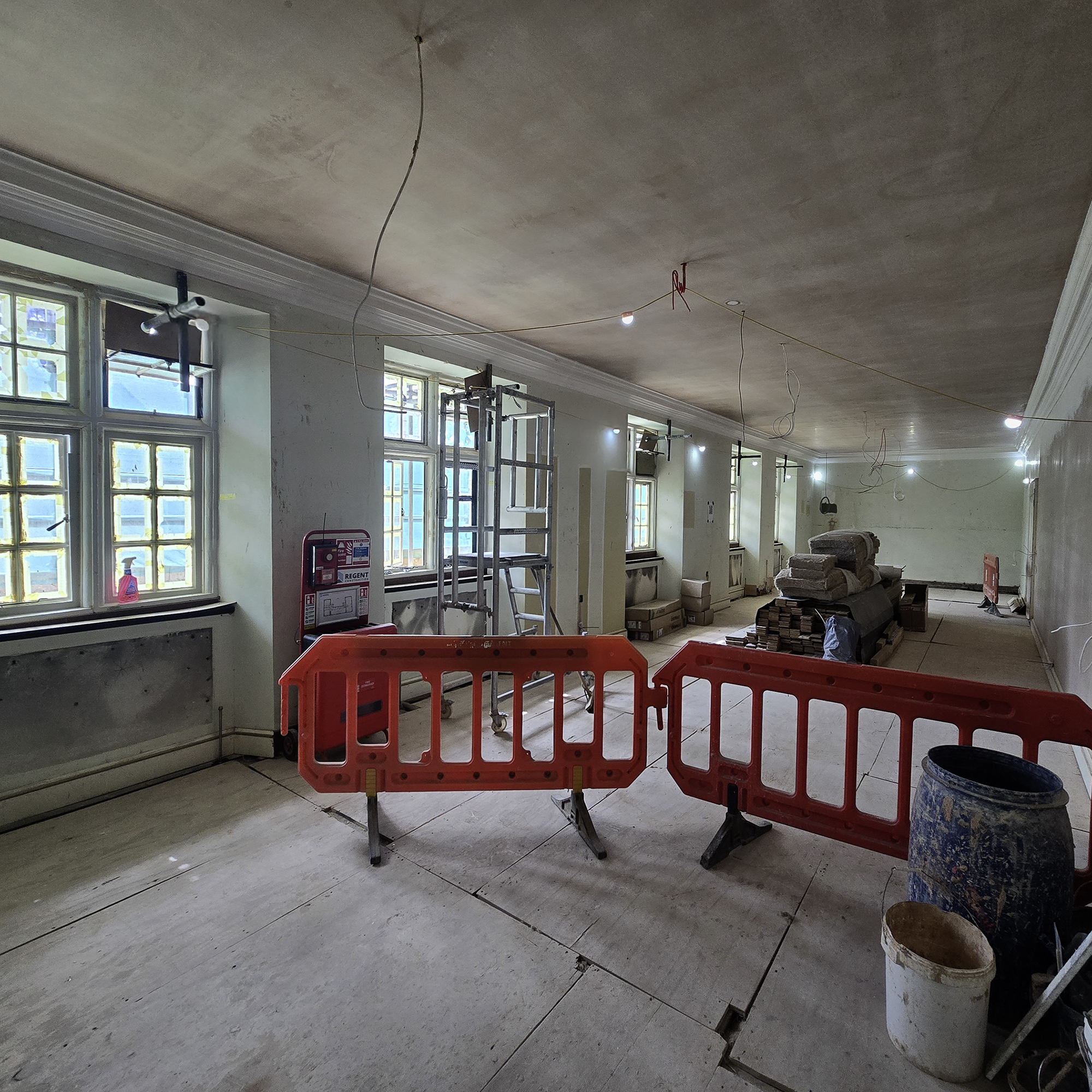

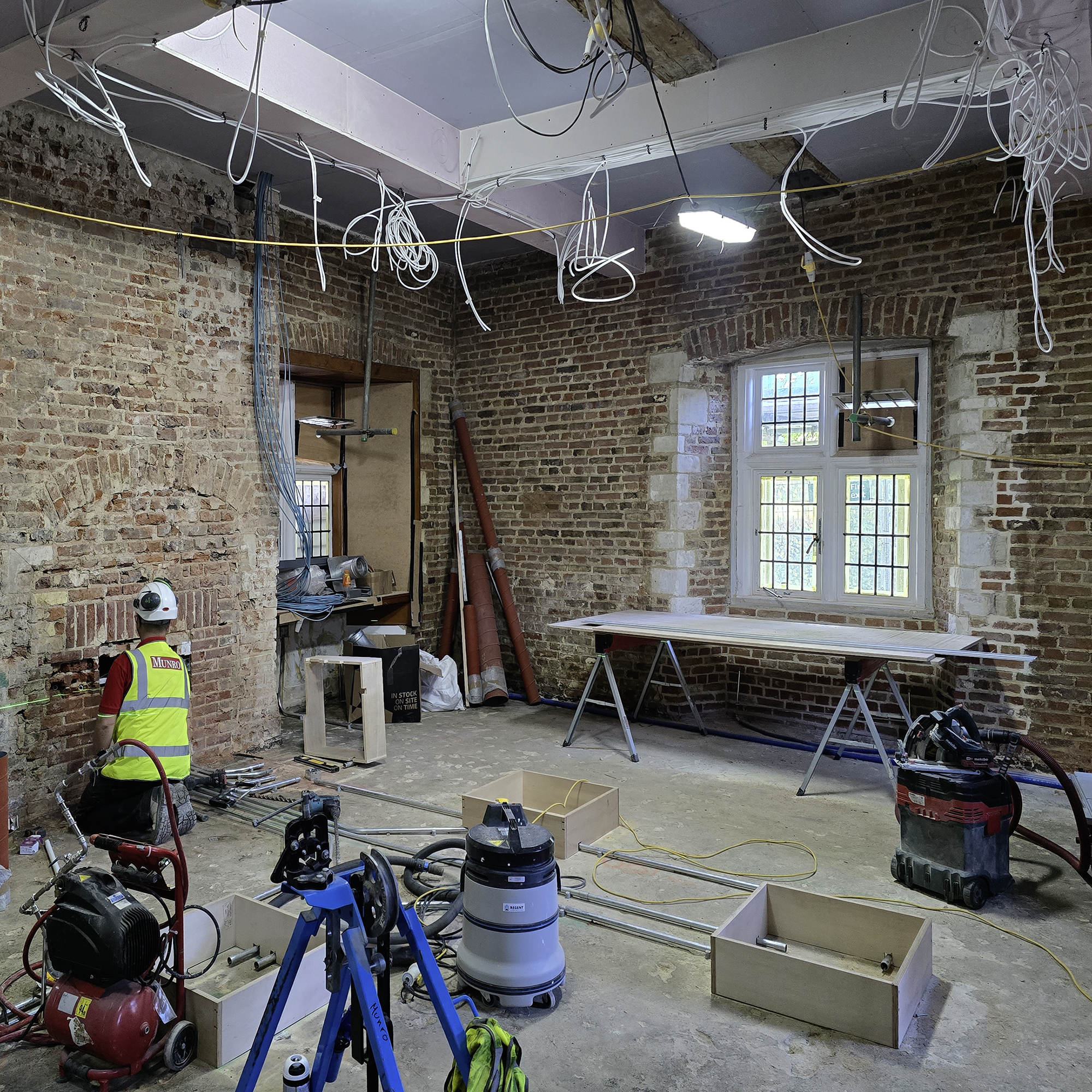

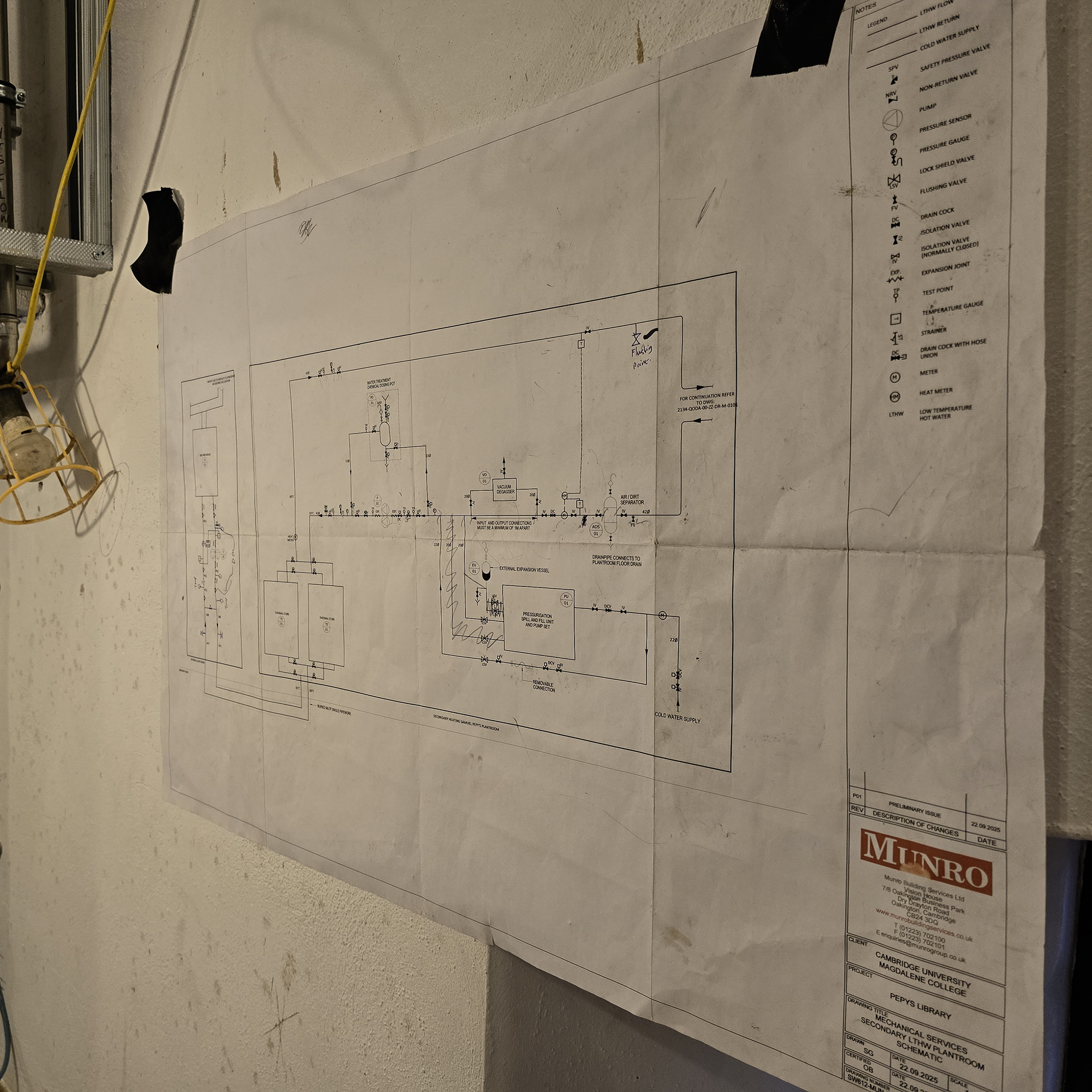

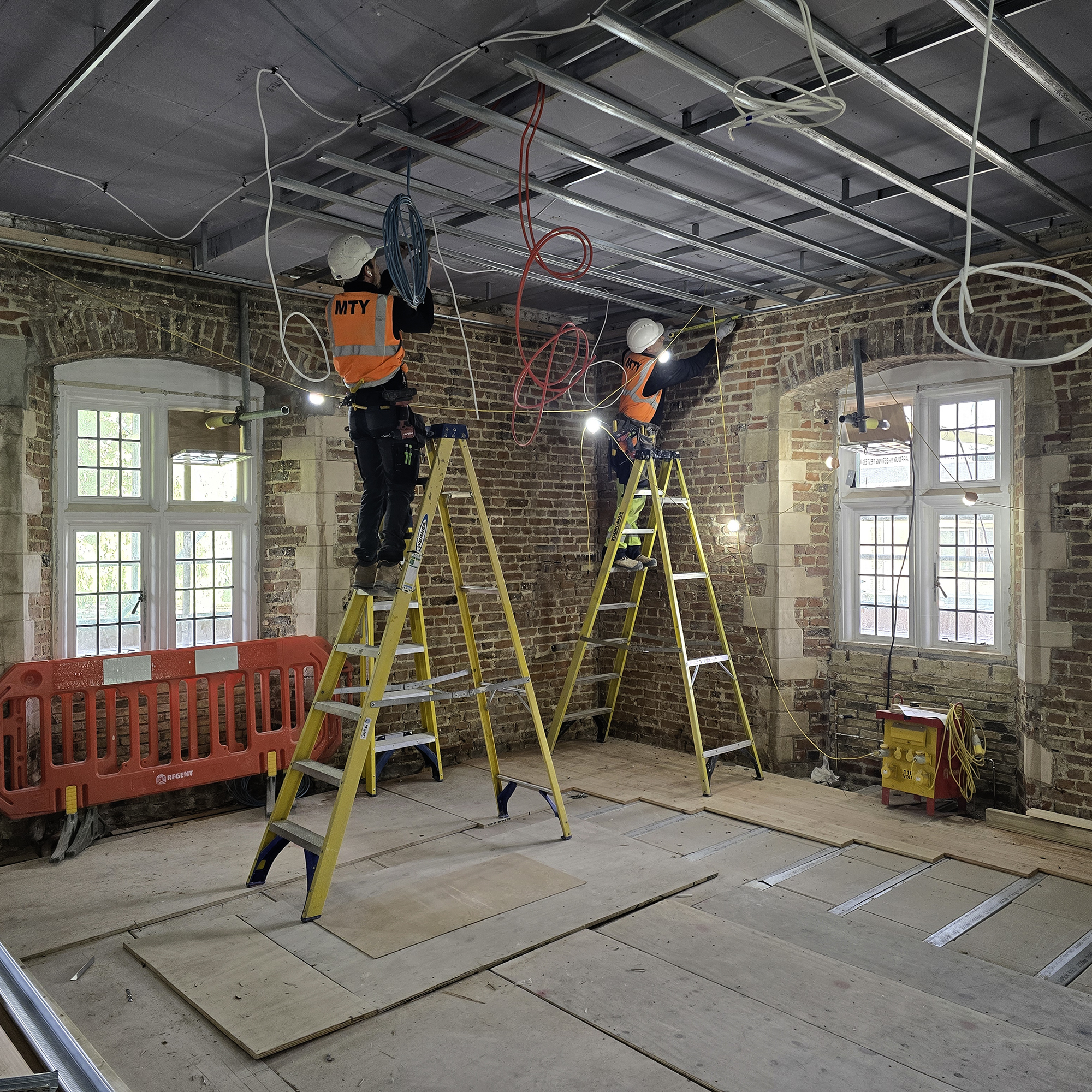

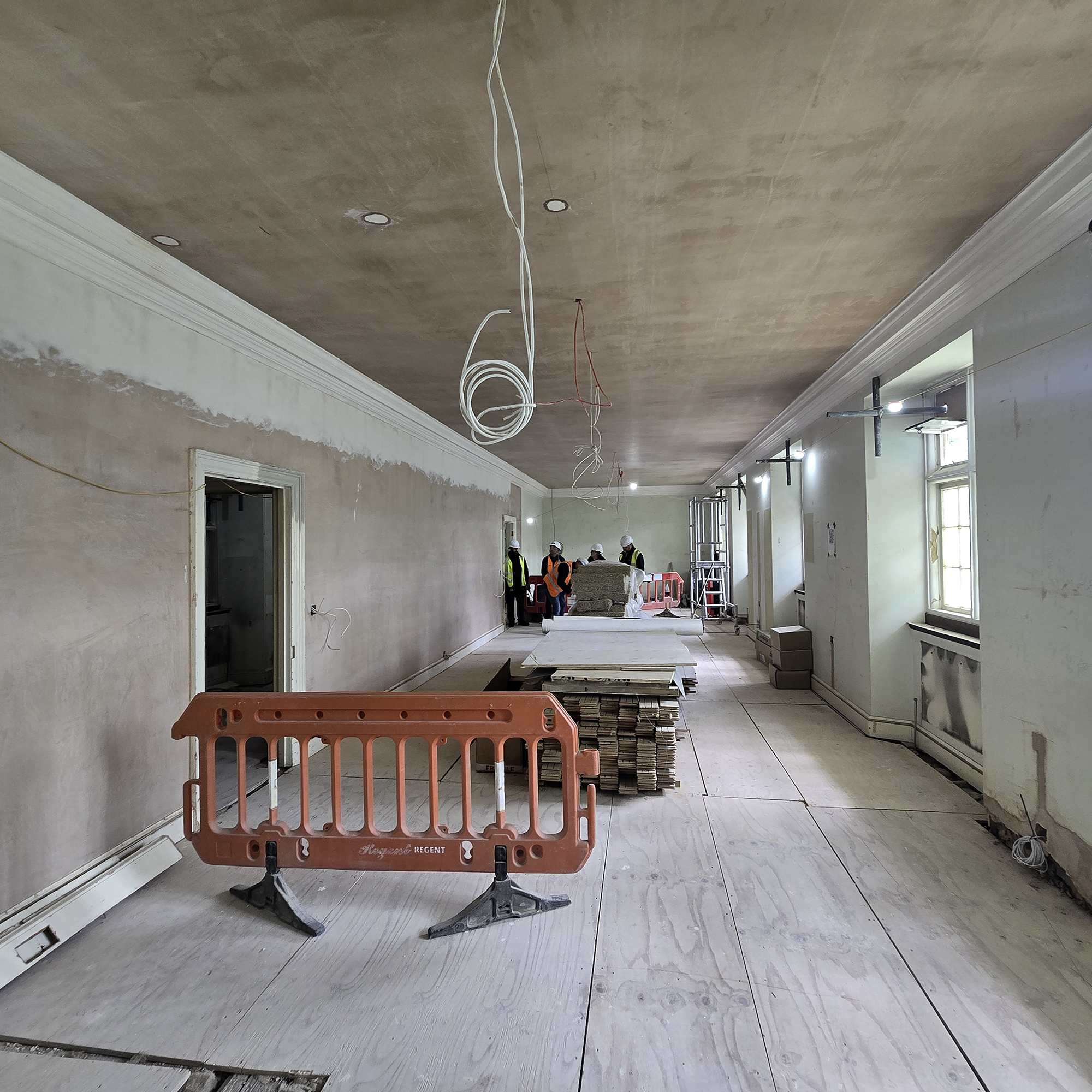

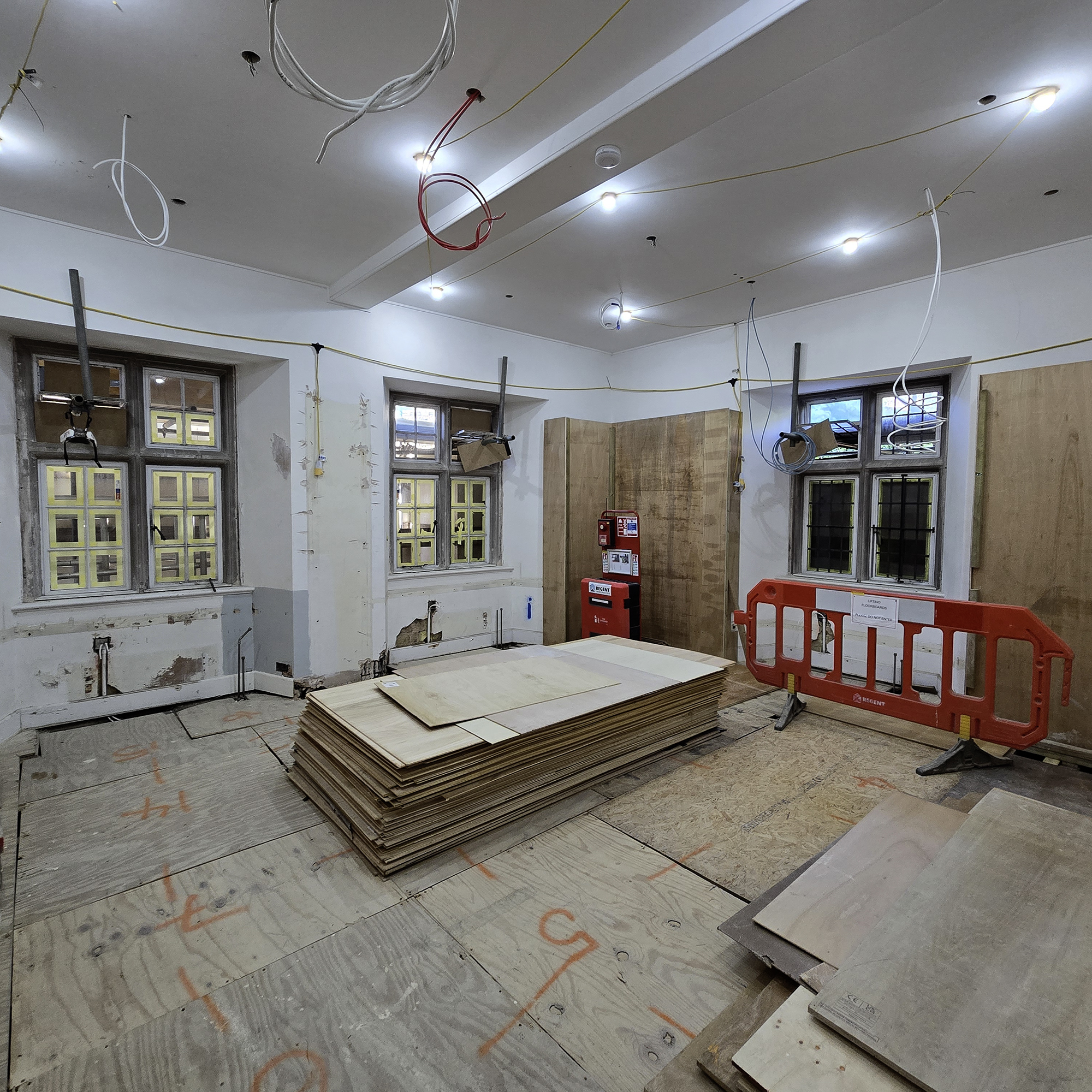

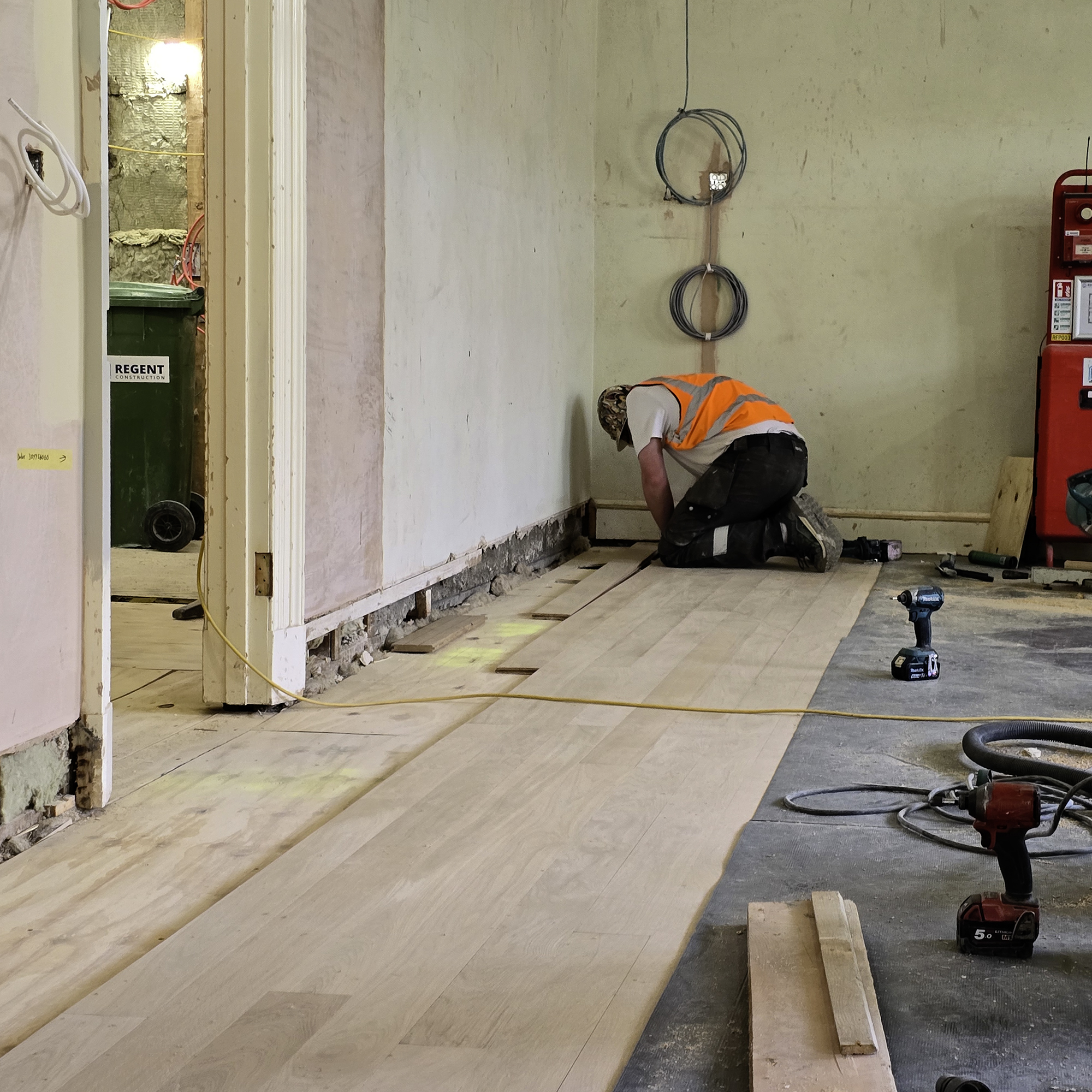

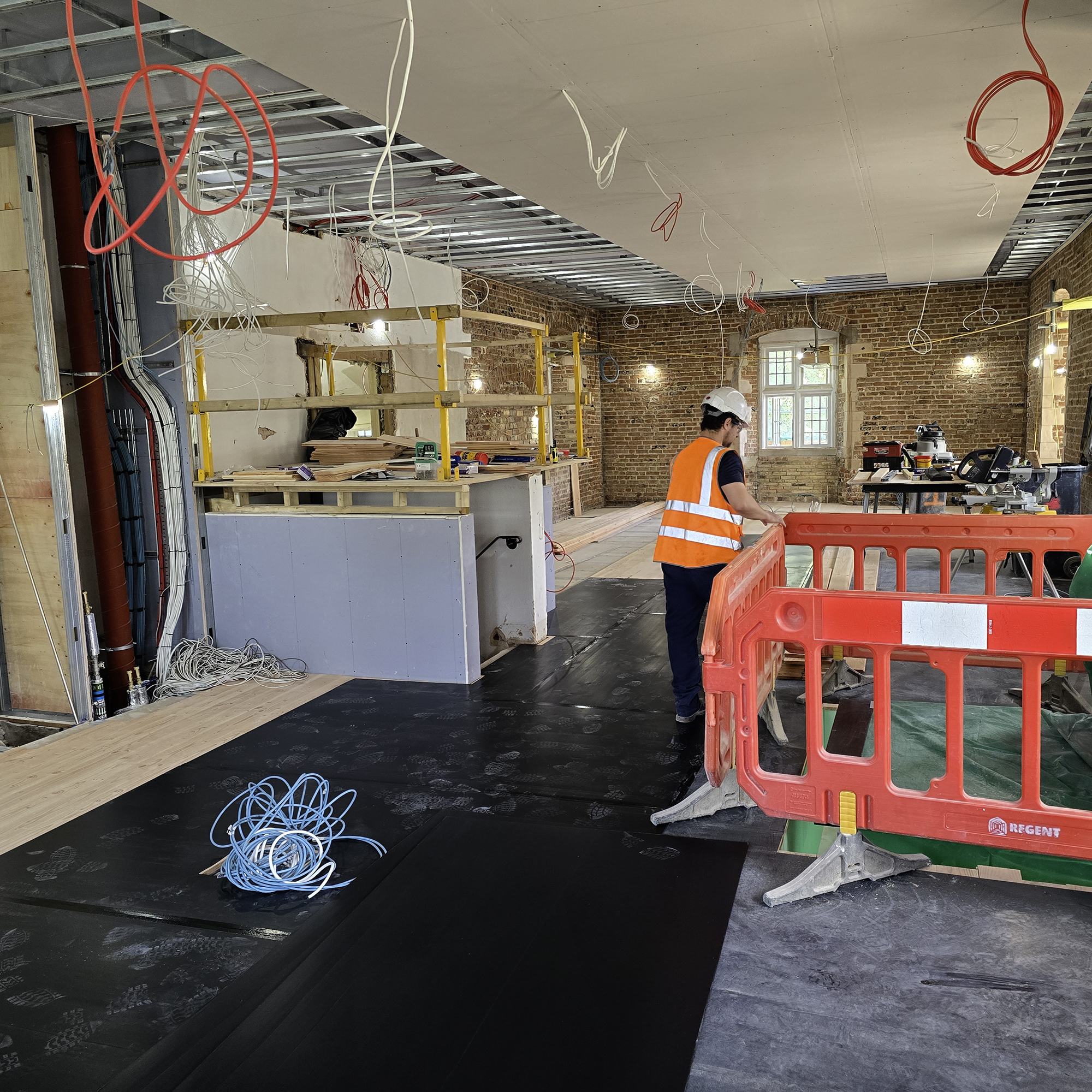

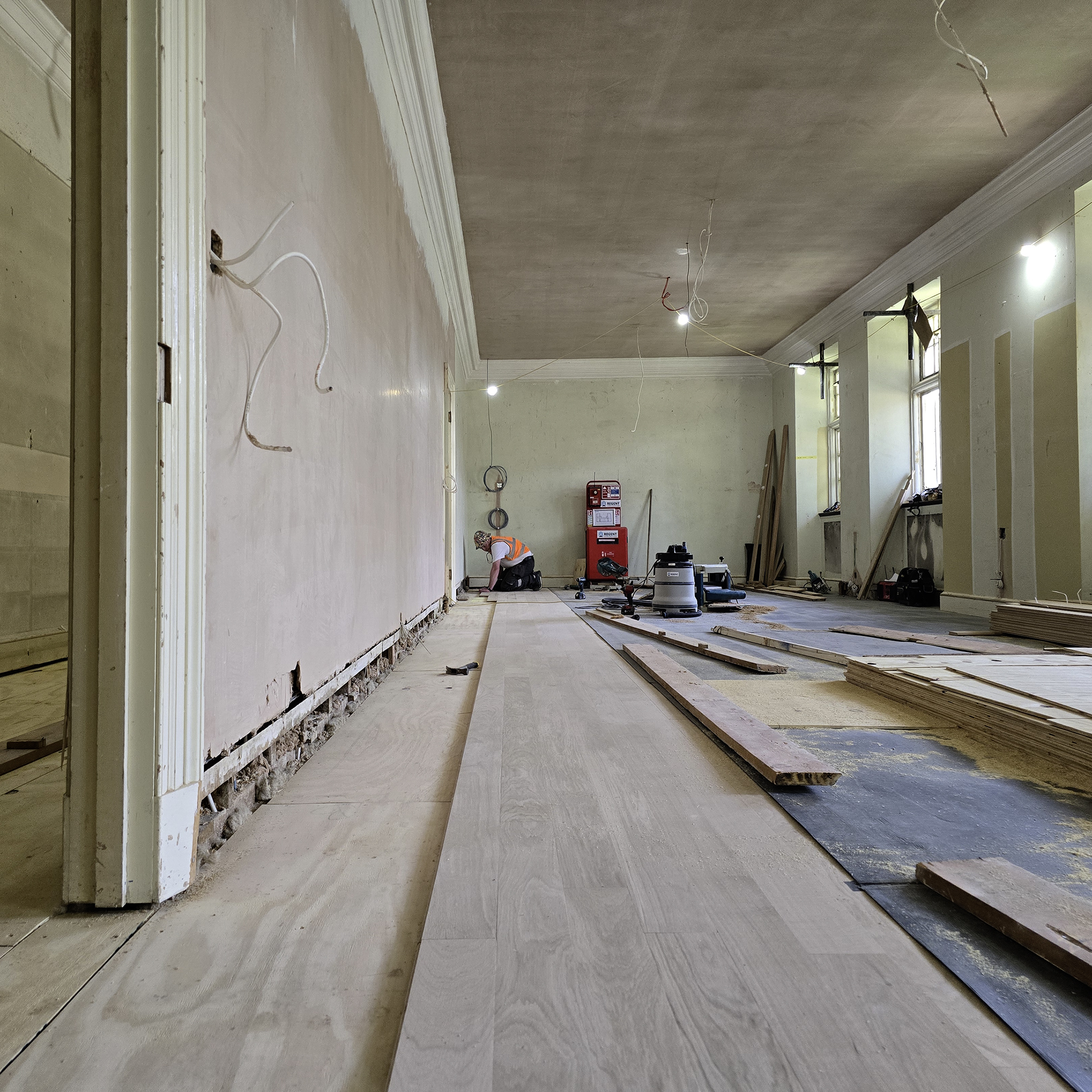

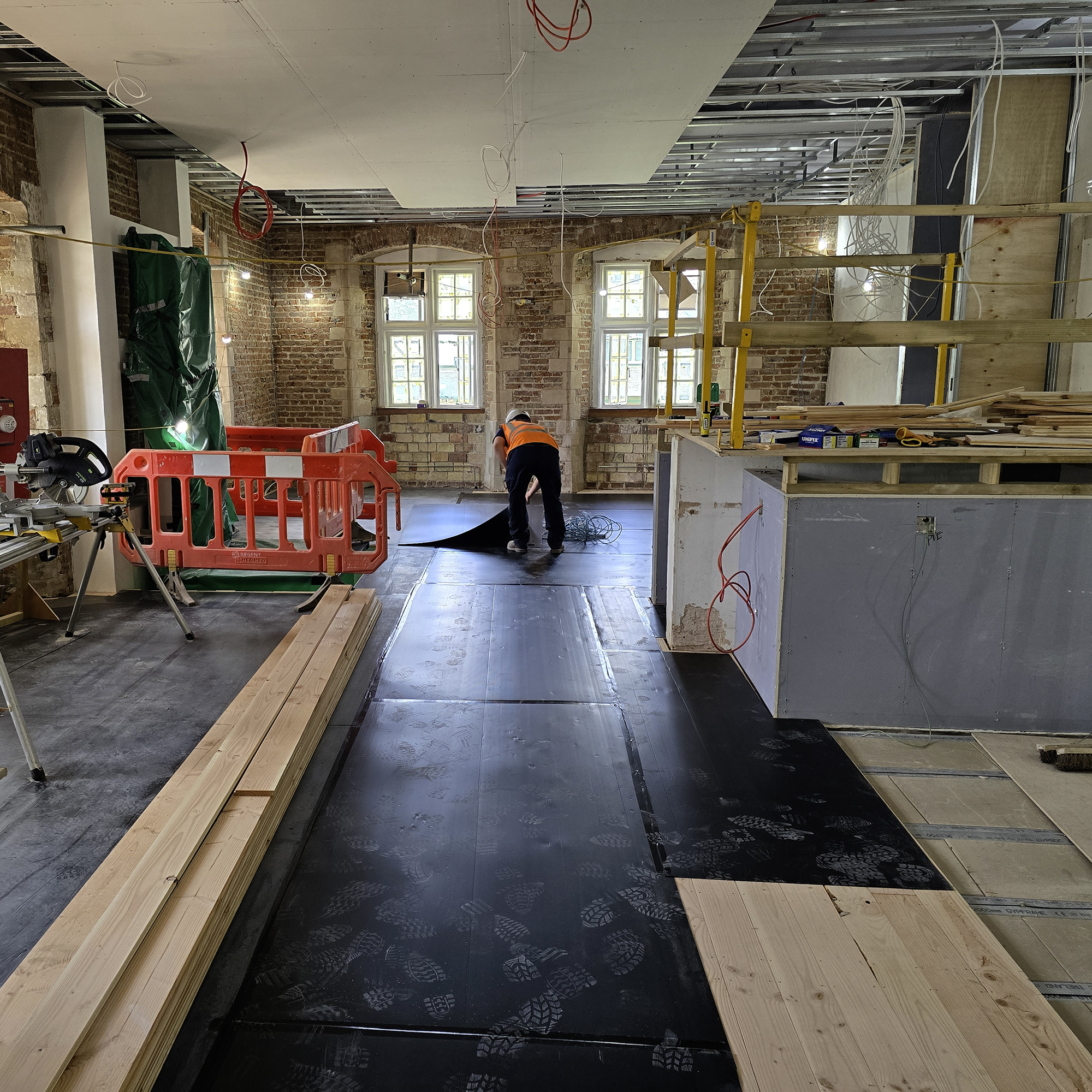

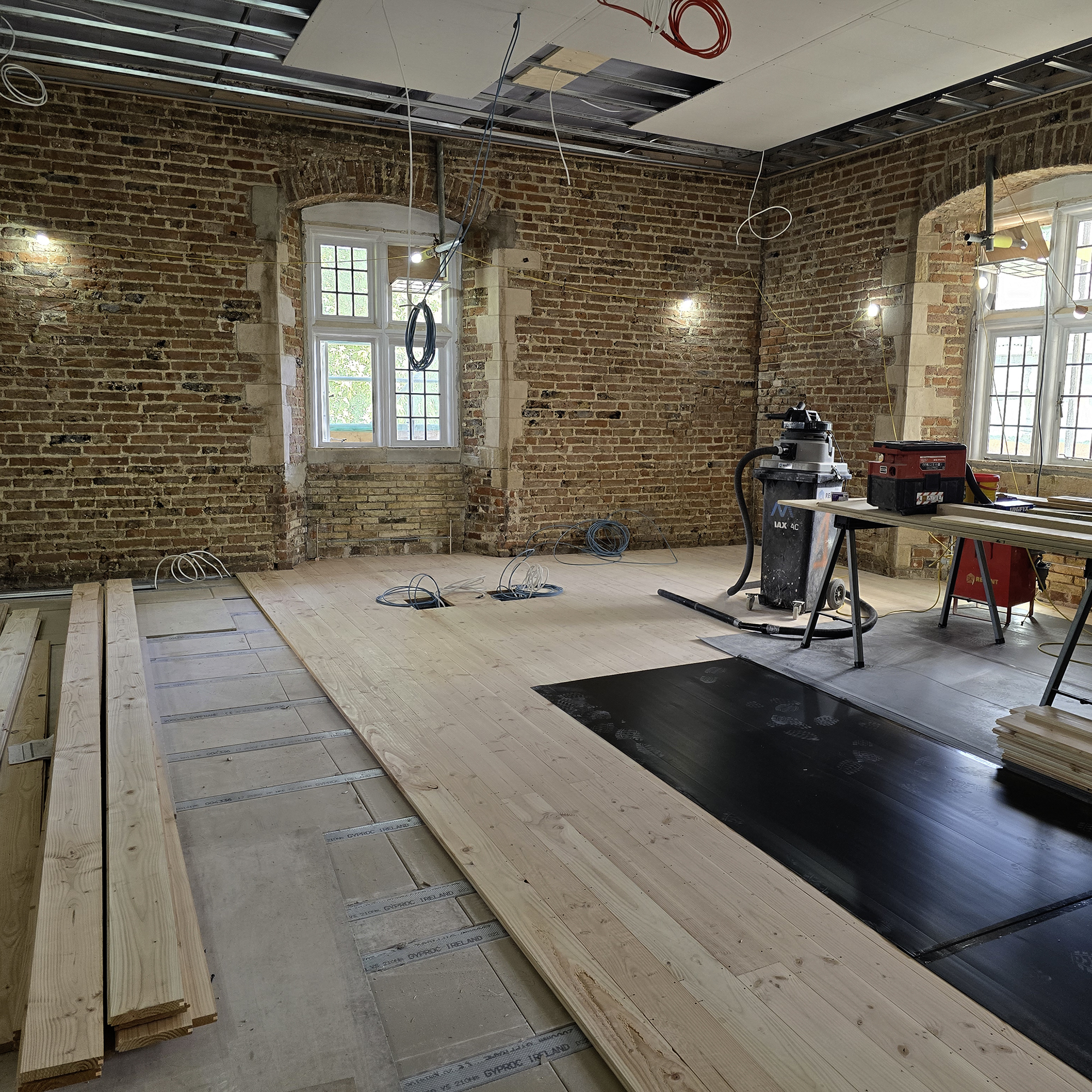

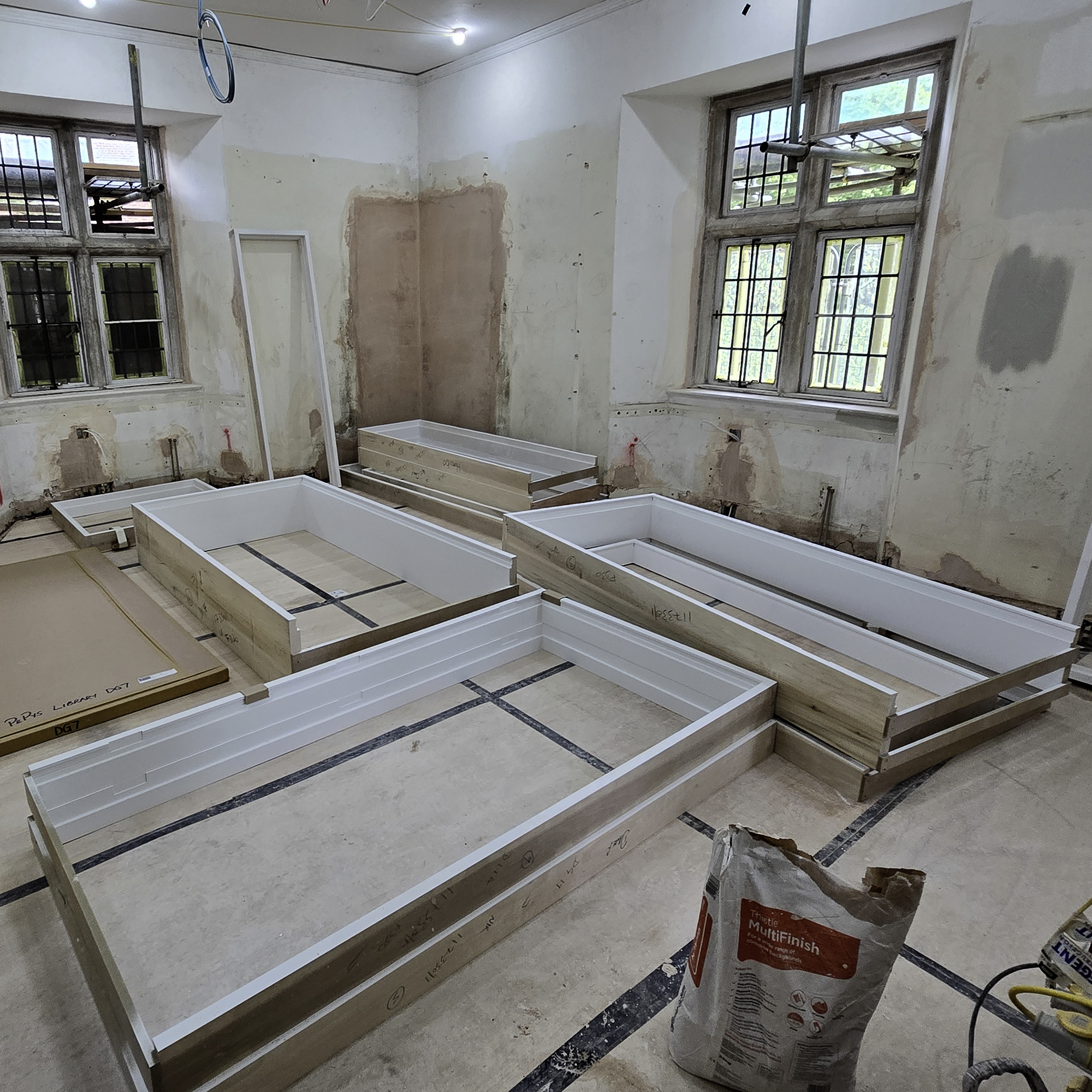

Boarding work is taking place in the Pepys Library, providing a protective surface and safe access while preparations are made for the installation of a new floating ceiling.
November 2025

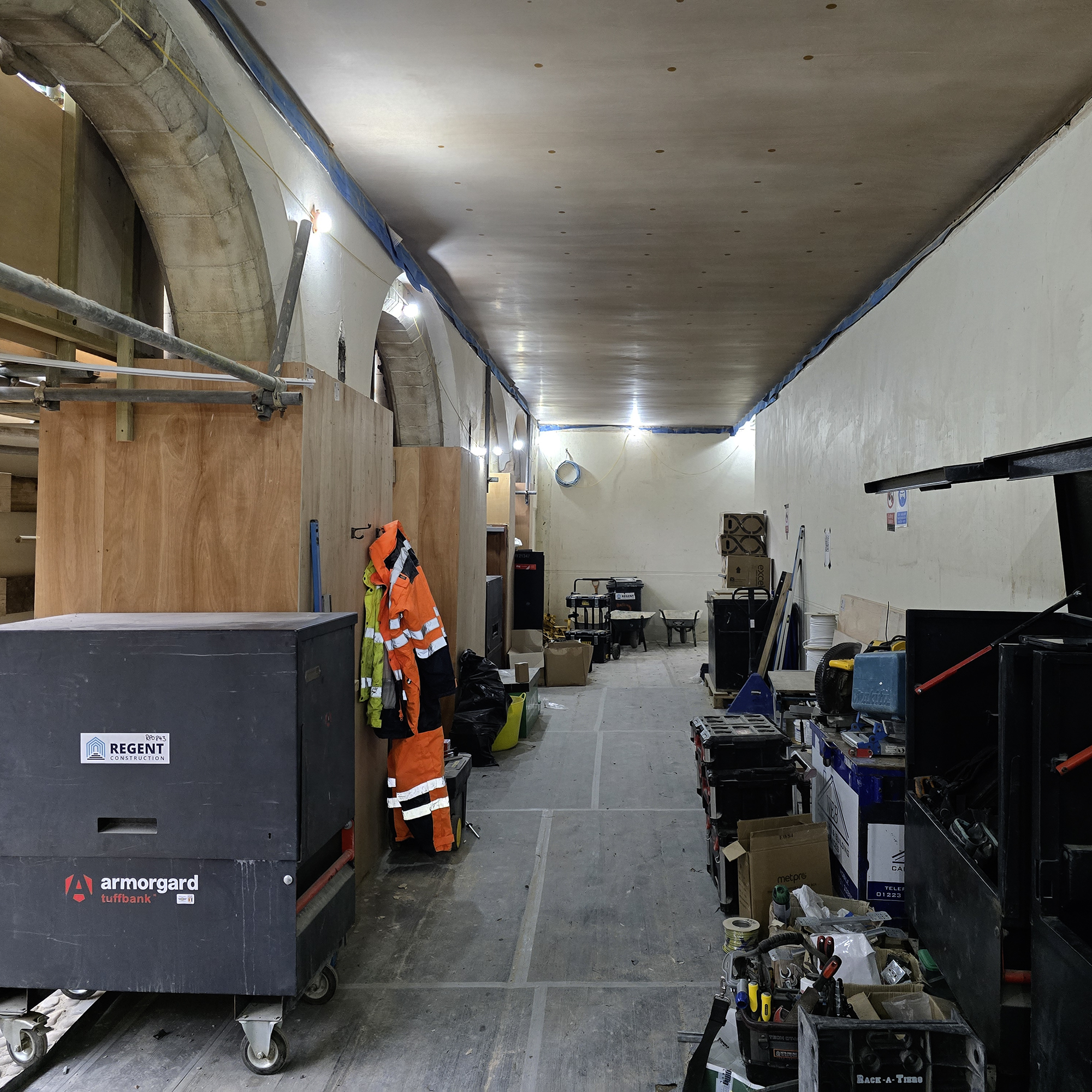

Boarding work is underway on the ground floor of the Left Cloister, preparing the space for upcoming construction and restoration activities.
October 2025

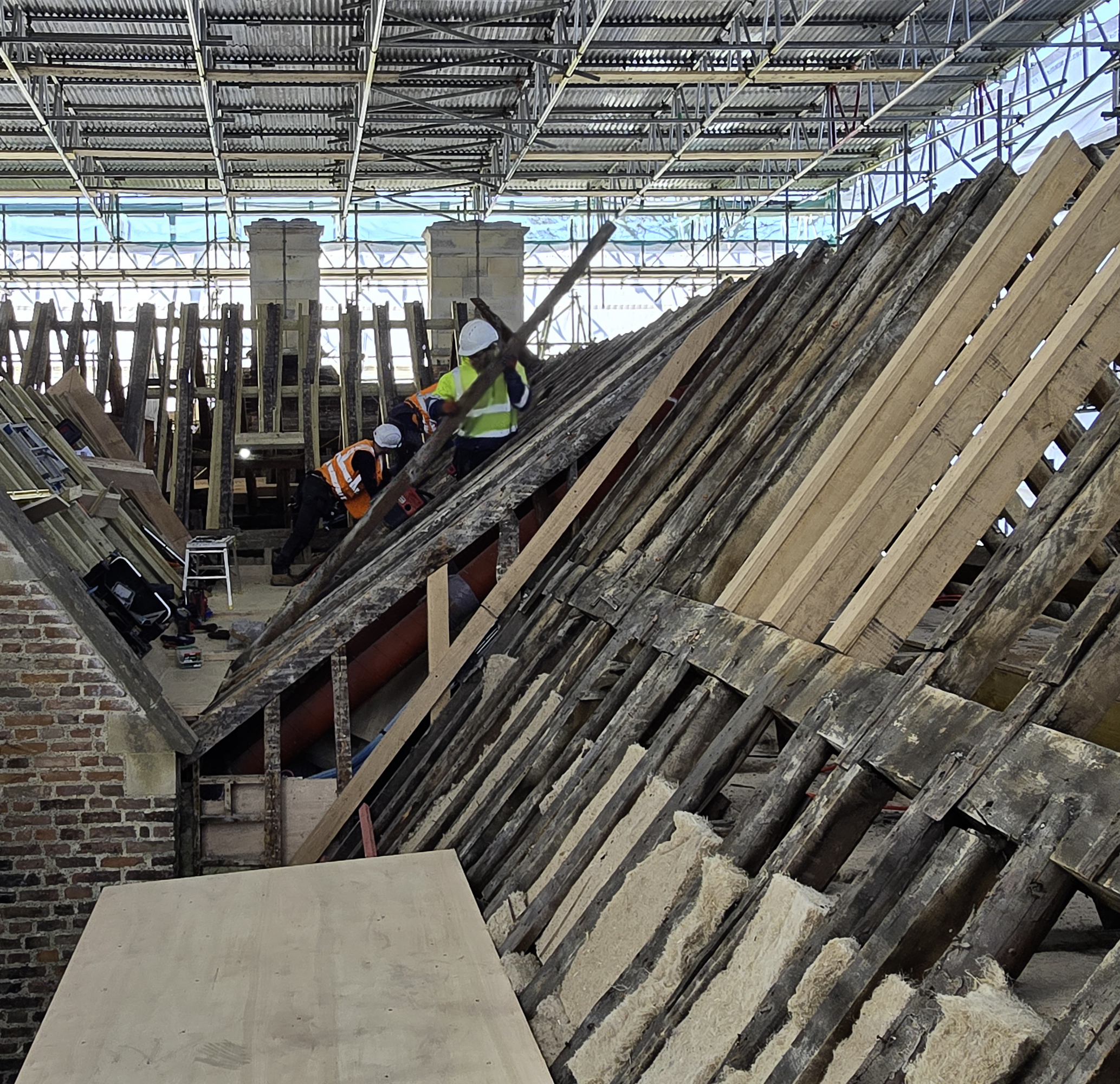

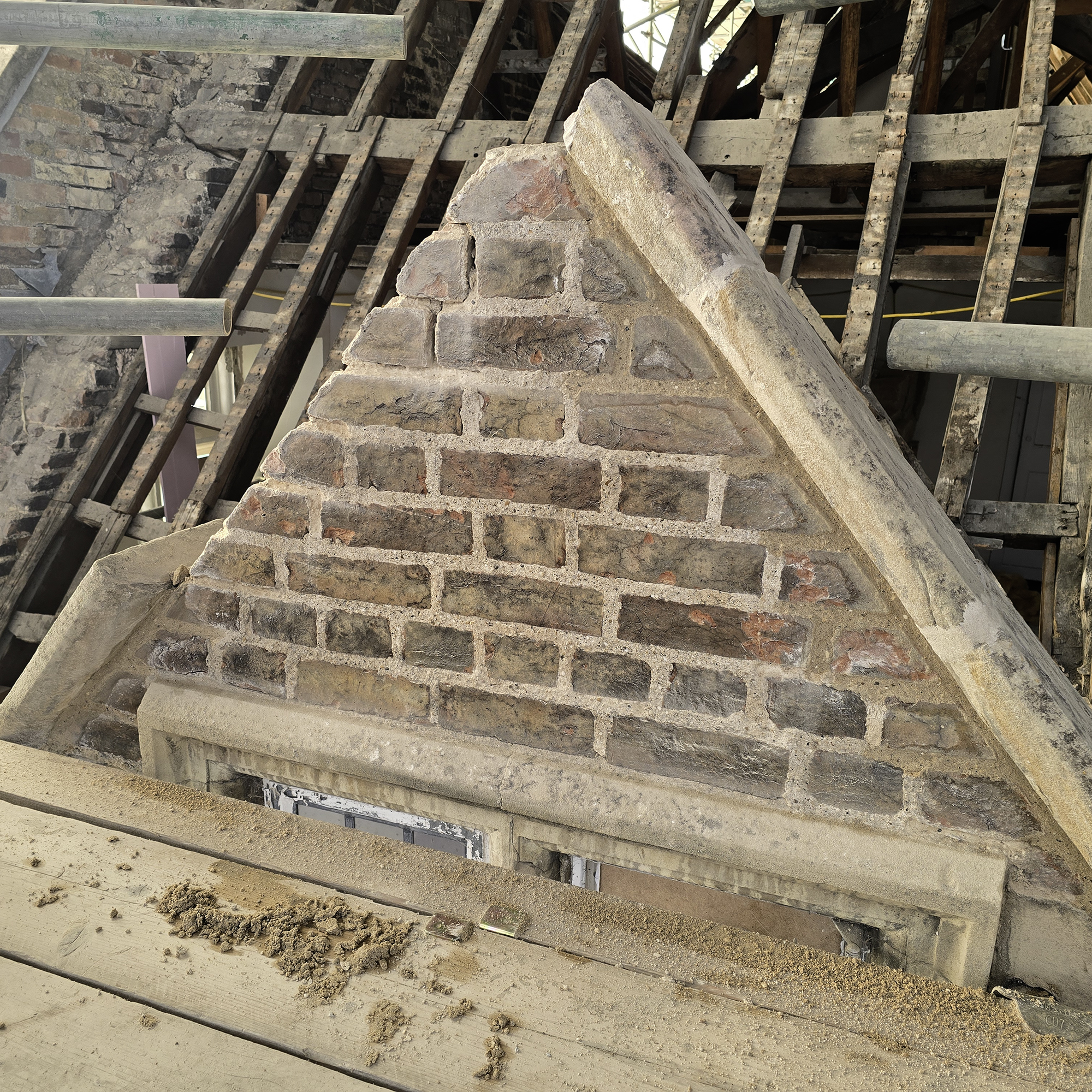

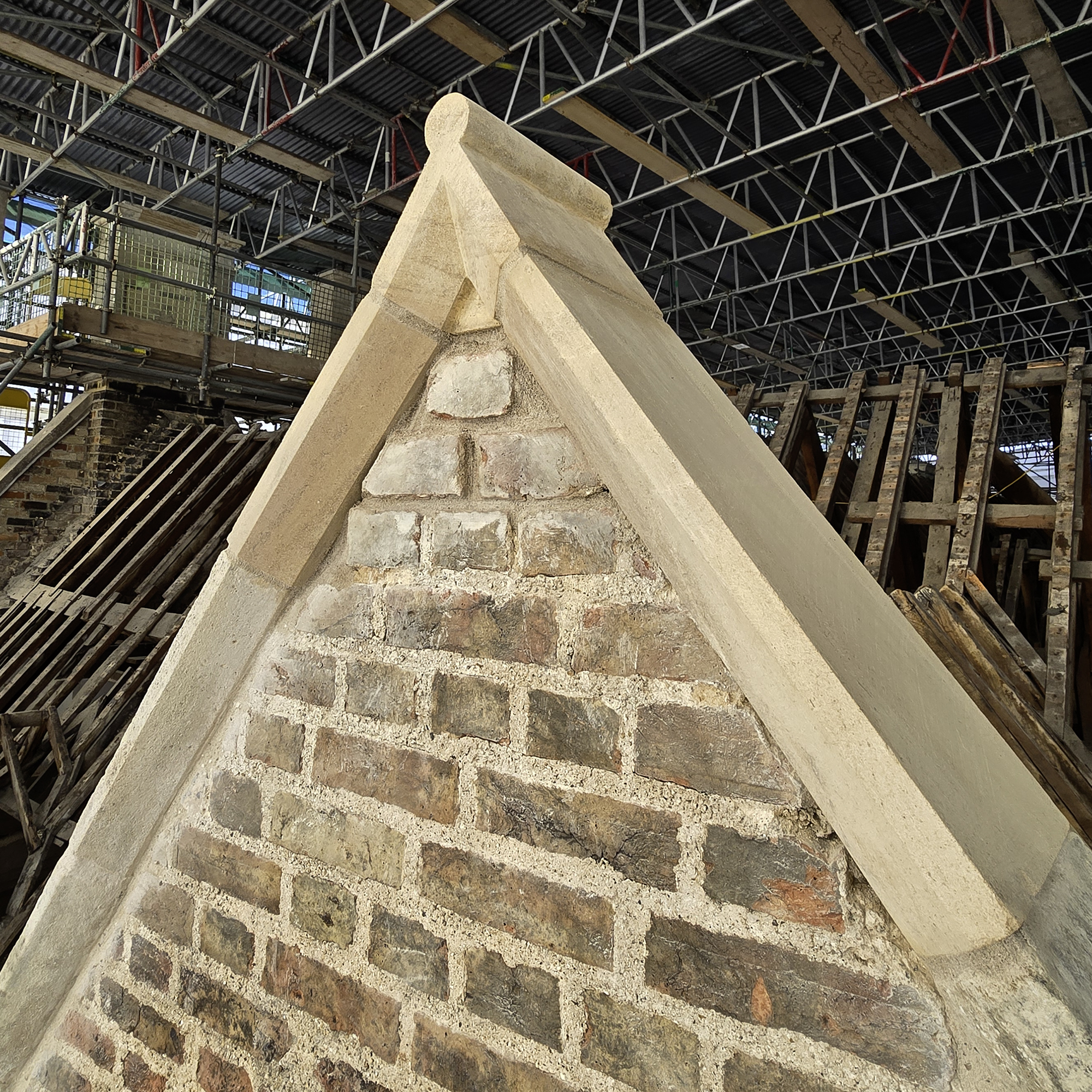

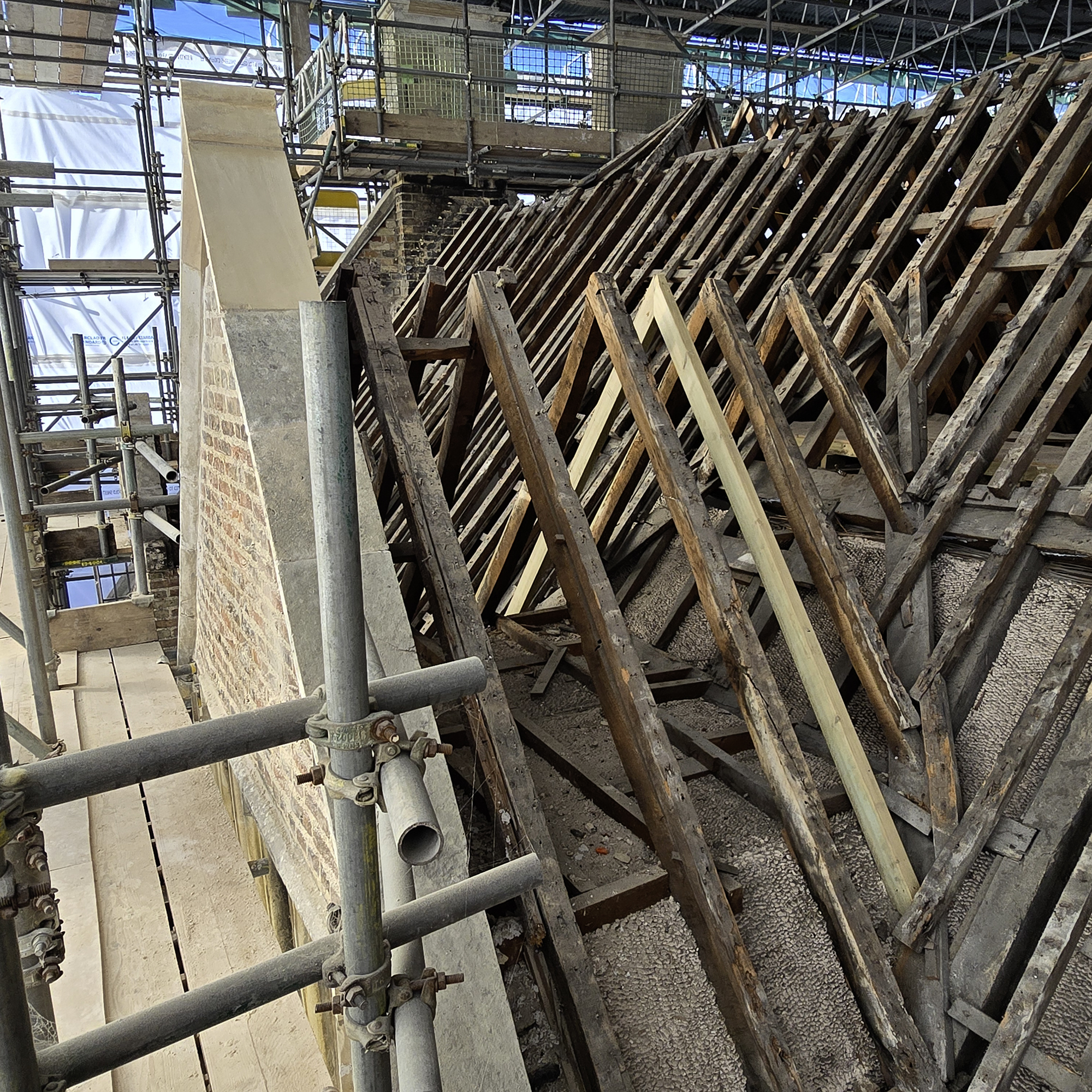

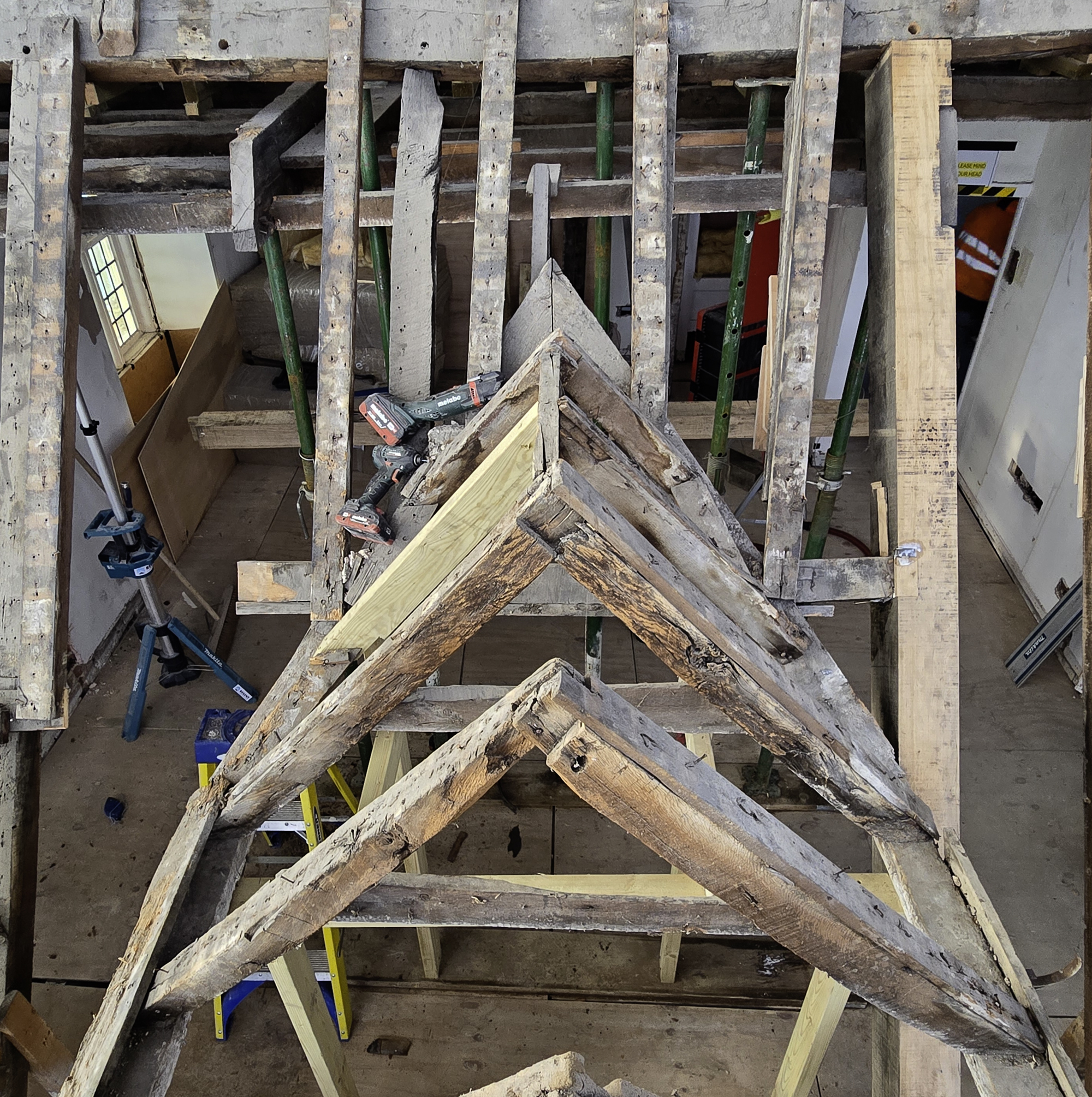

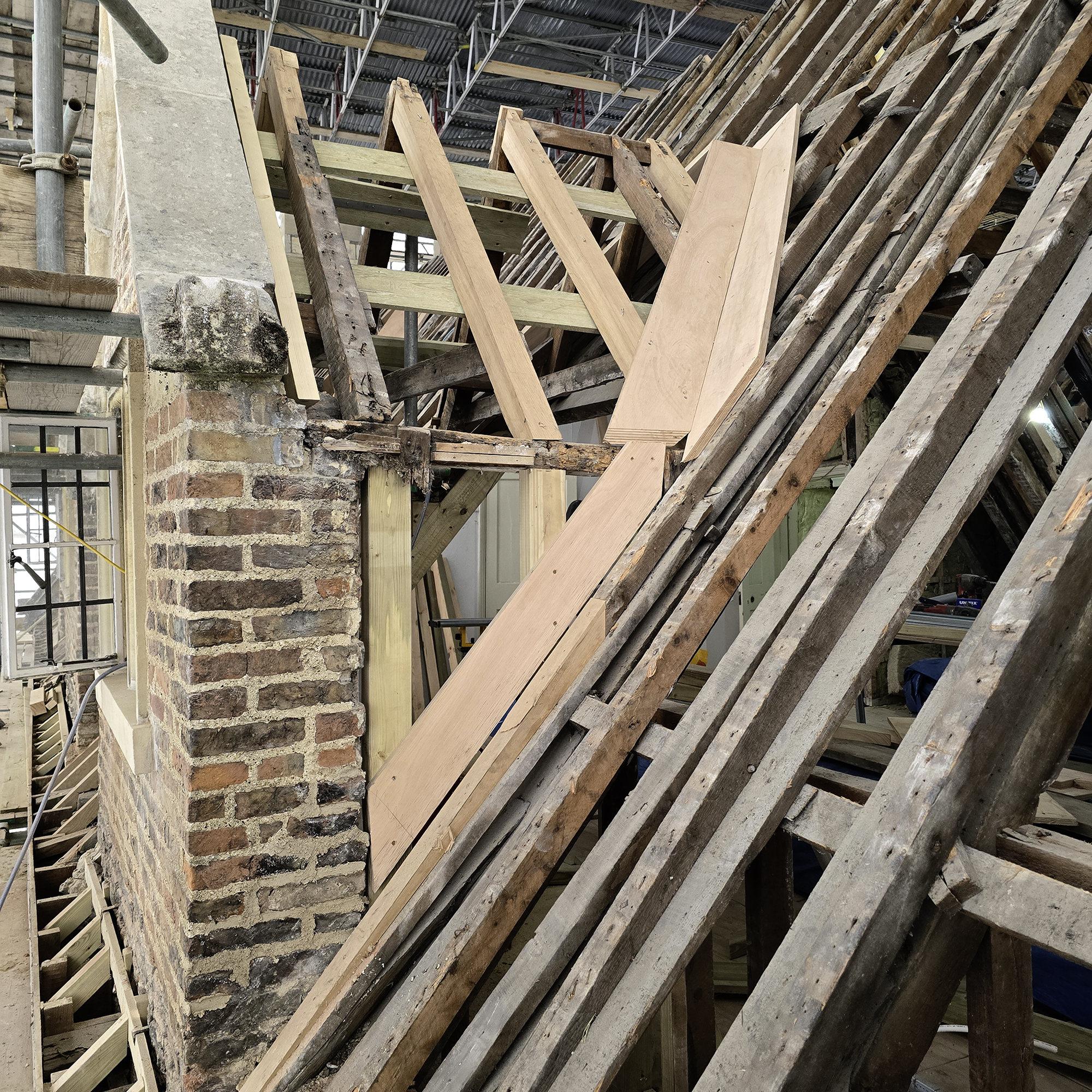

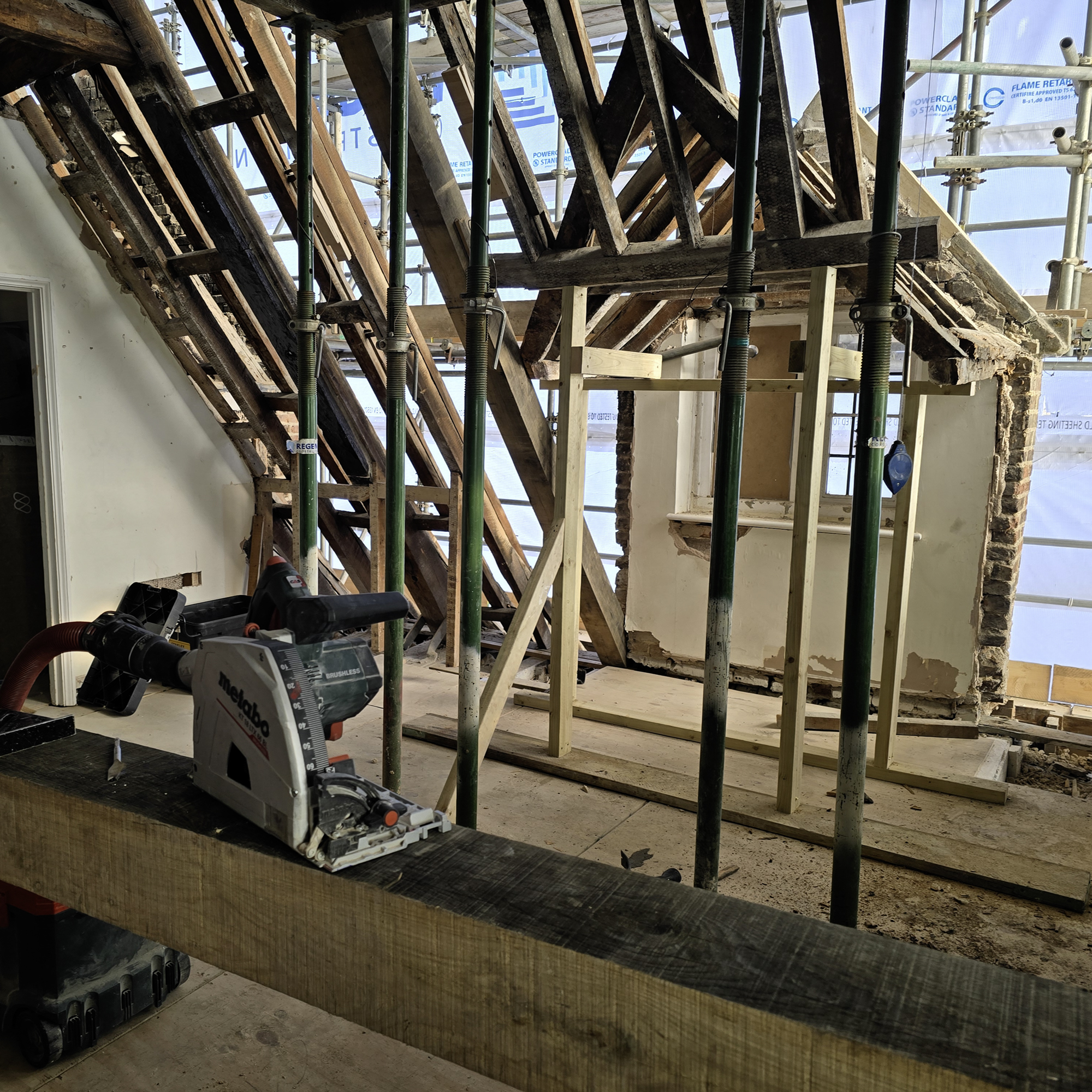

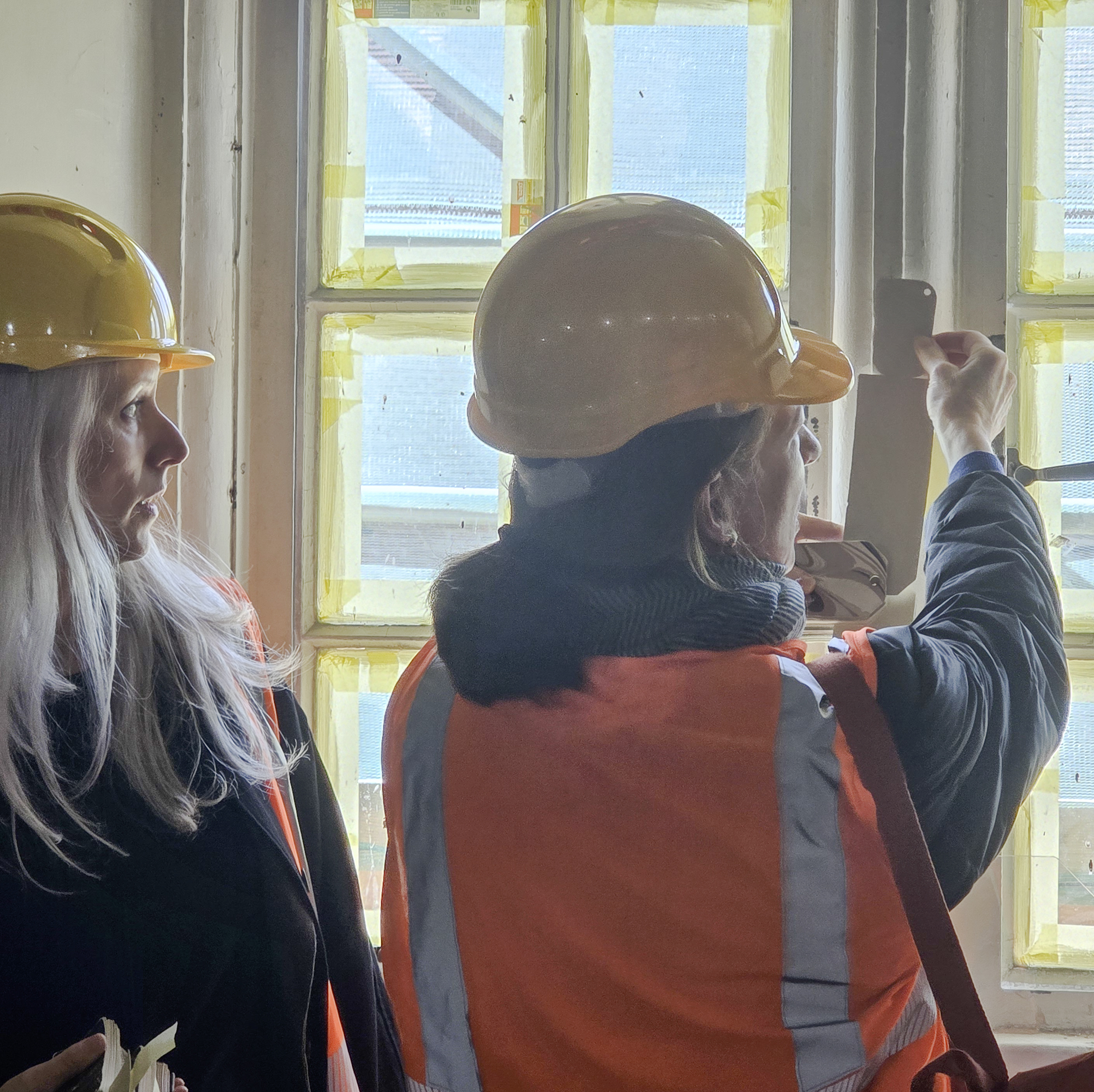

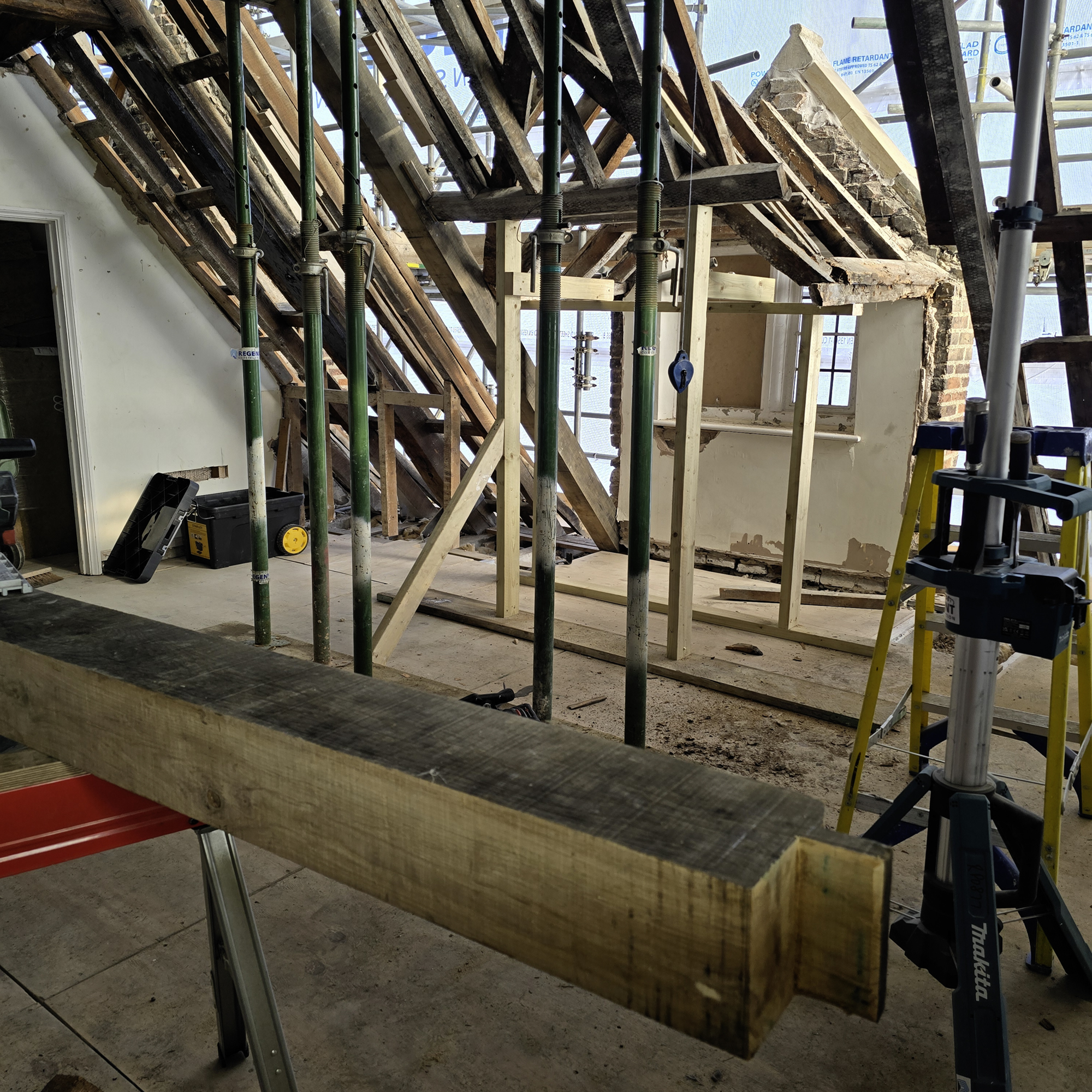

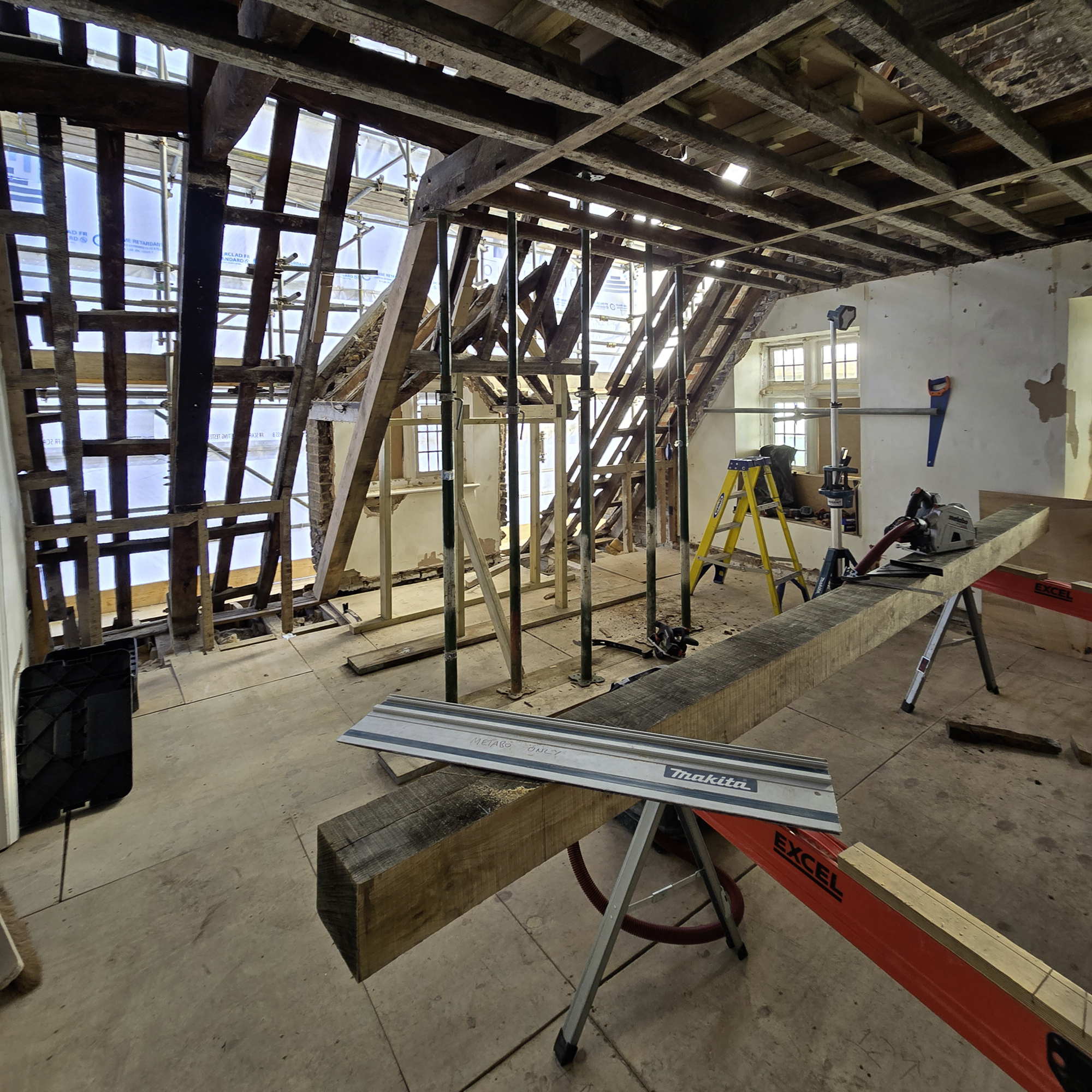

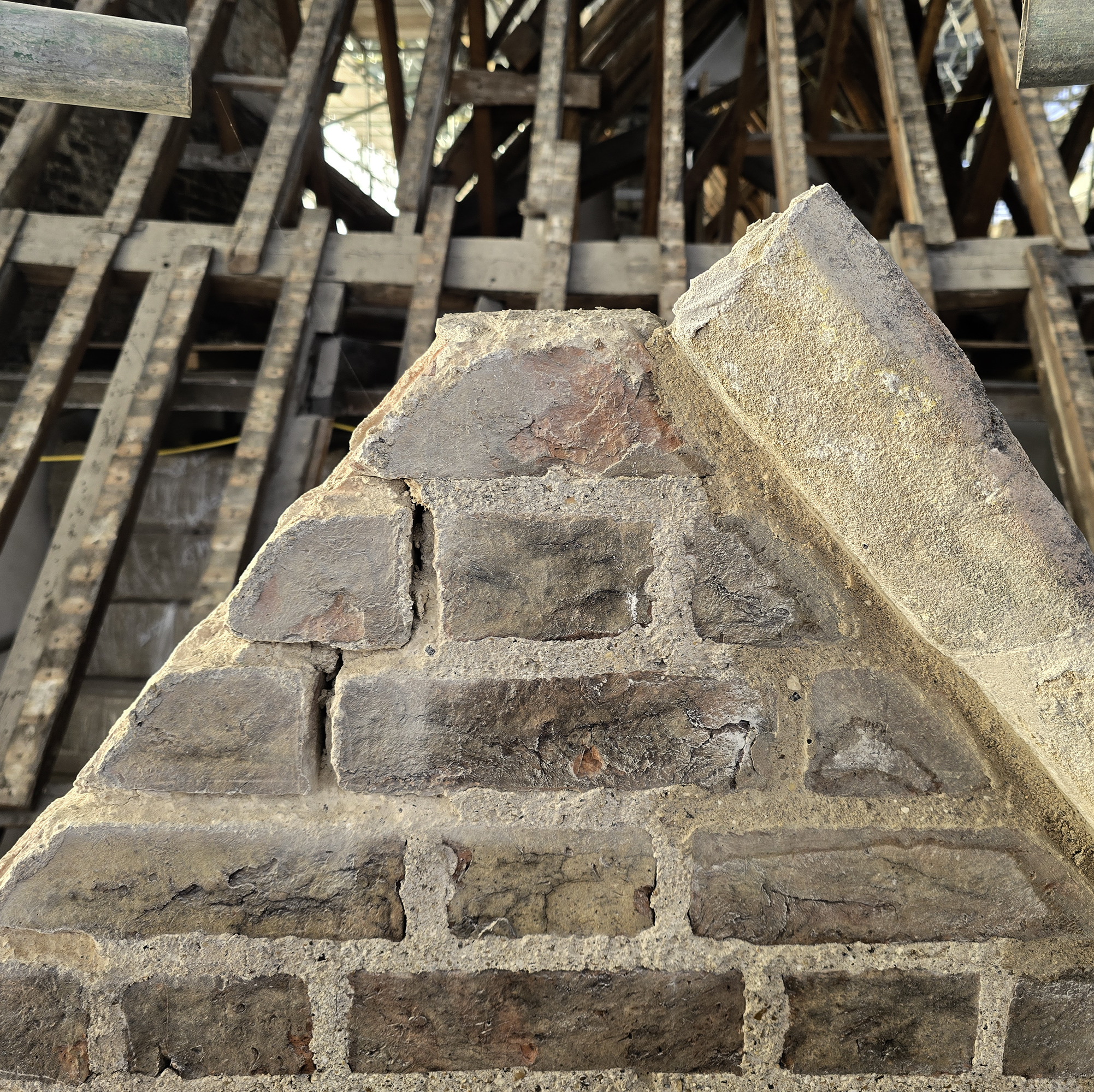

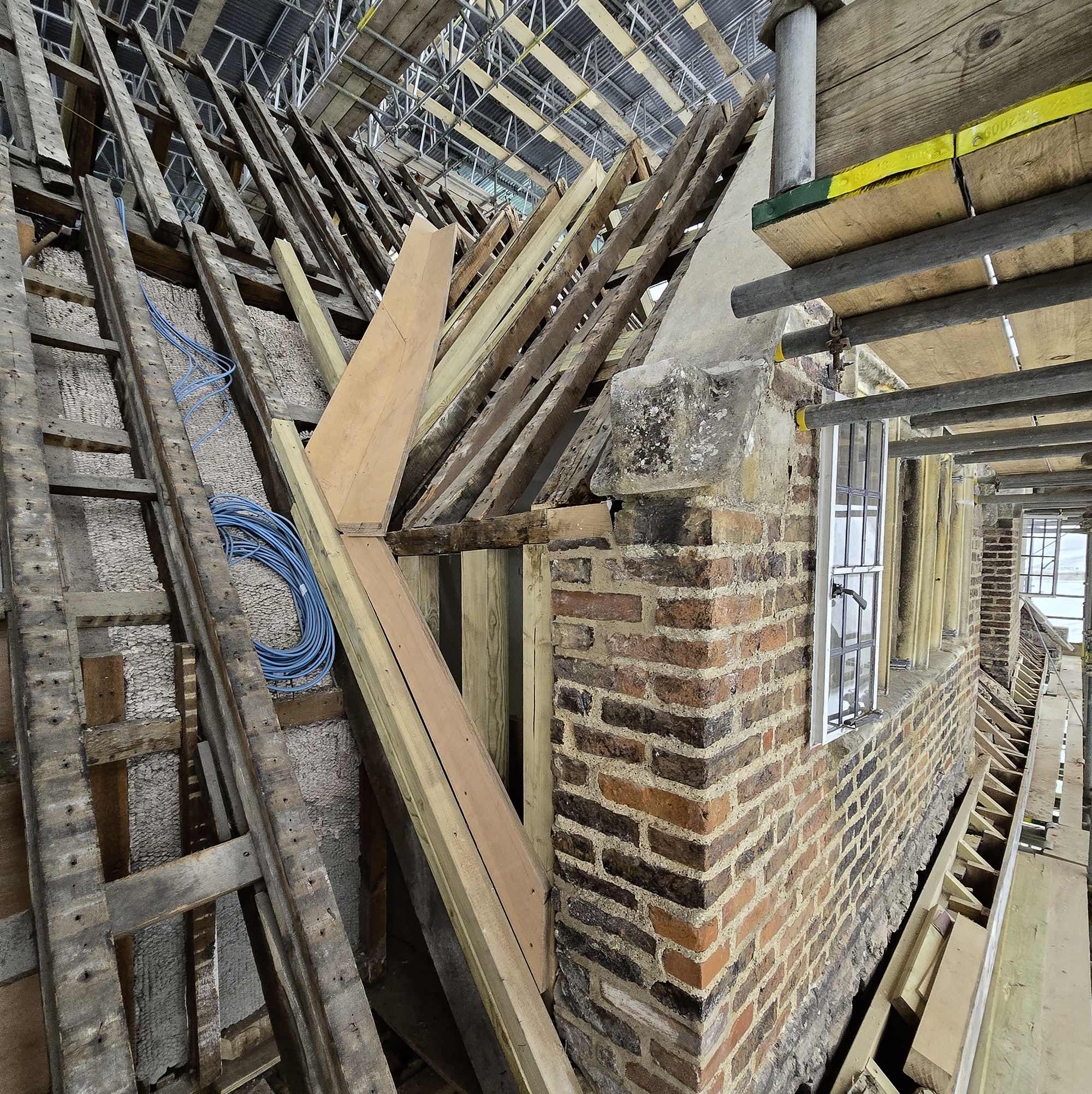

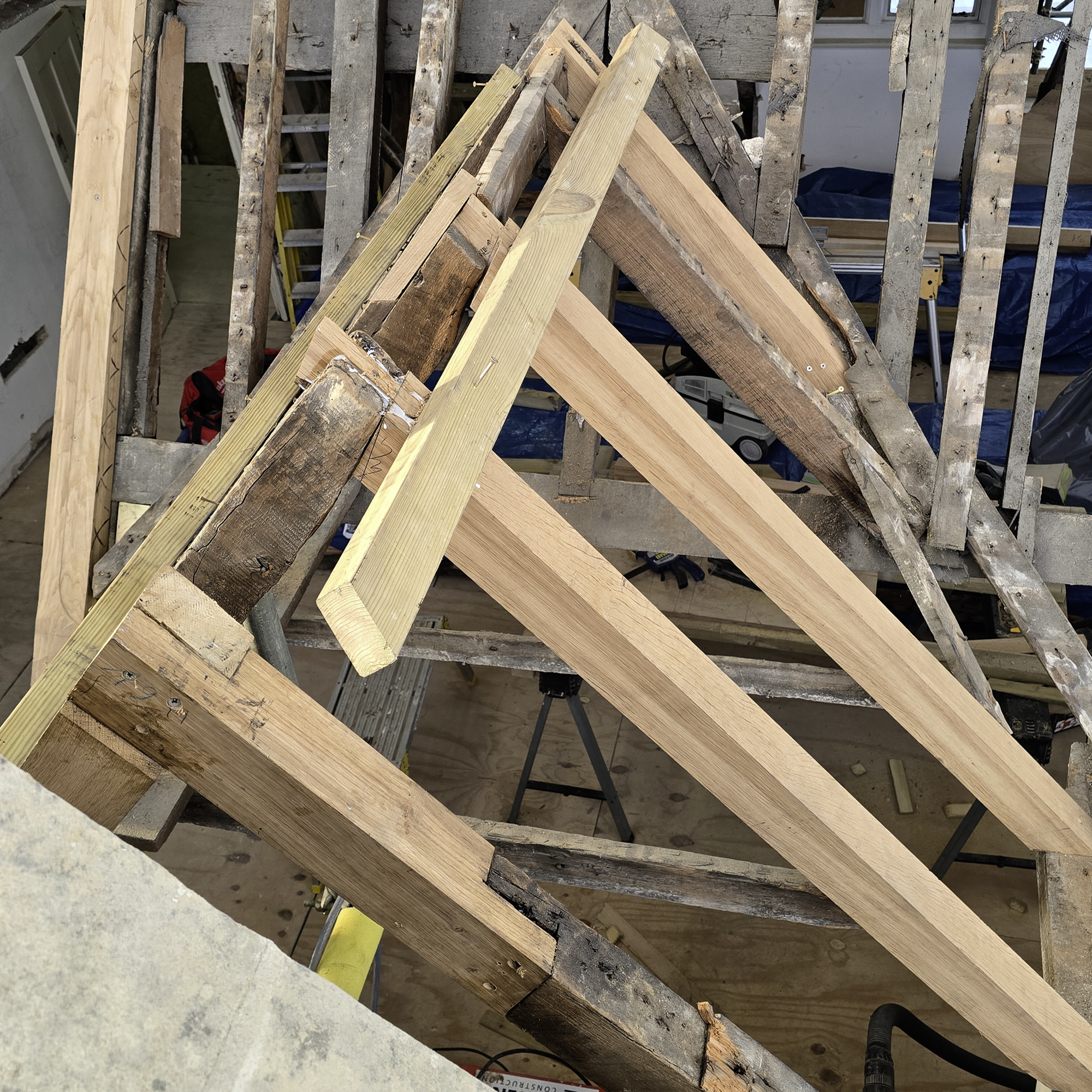

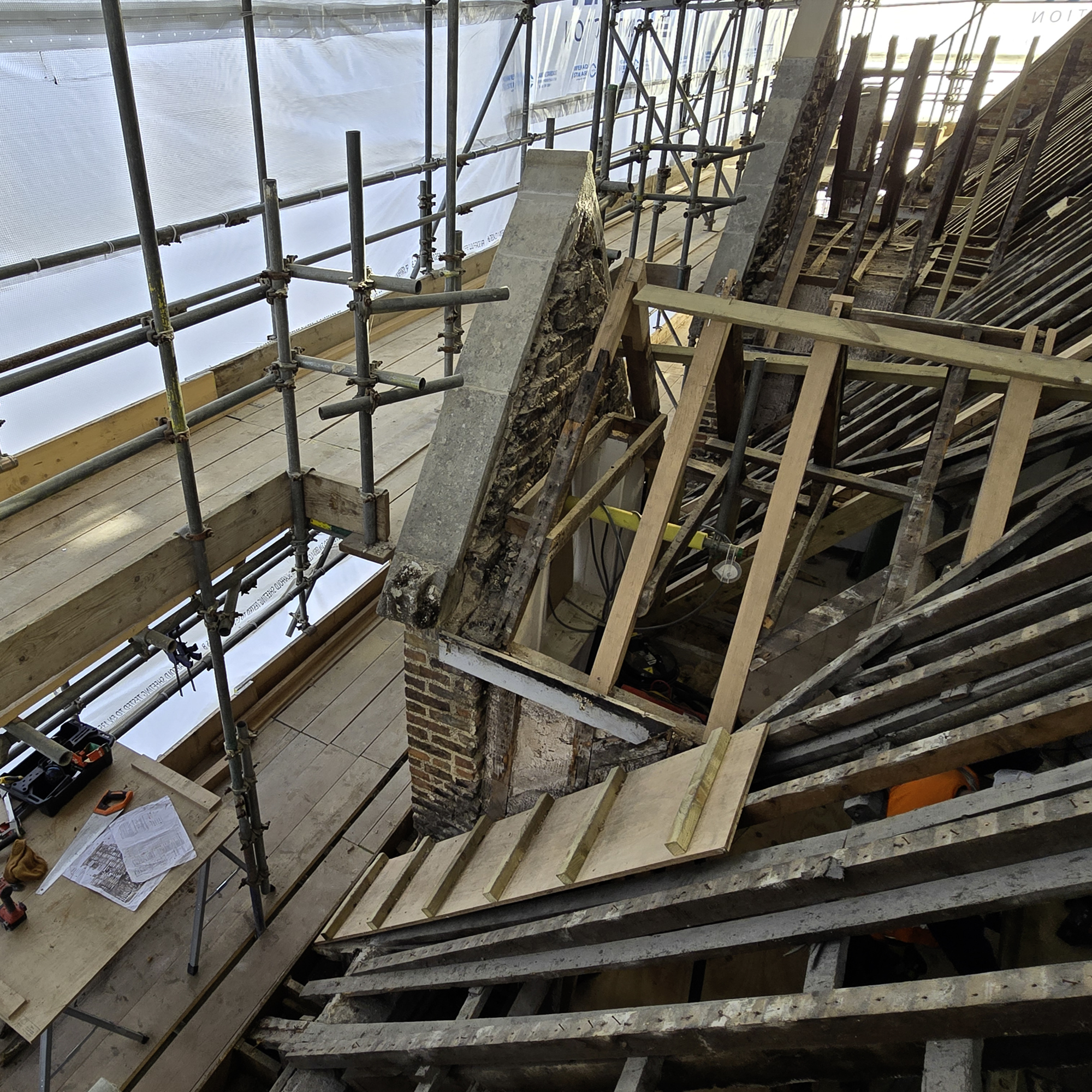

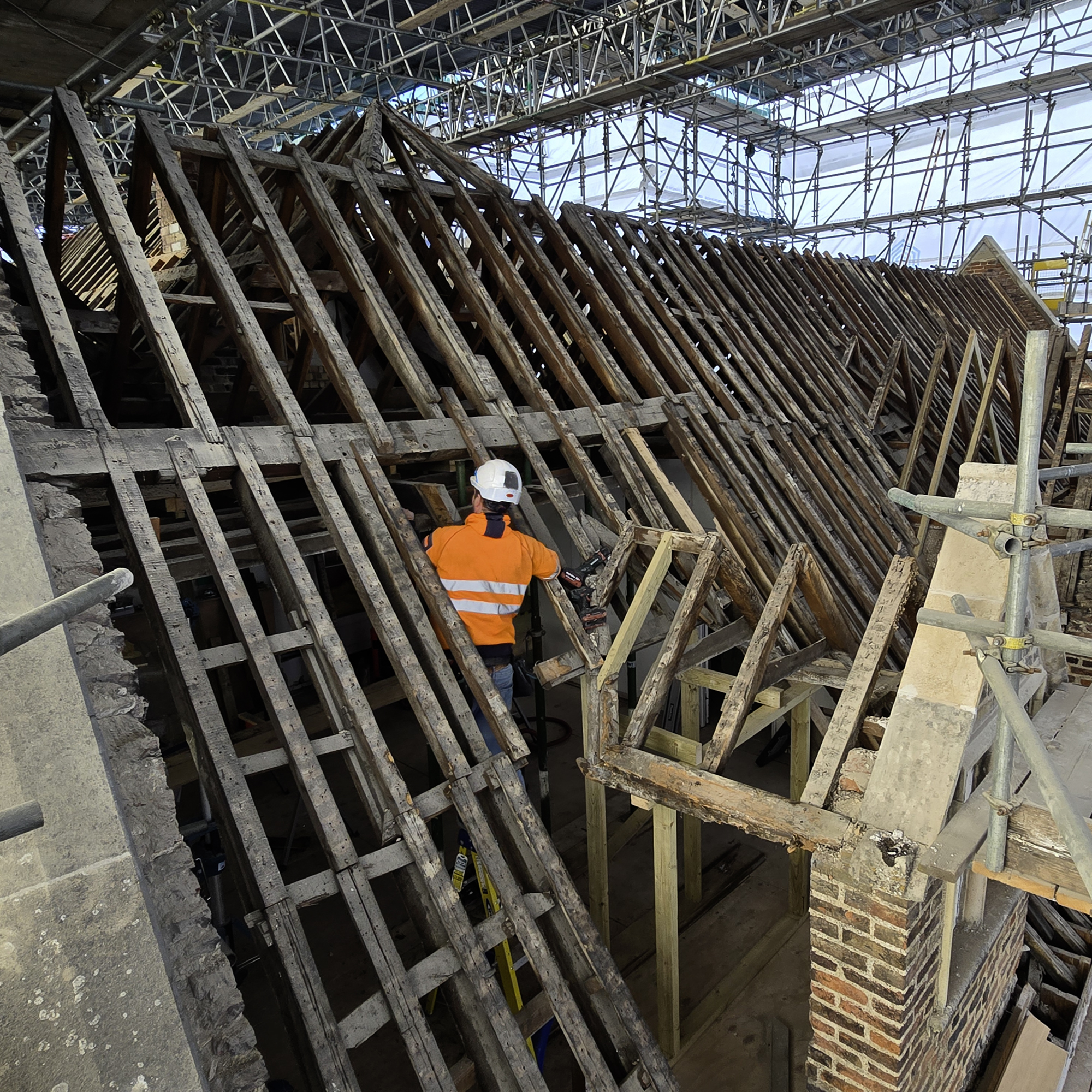

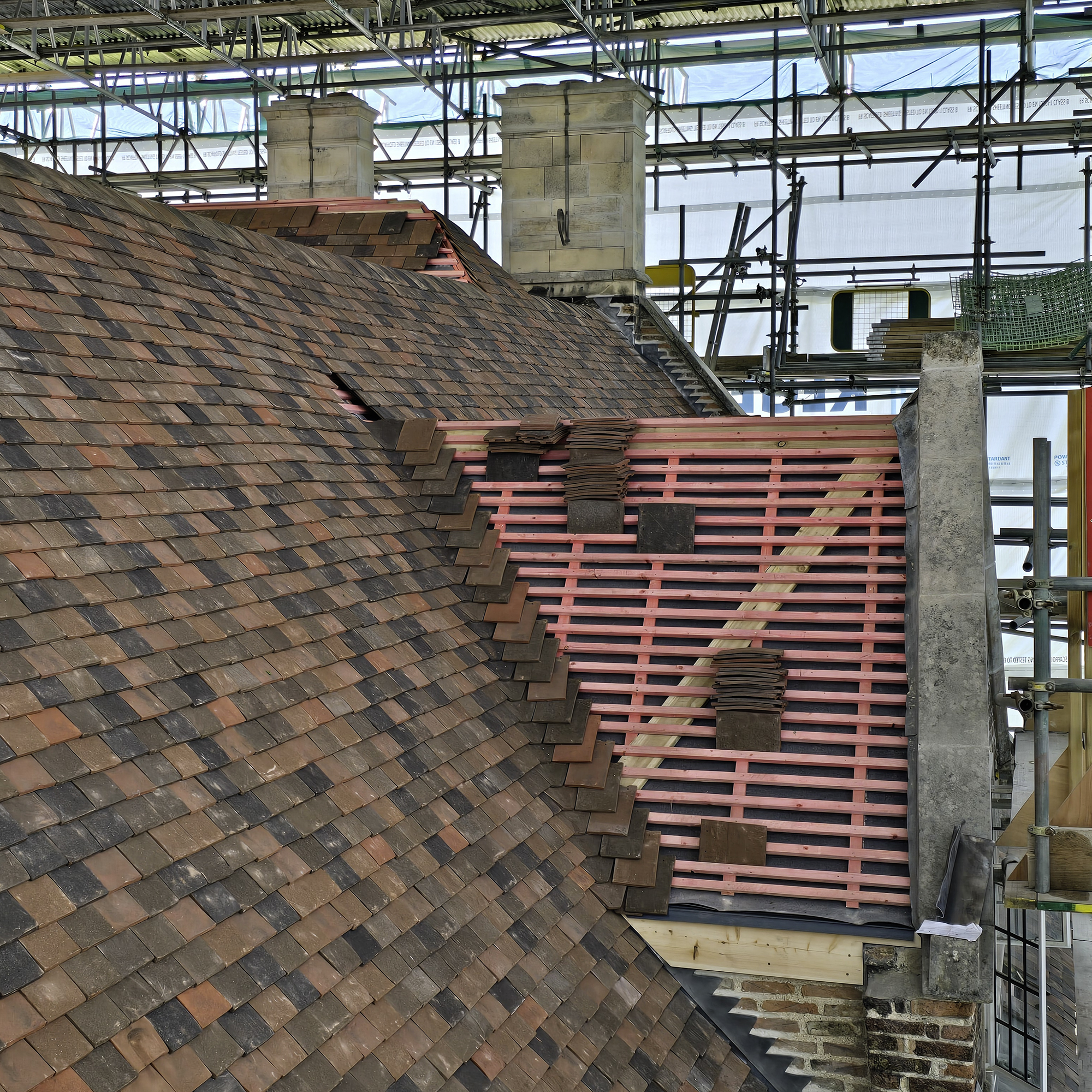

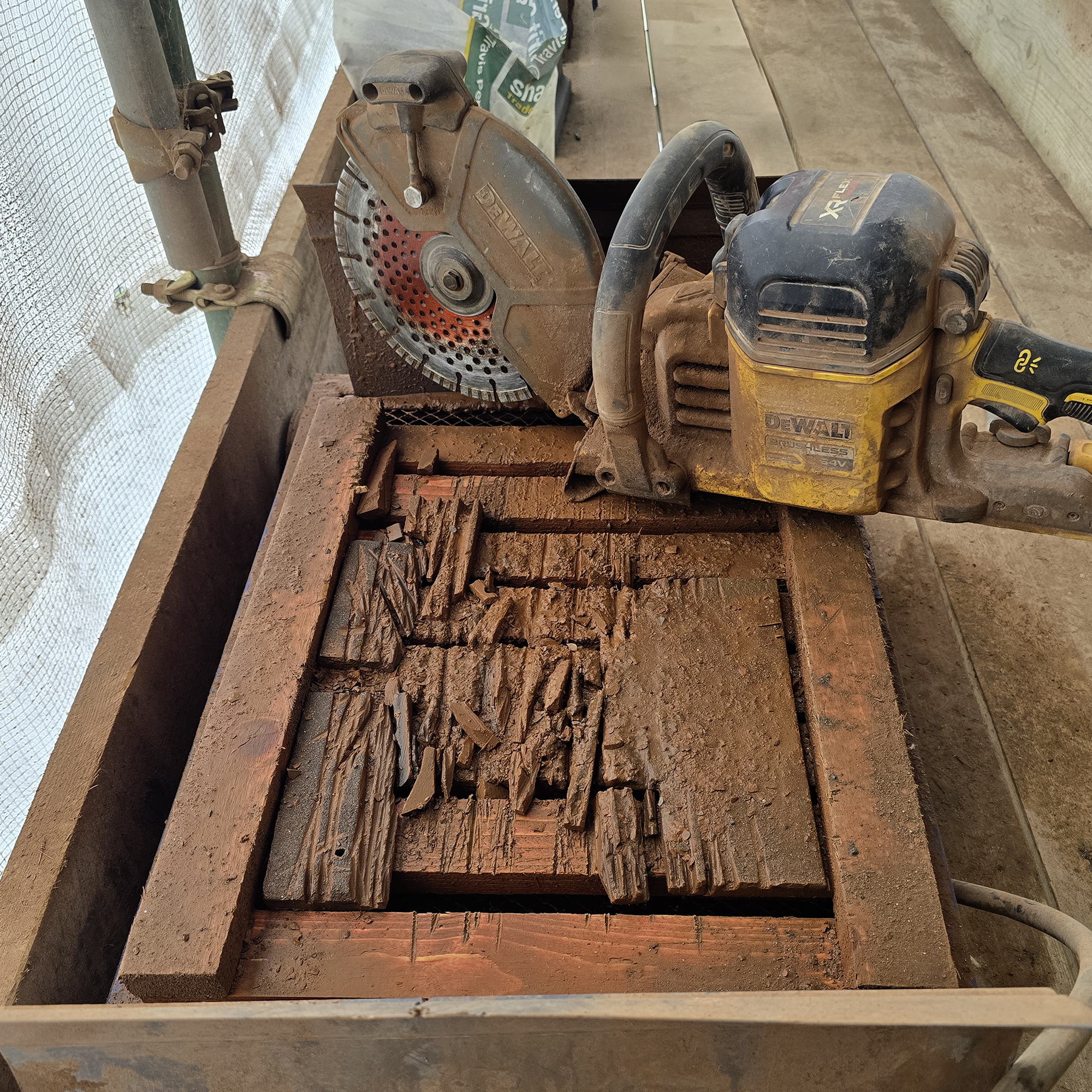

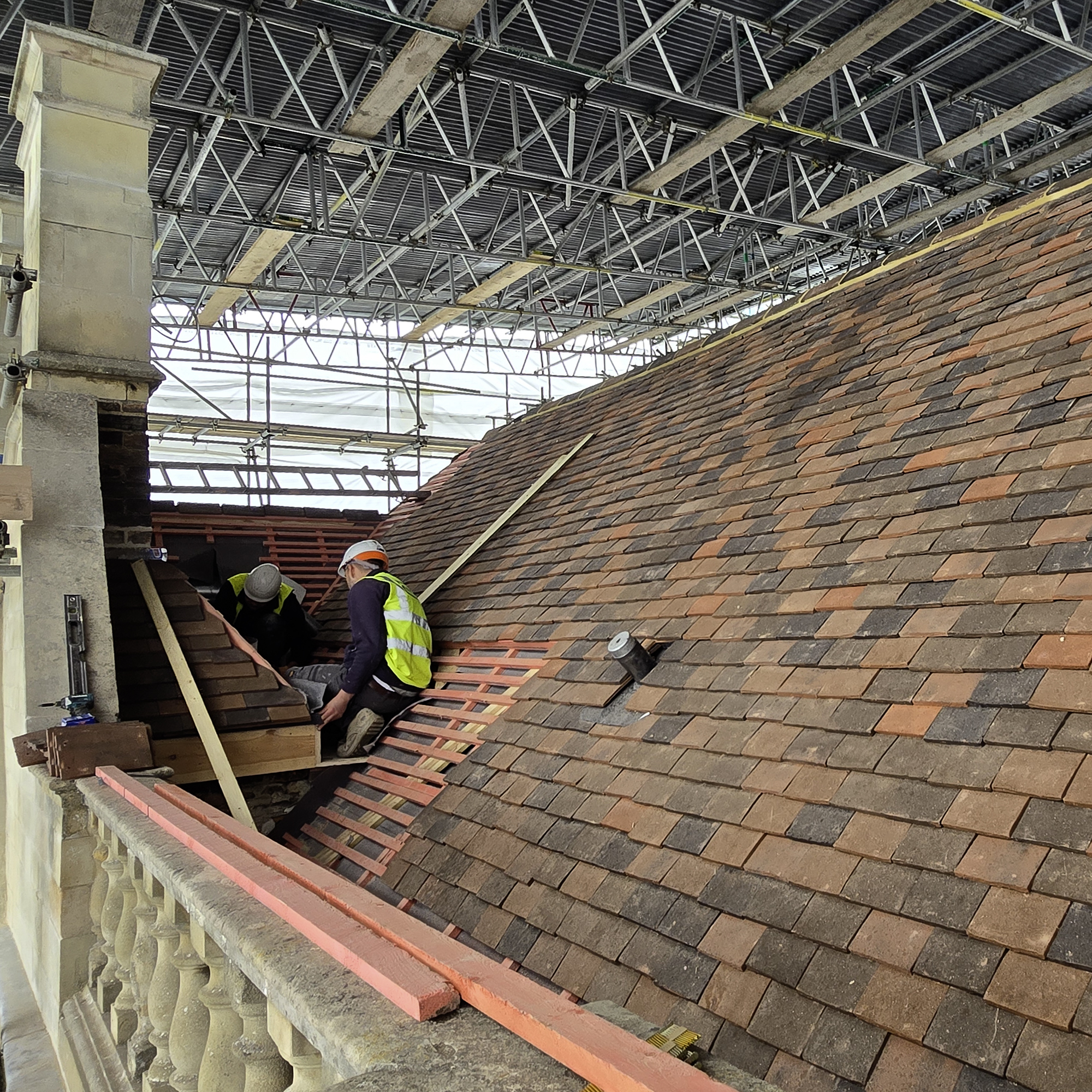

The roof has now been completely stripped back. Dendrochronological and wood surveys are underway to determine the age, origin, and structural condition of the beams. The findings will guide decisions on which beams require replacement.
October 2025

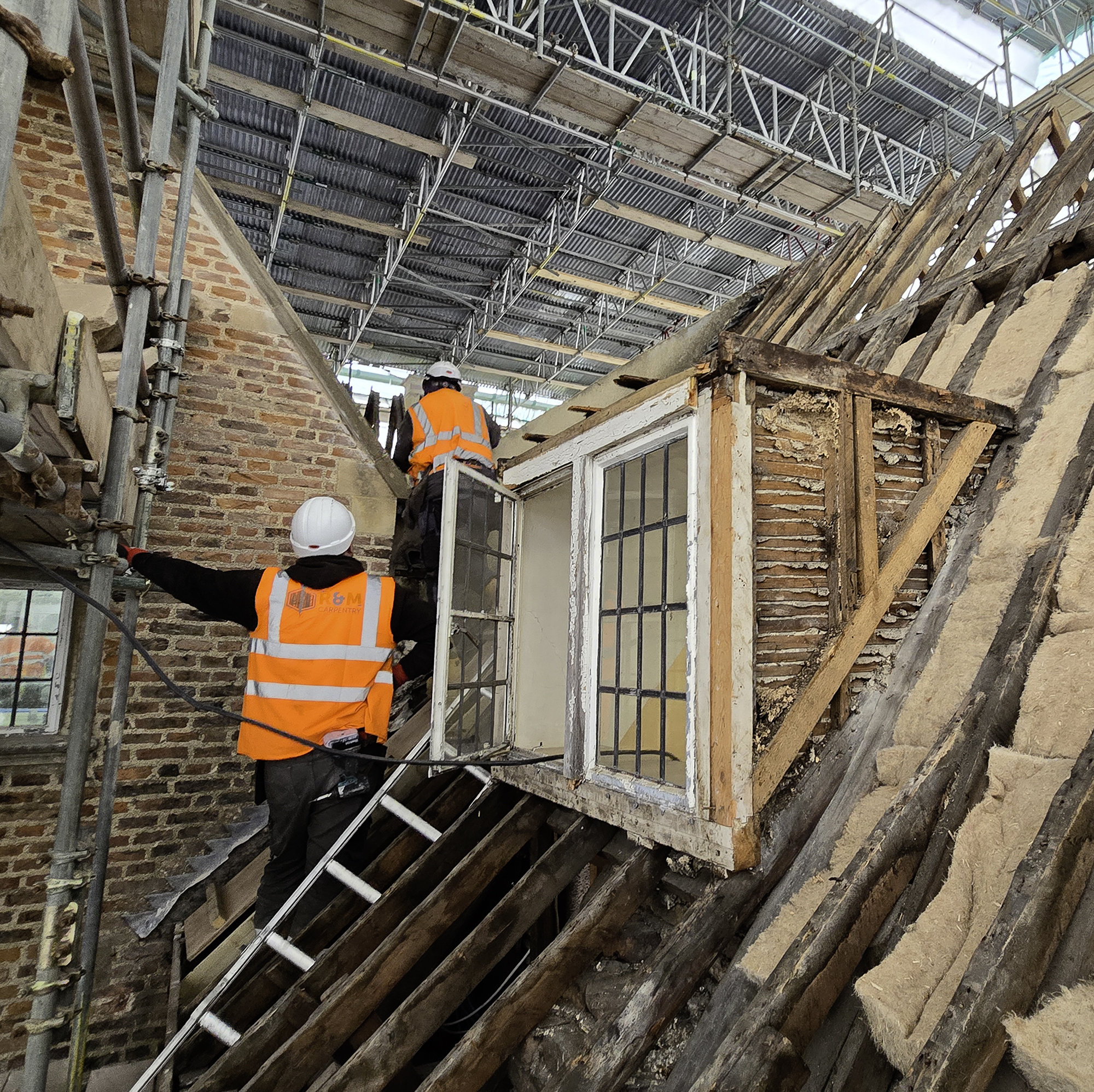

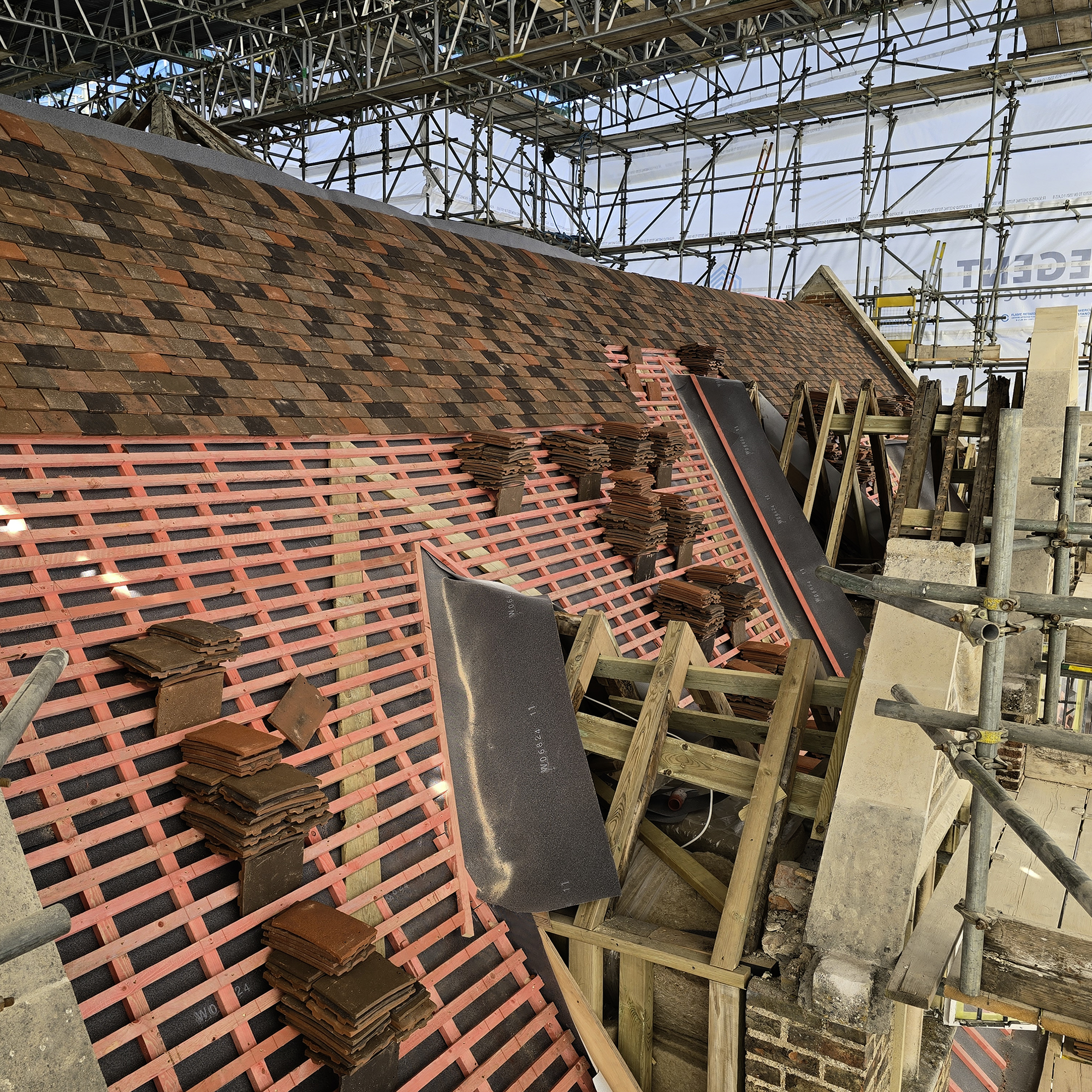

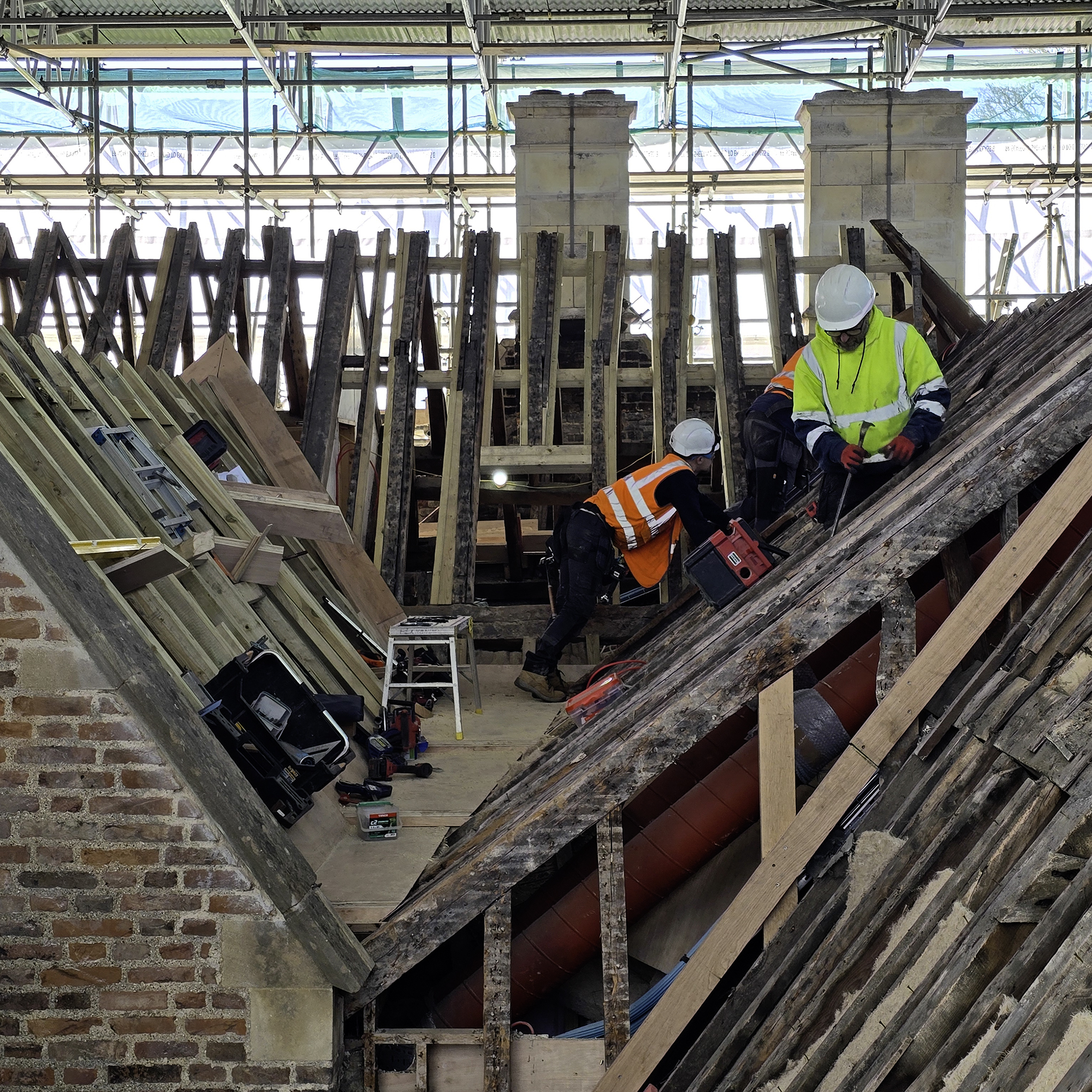

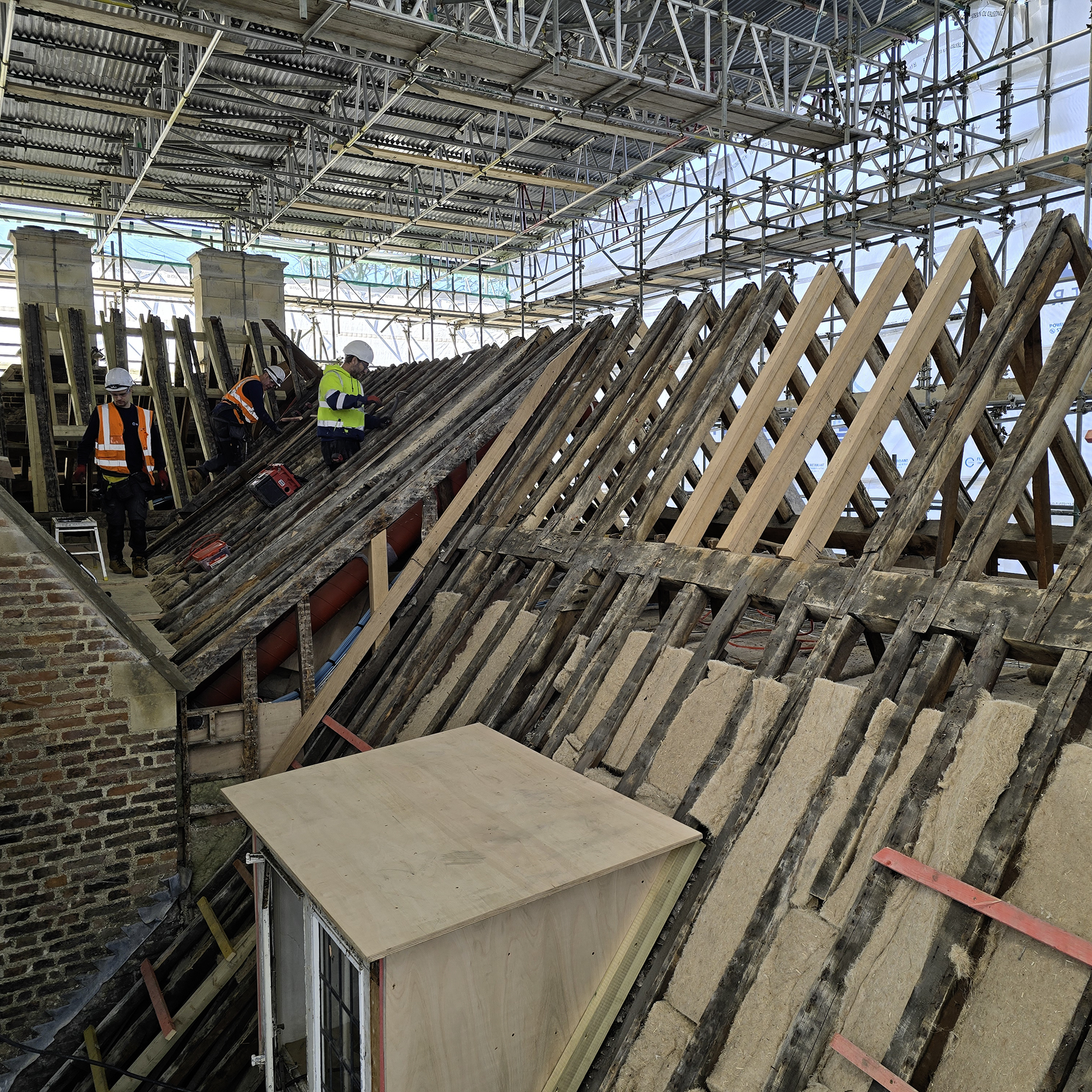

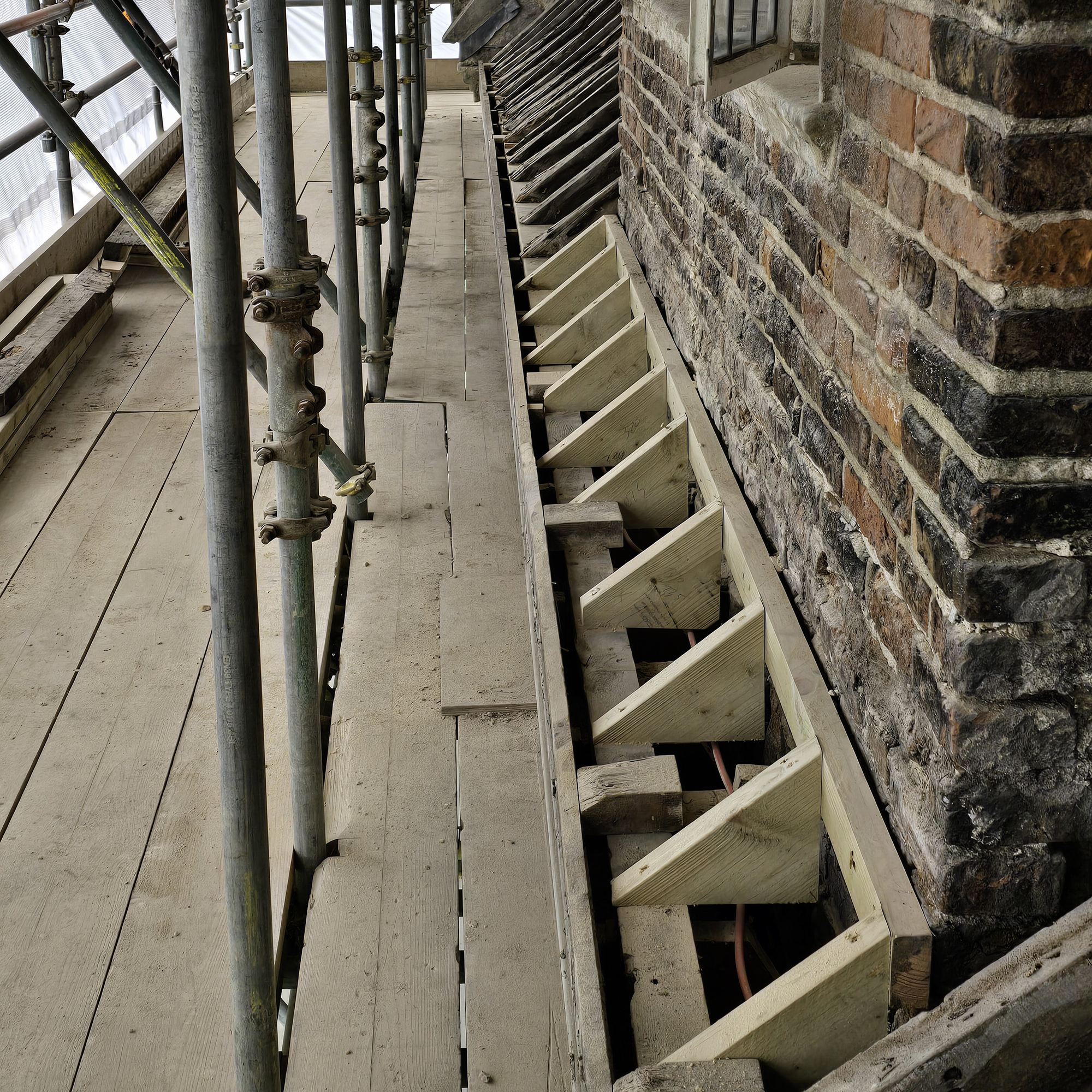

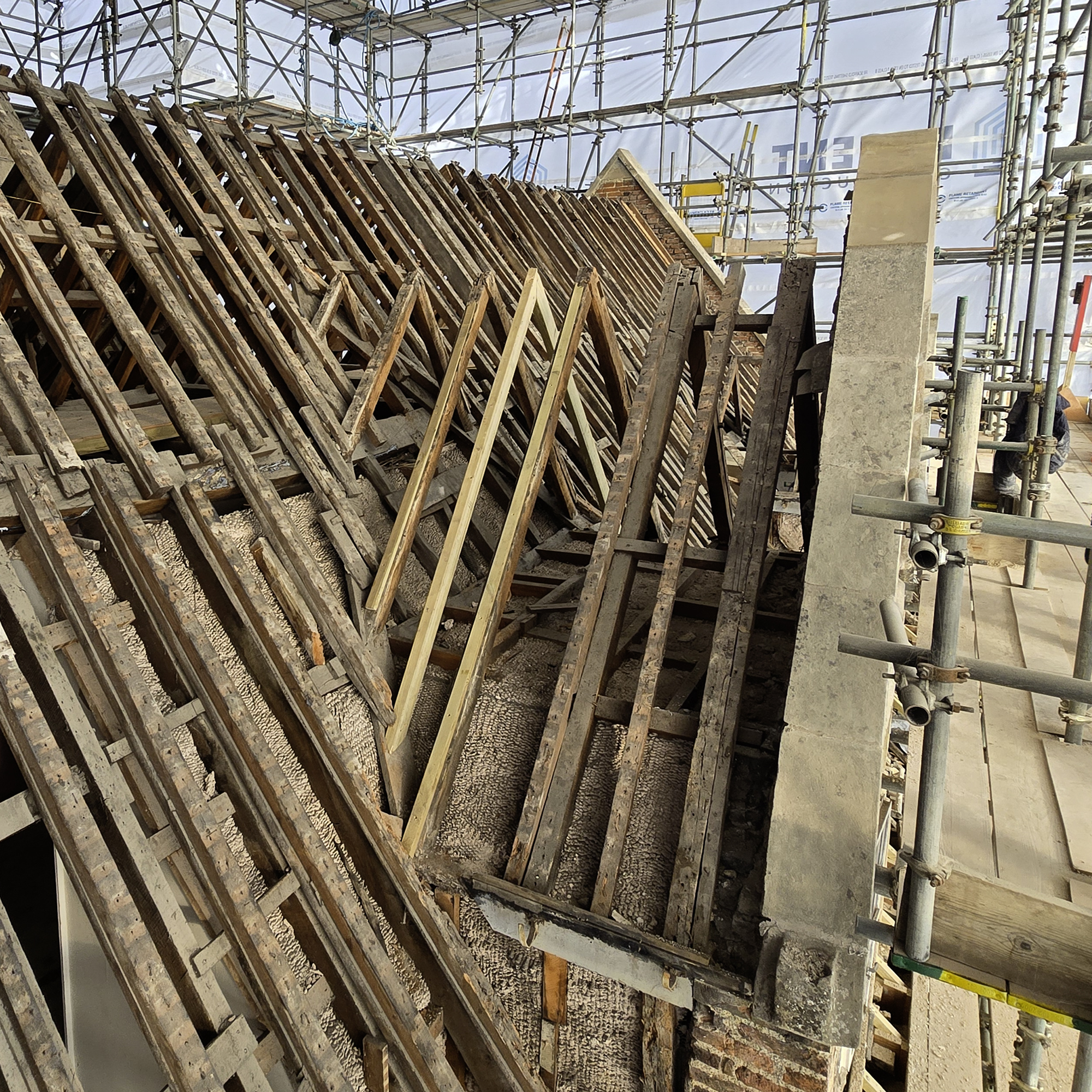

All roof tiles have now been removed. The old roofing felt and battens are being stripped away, exposing the underlying framework and revealing the skeleton of the roof.
October 2025

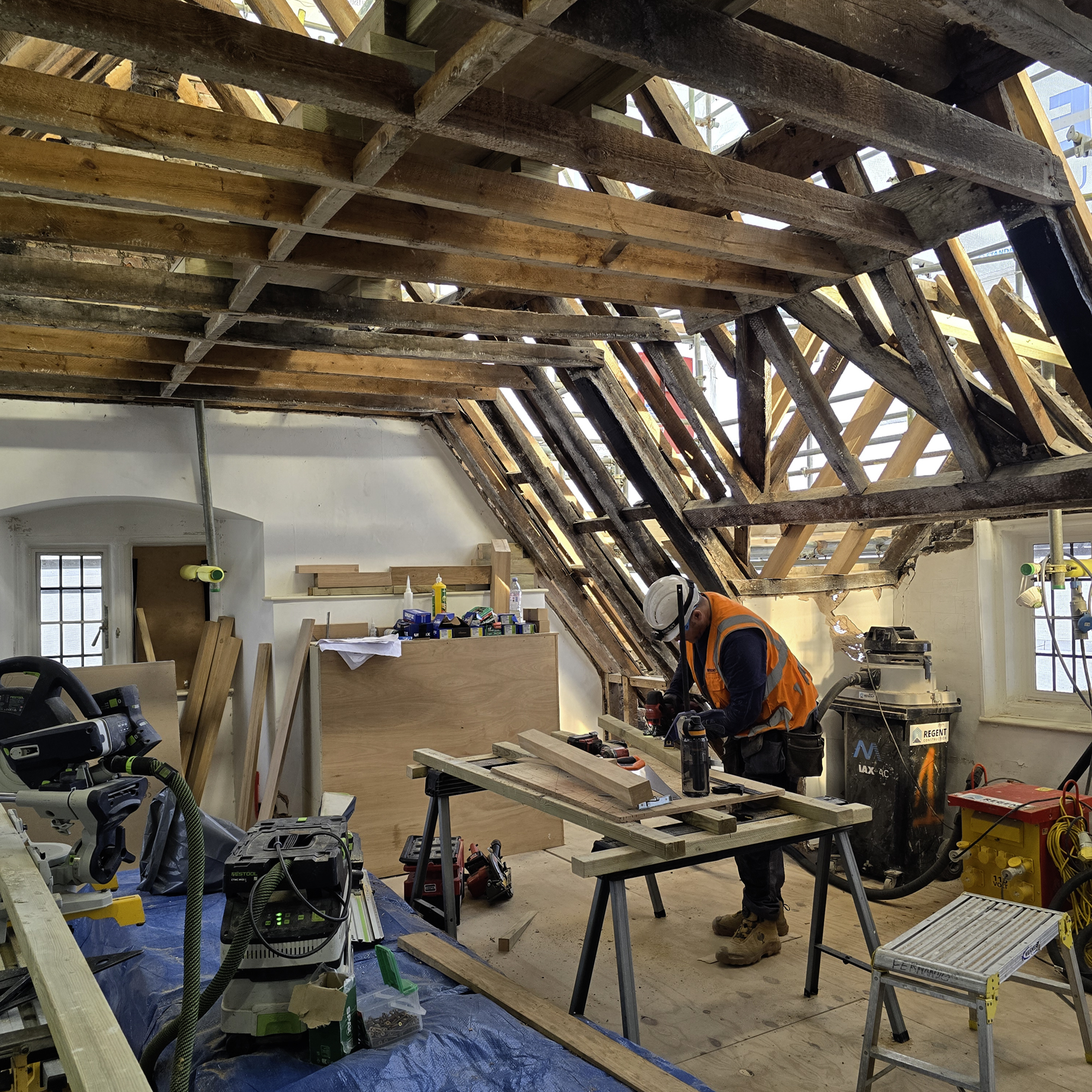

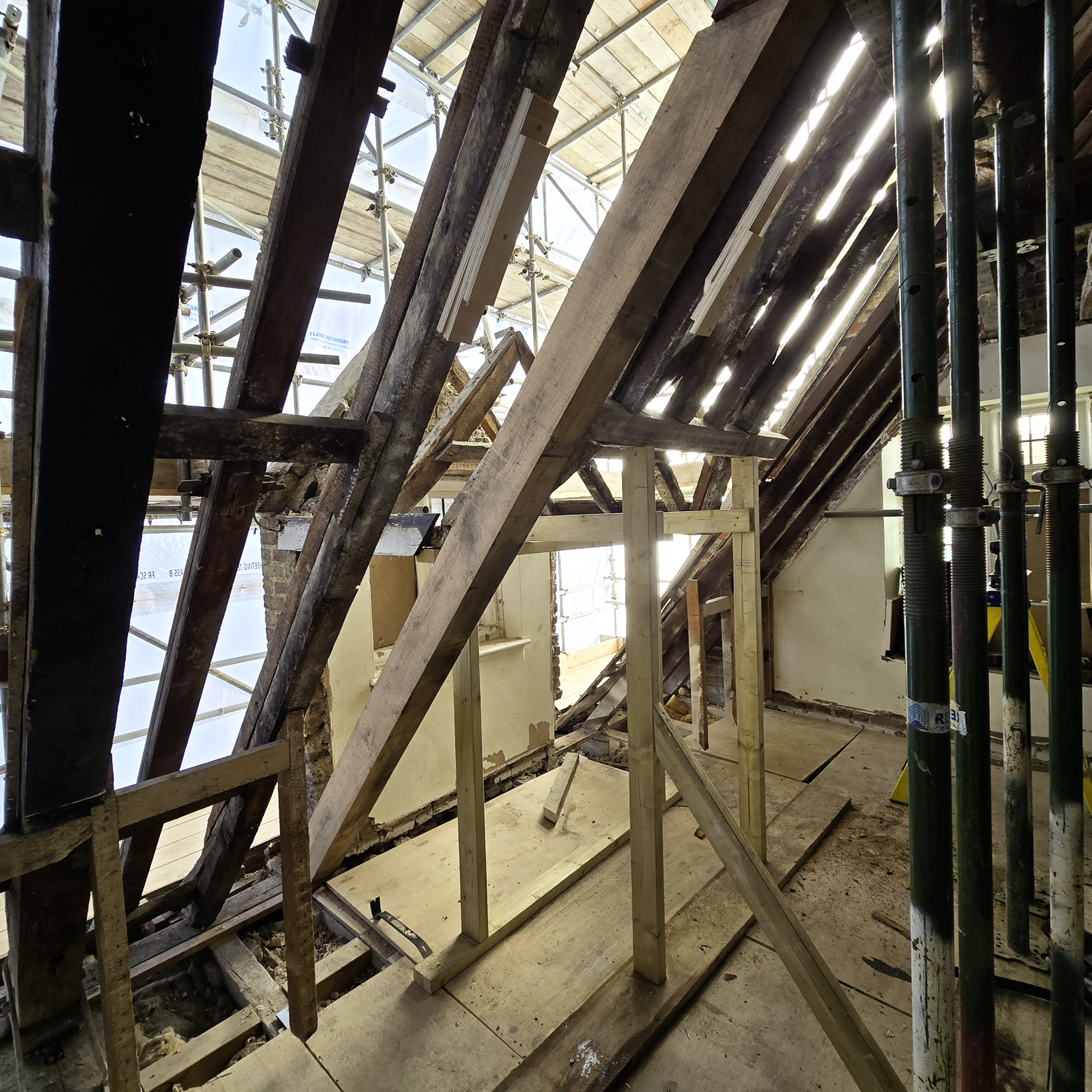

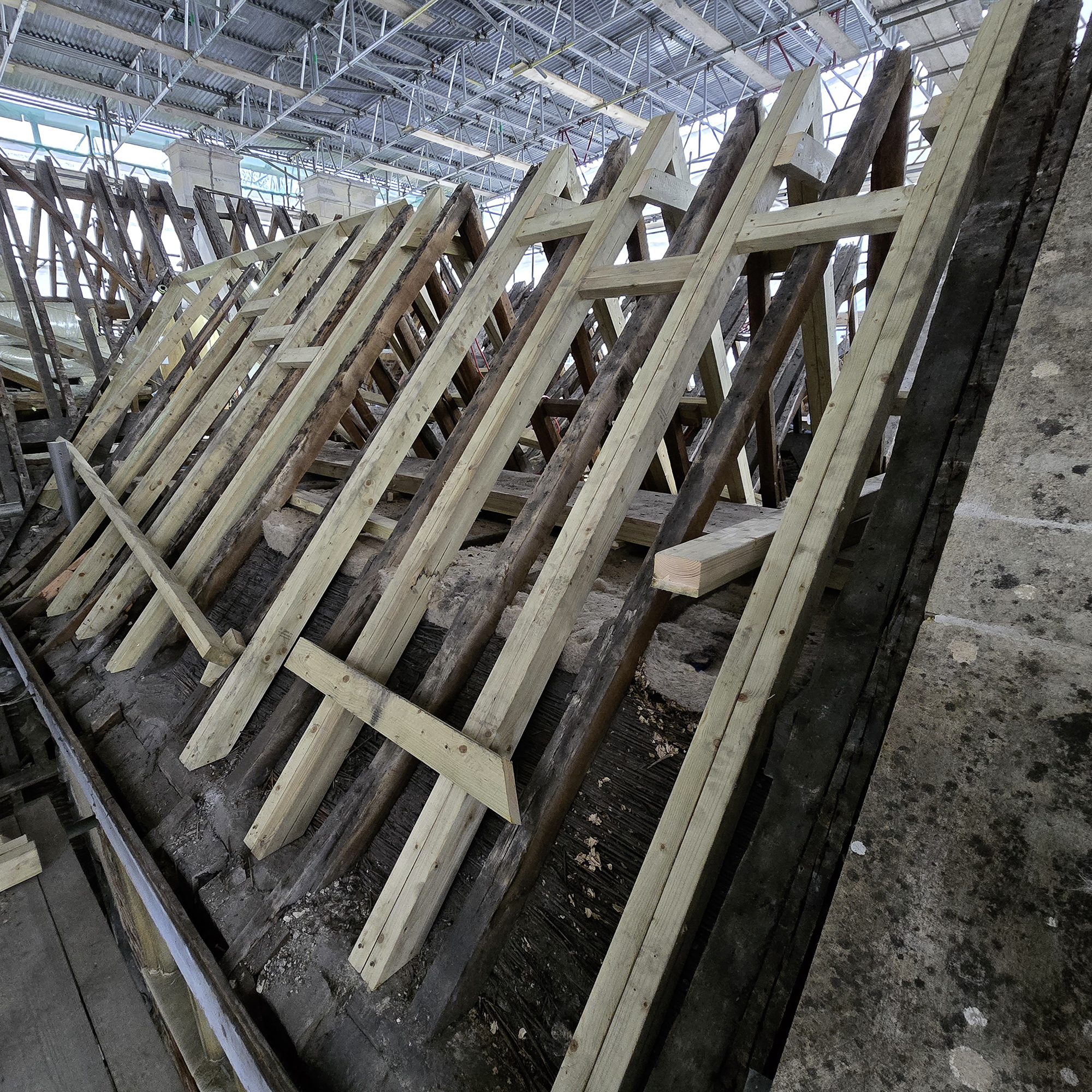

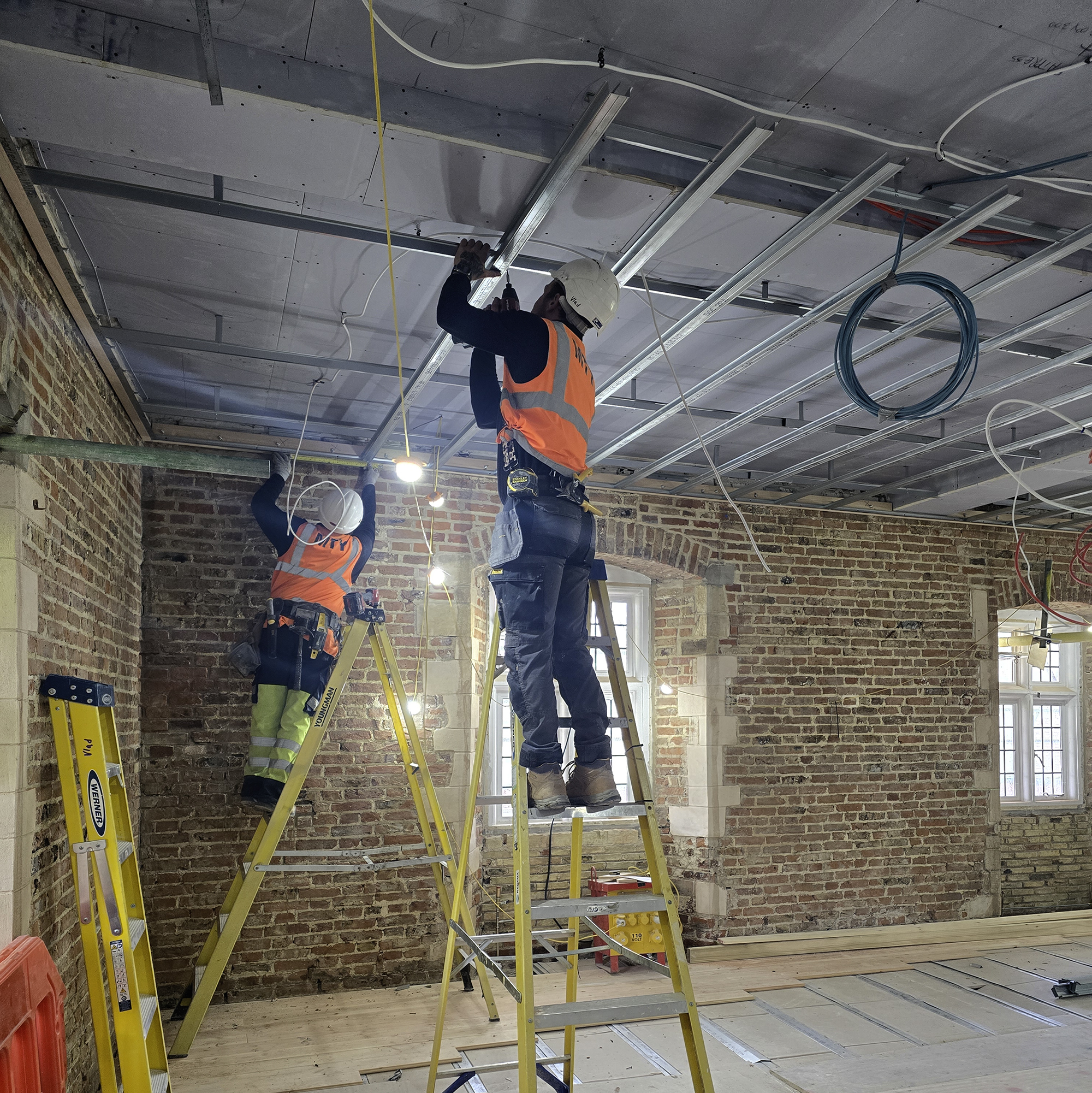

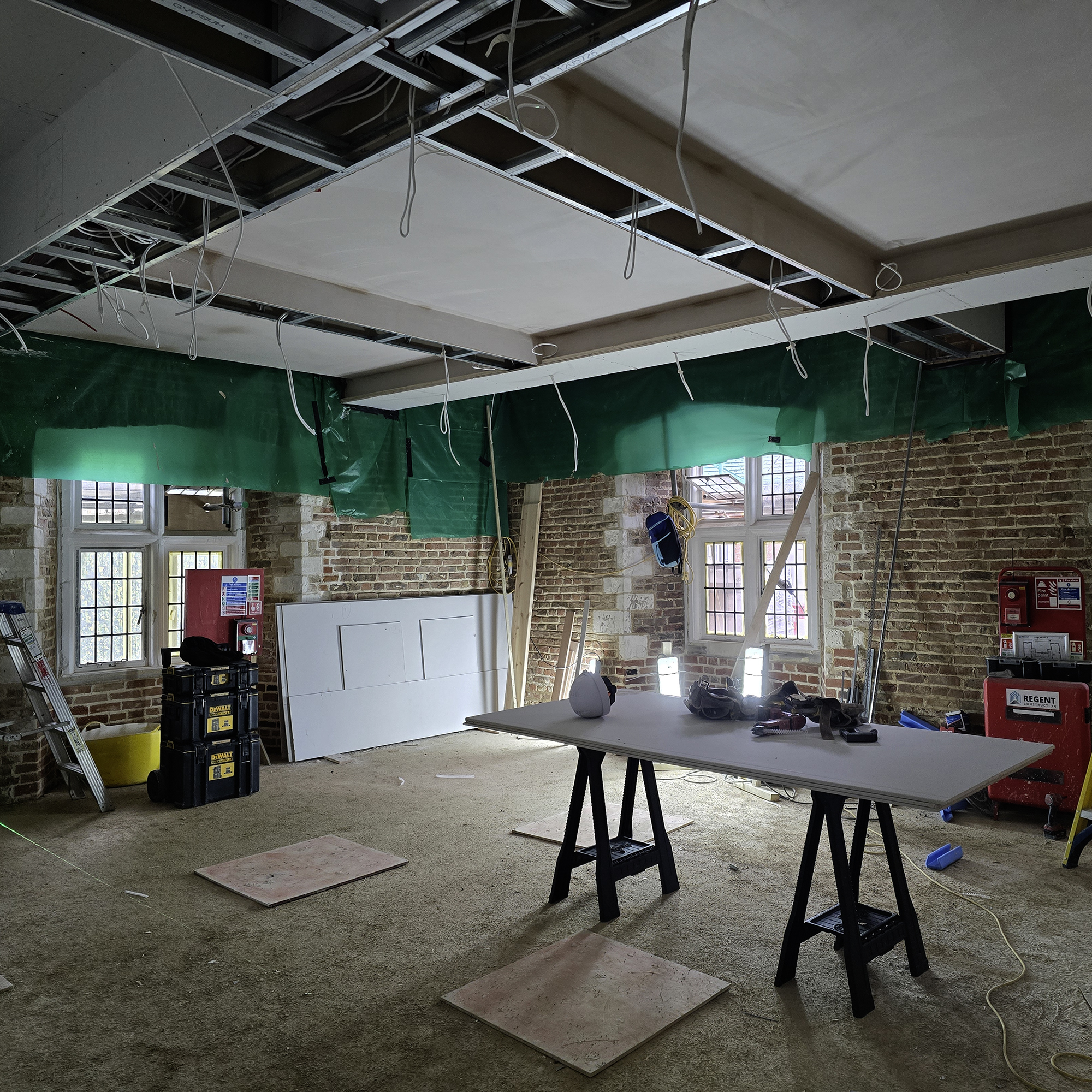

The second-floor ceilings have been stripped back to improve access to the roof space. Once restored, this work will enhance fire protection and allow the roof beams to be thoroughly inspected, tested, and repaired.
October 2025

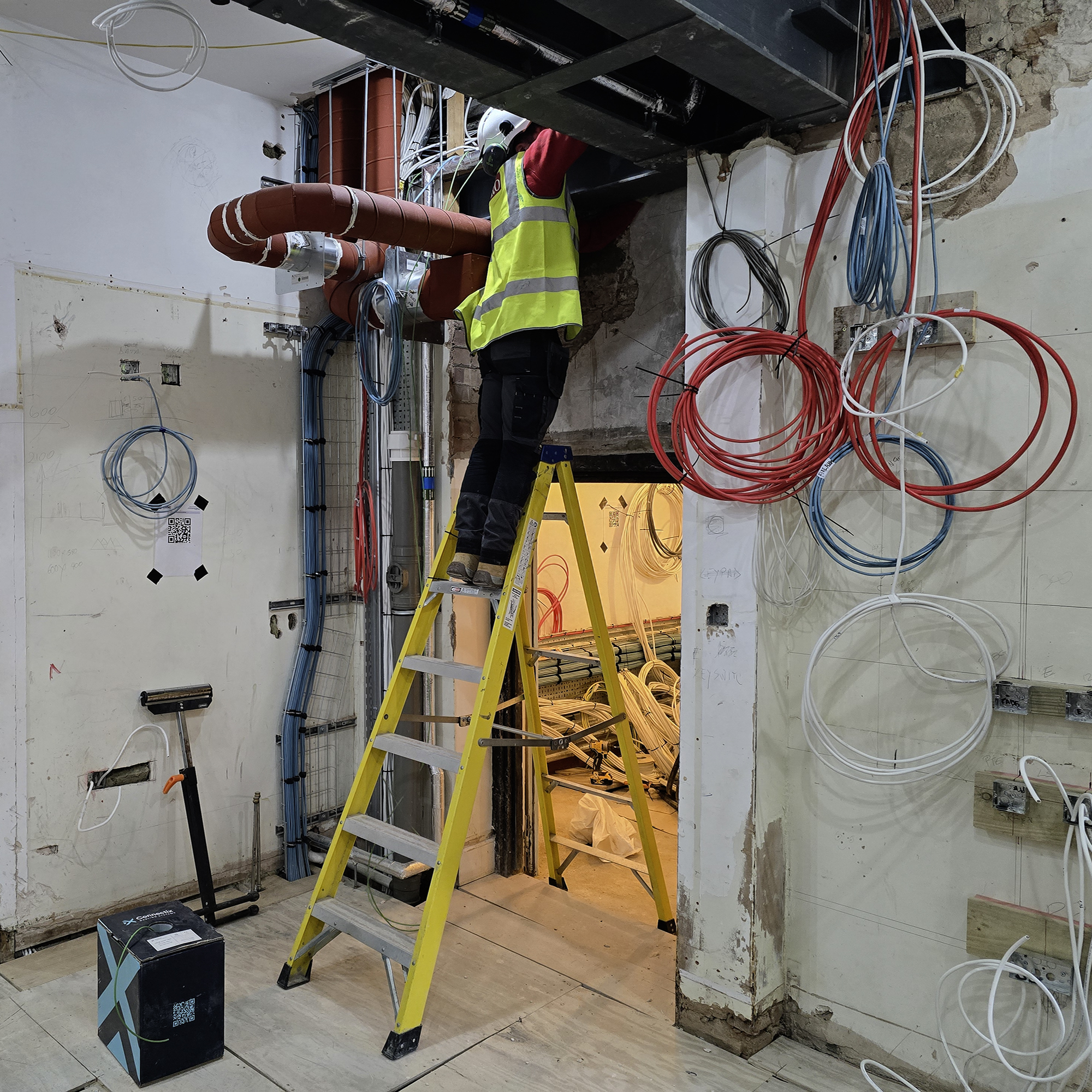

Massive steel beams have been installed in the back room of the Ground Floor Left Cloister to support the rear of the building. This space will be transformed into a new seminar and teaching room, where children can explore the Samuel Pepys collection and learn about his first-hand account of the Great Fire of London.
October 2025

Steel beams are being installed to form the framework of the new lift shaft, providing the necessary support for this addition and enabling step-free access to the historic Pepys Library.
October 2025

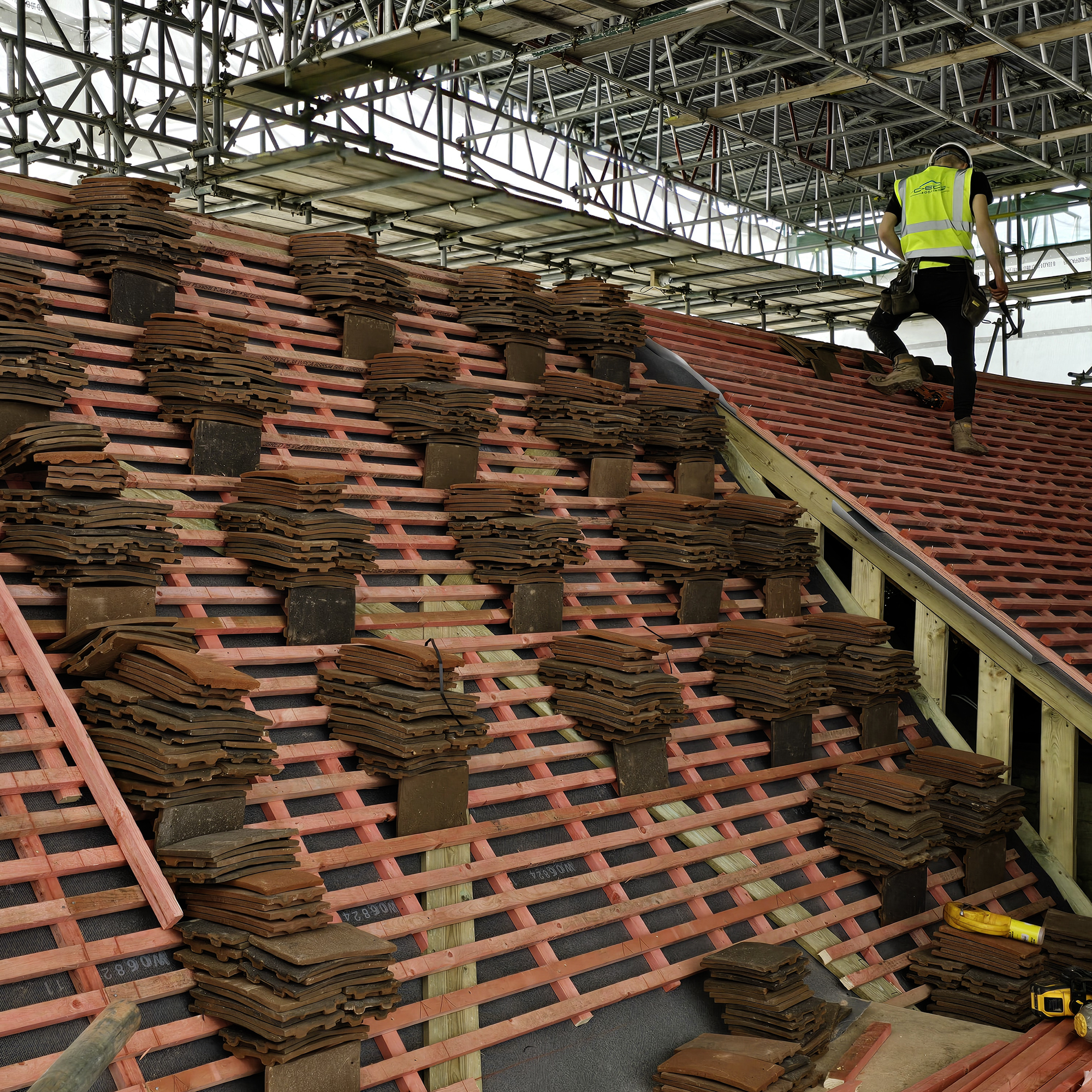

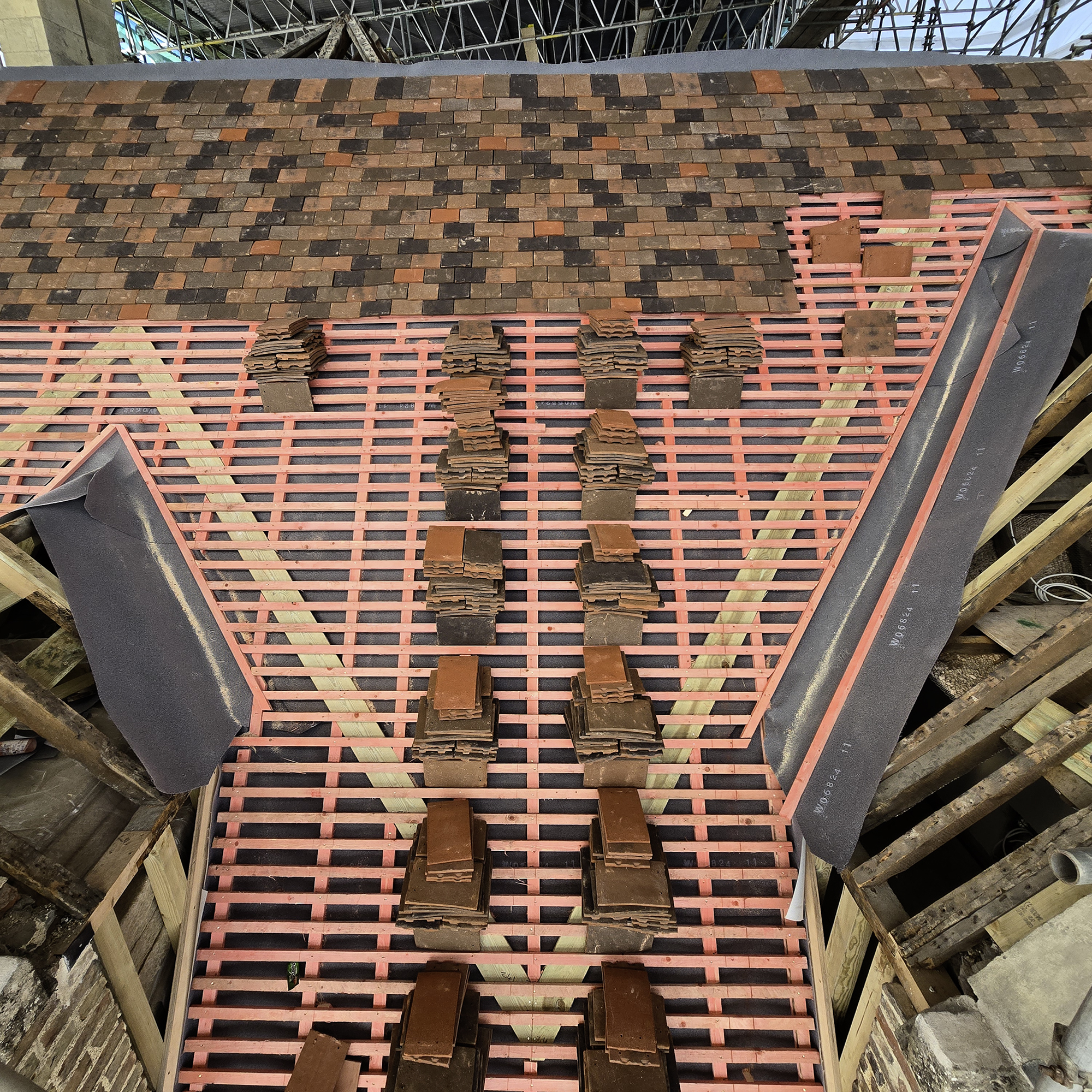

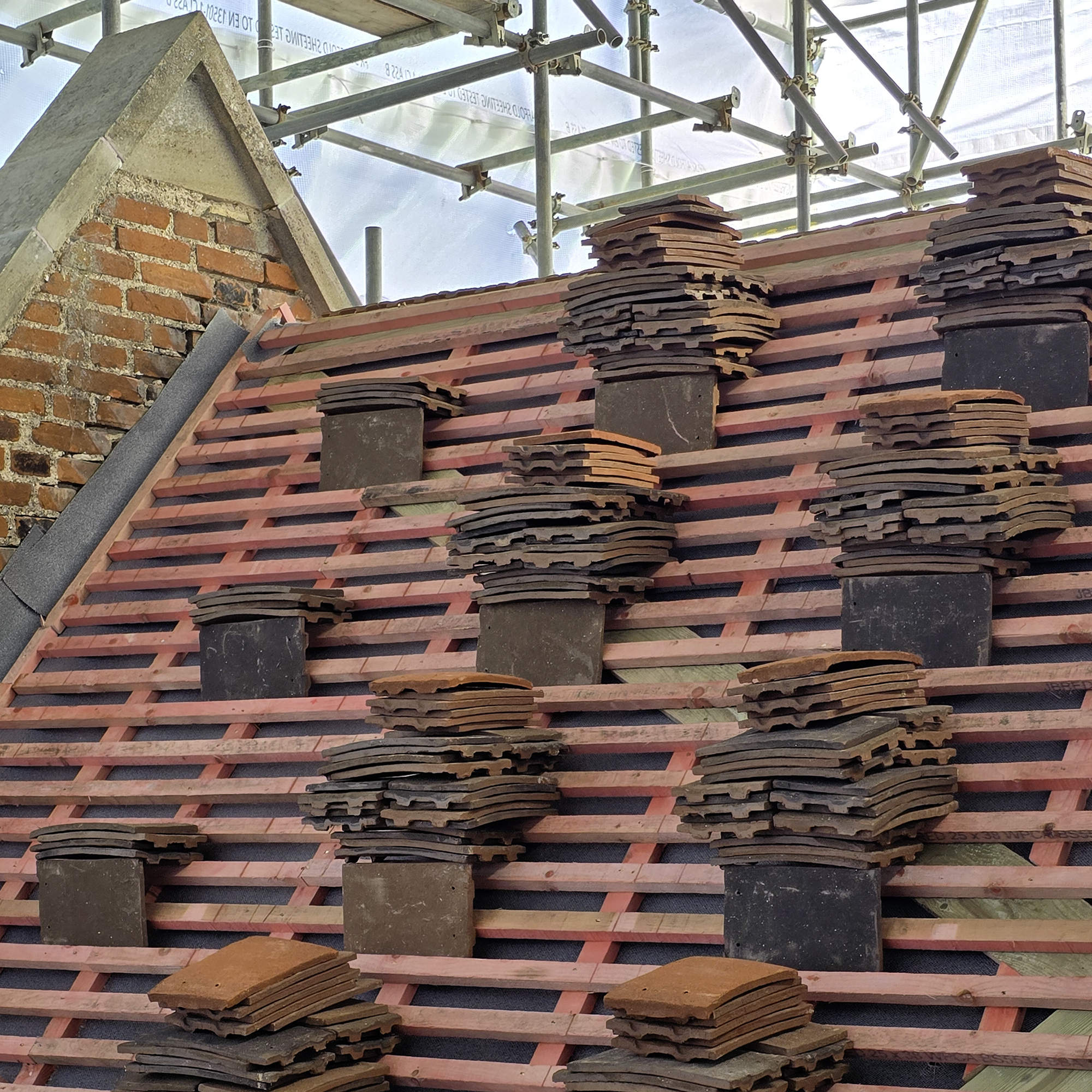

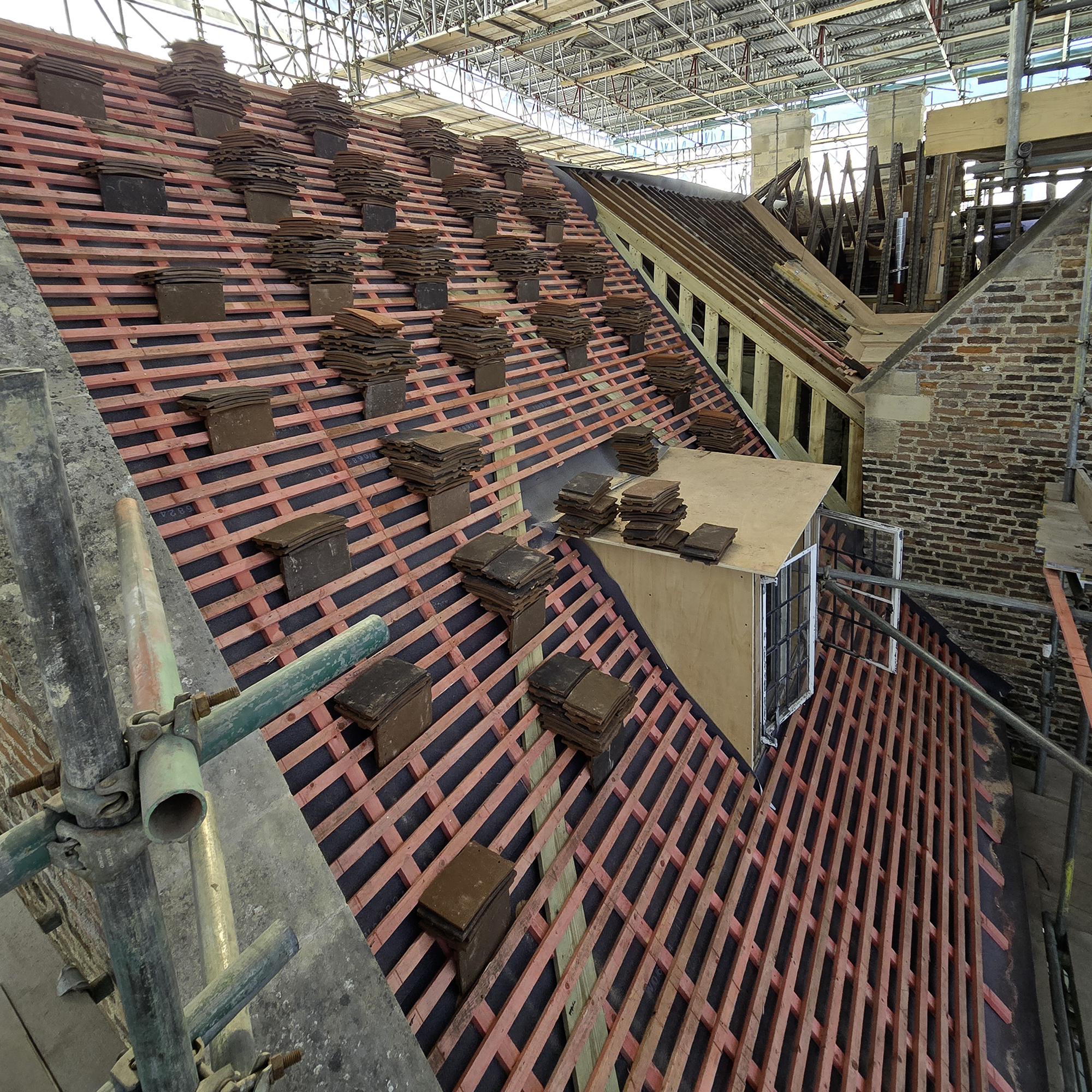

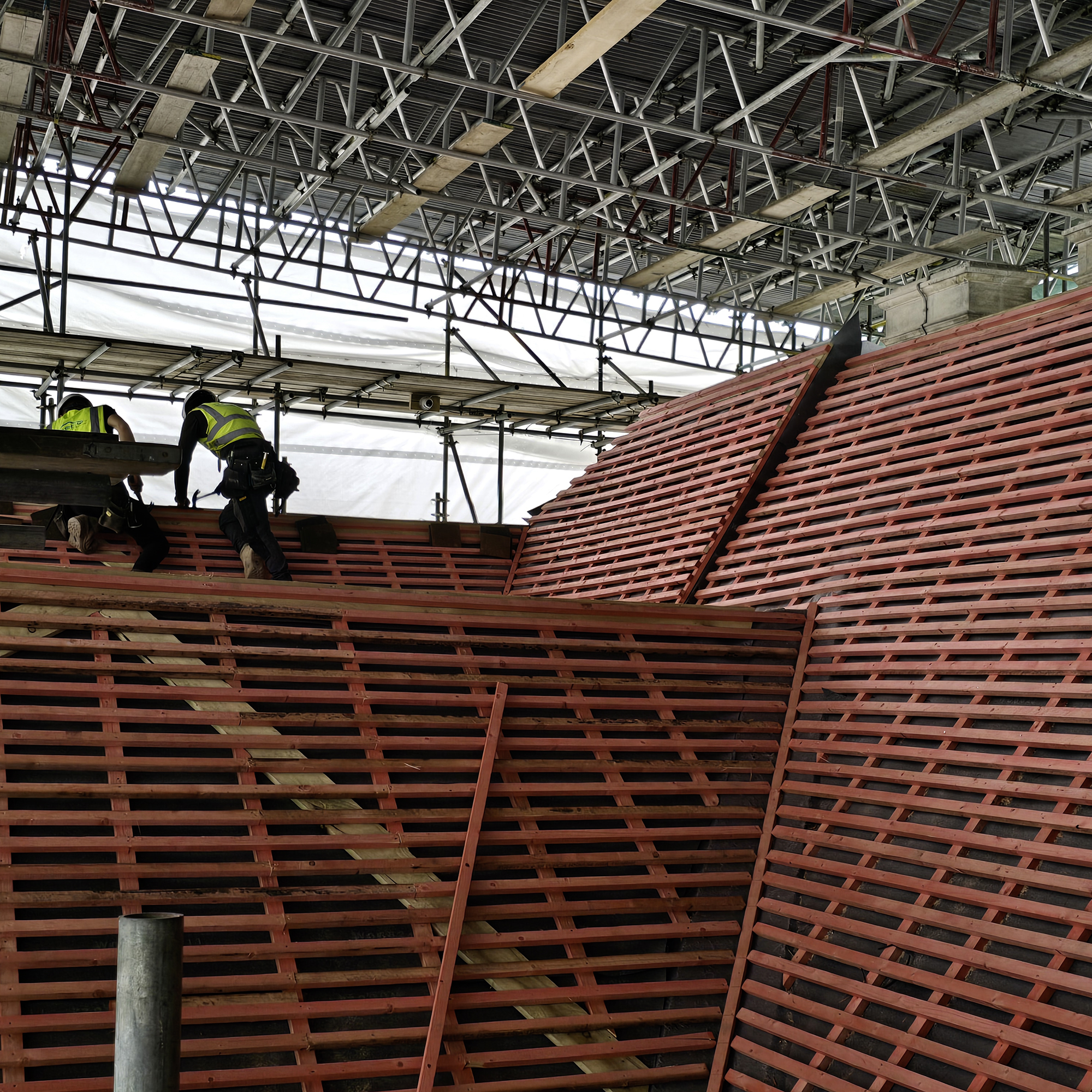

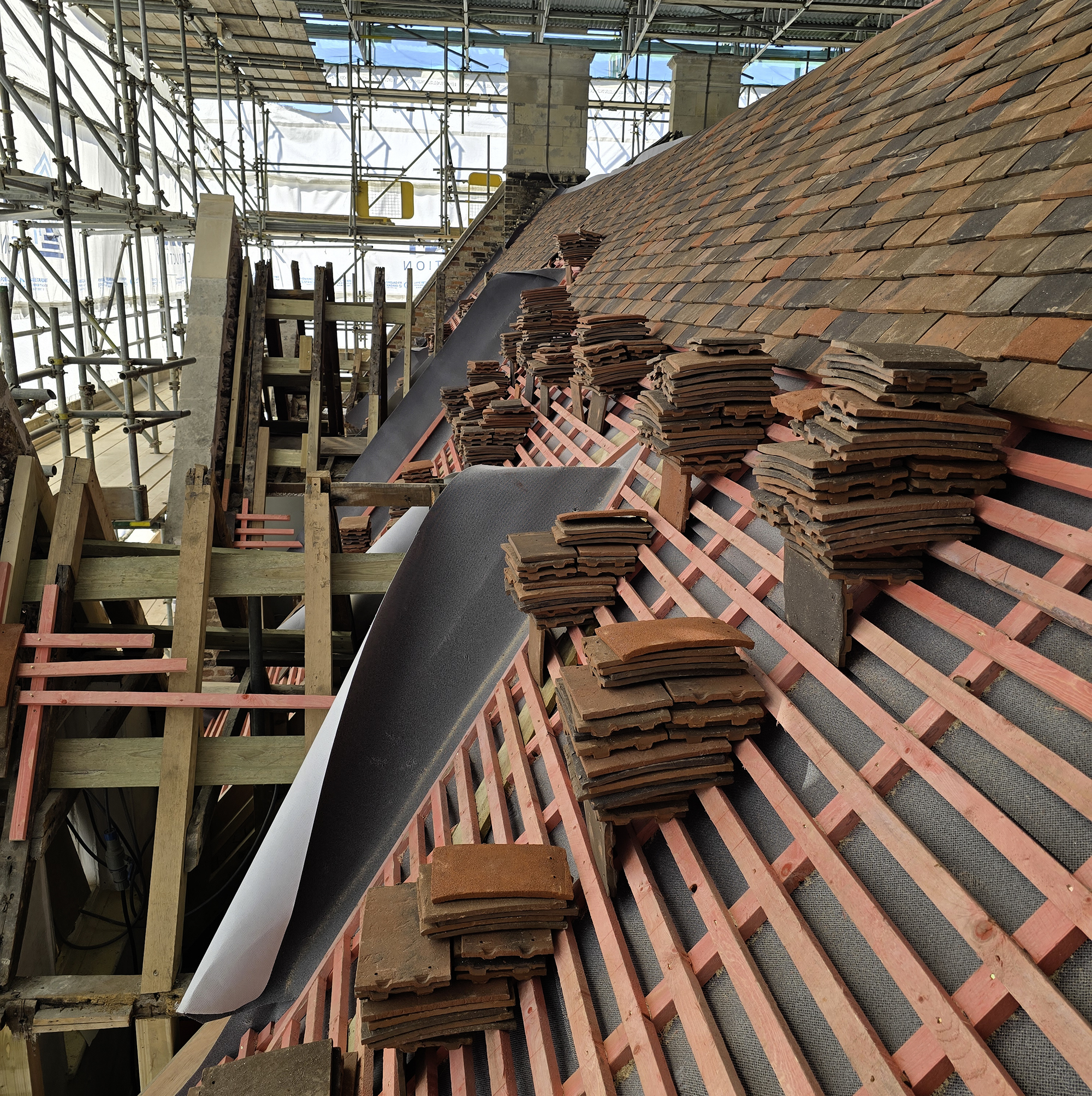

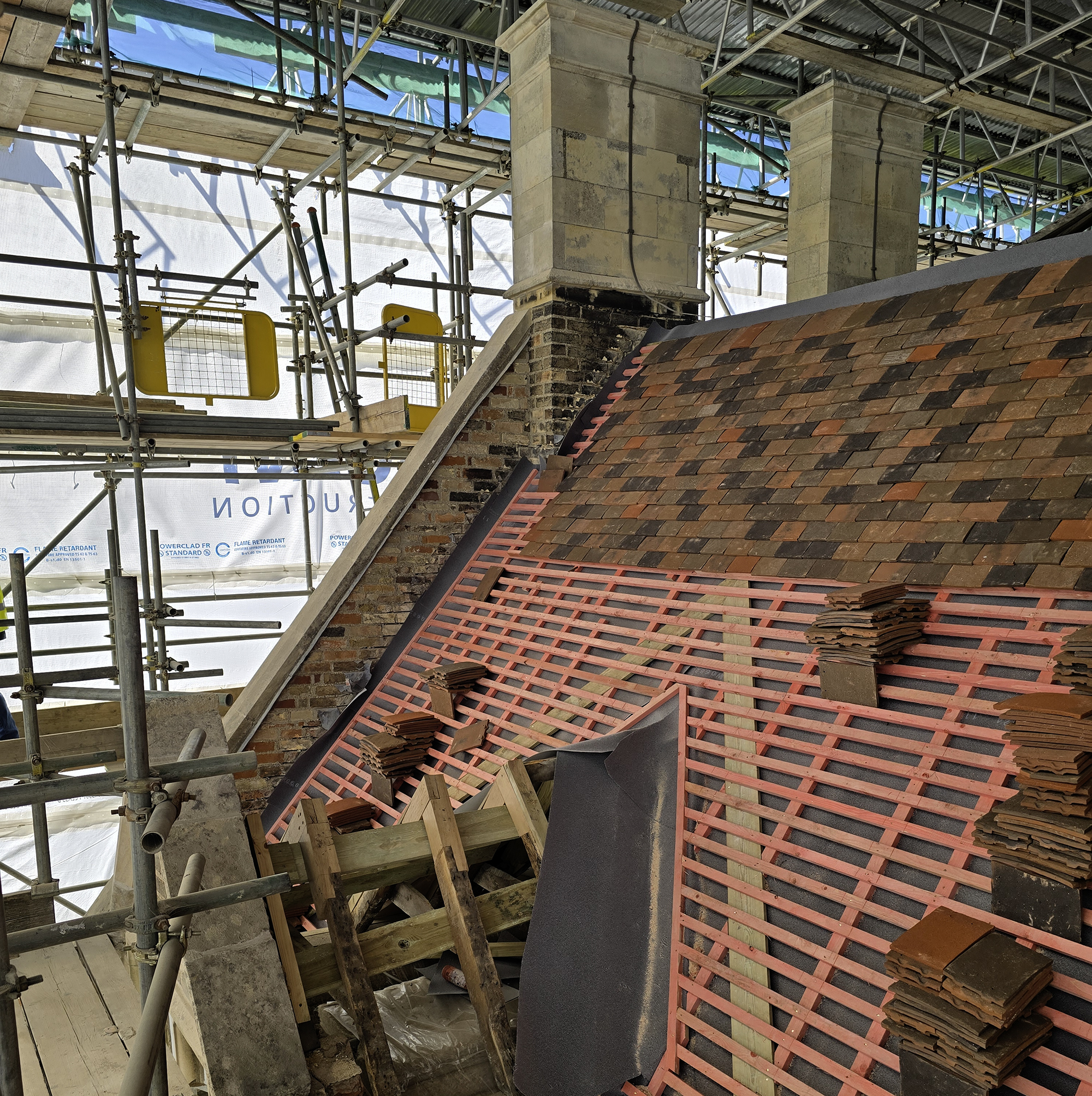

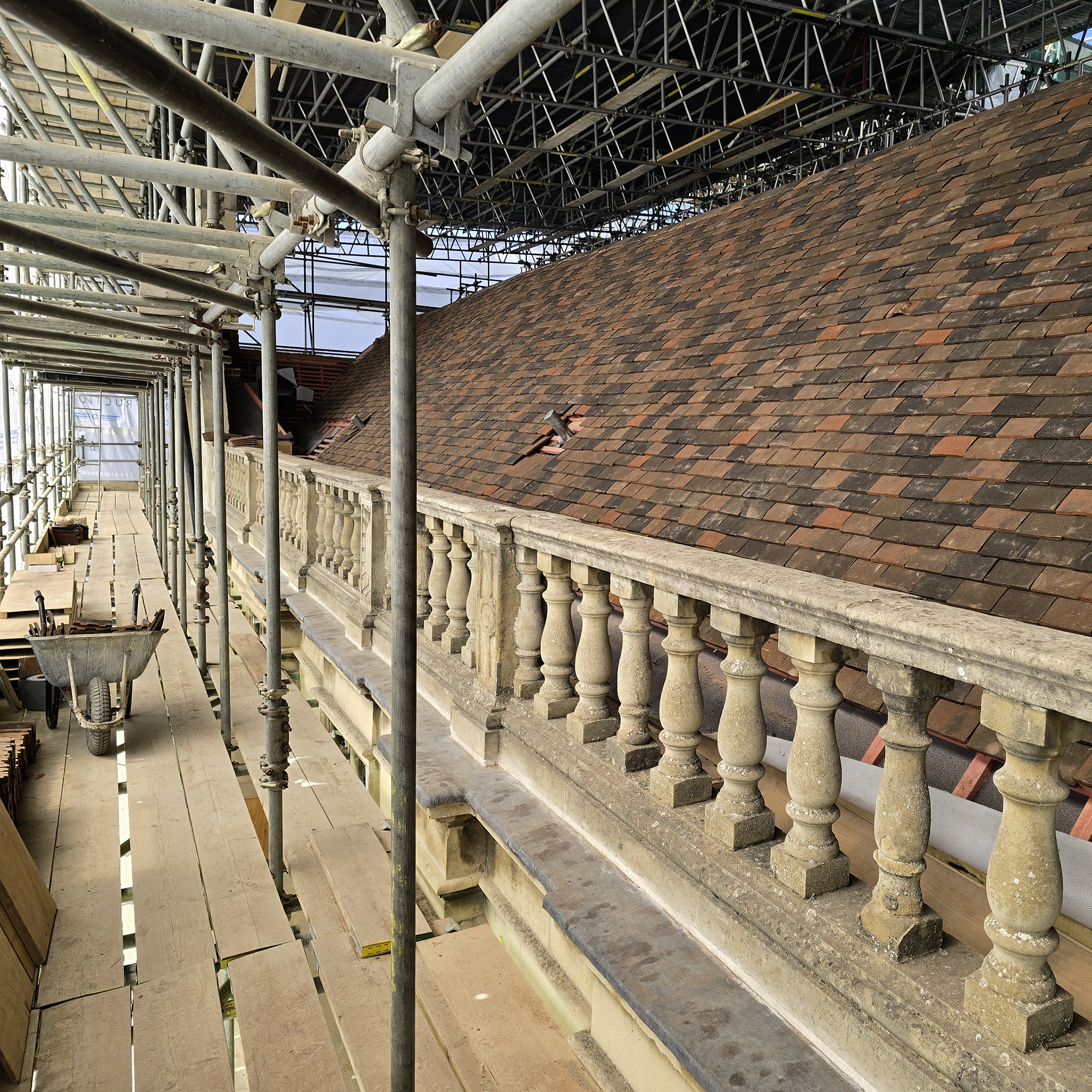

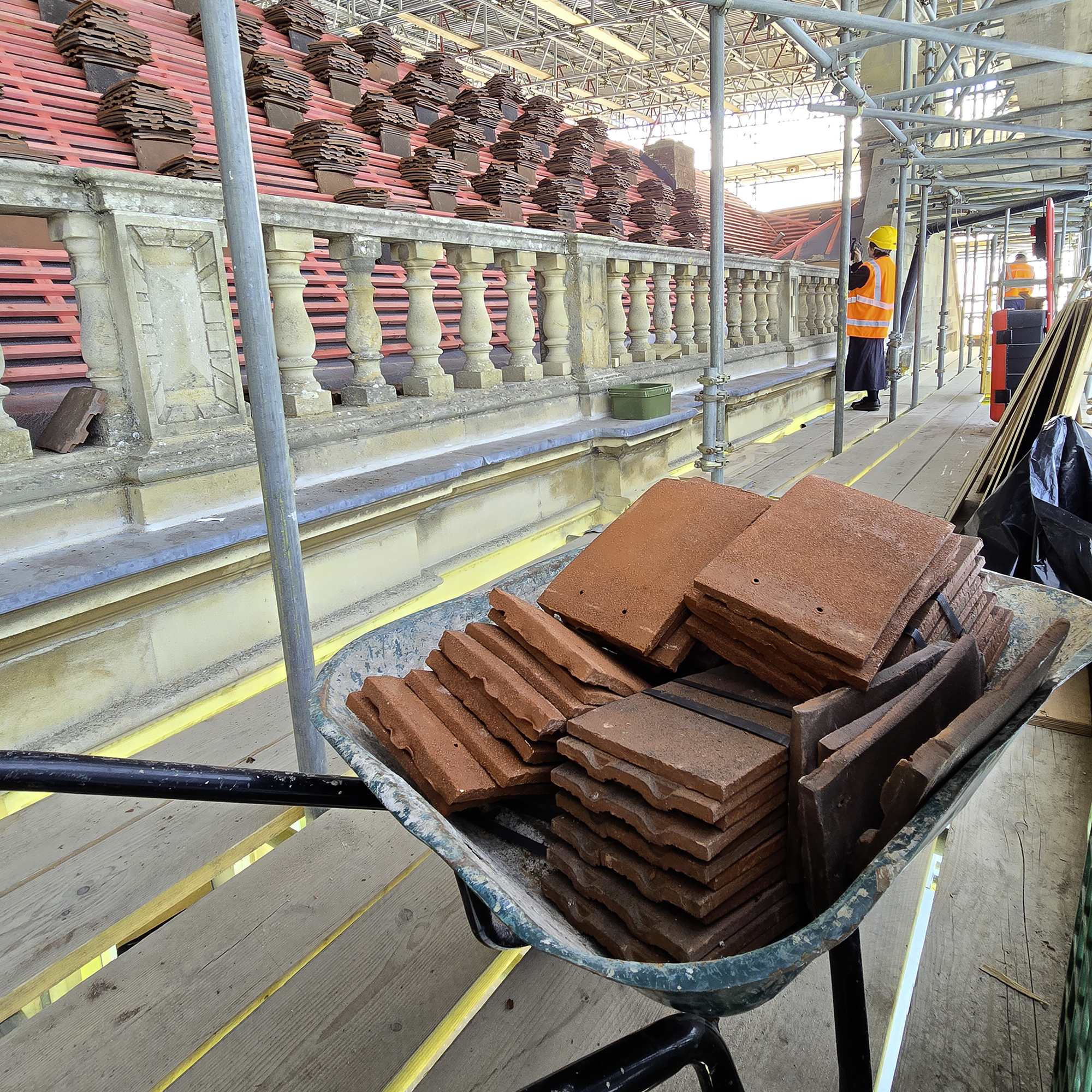

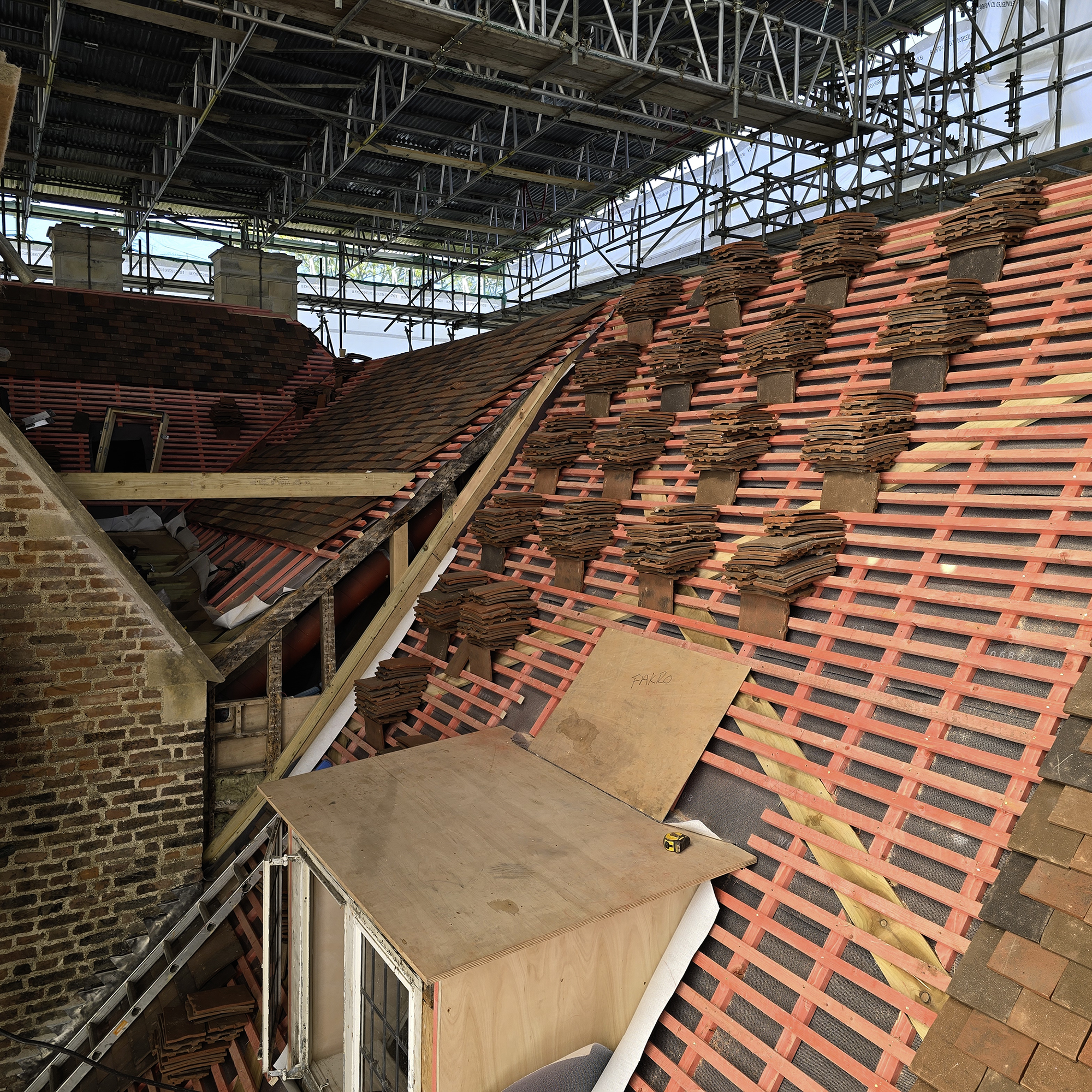

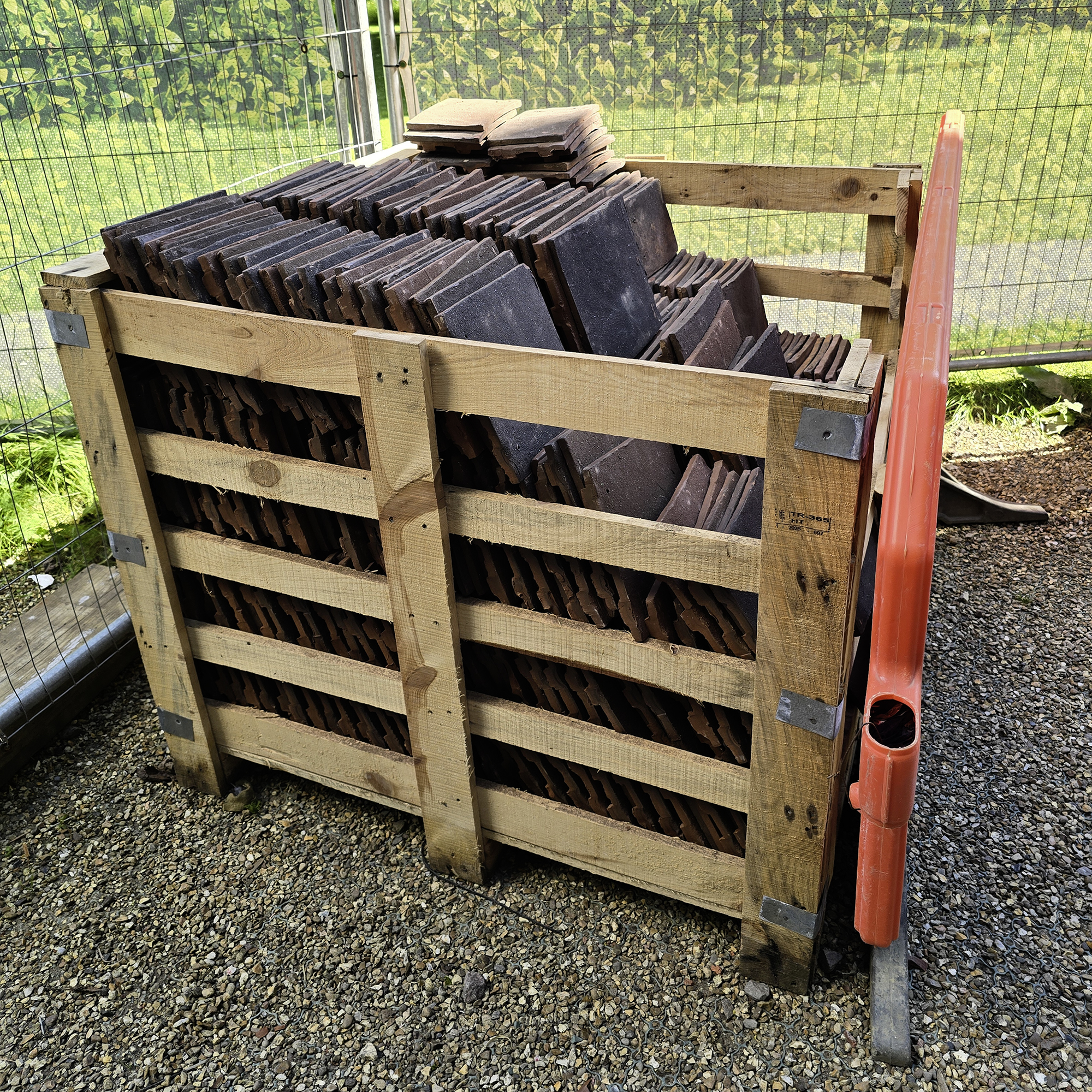

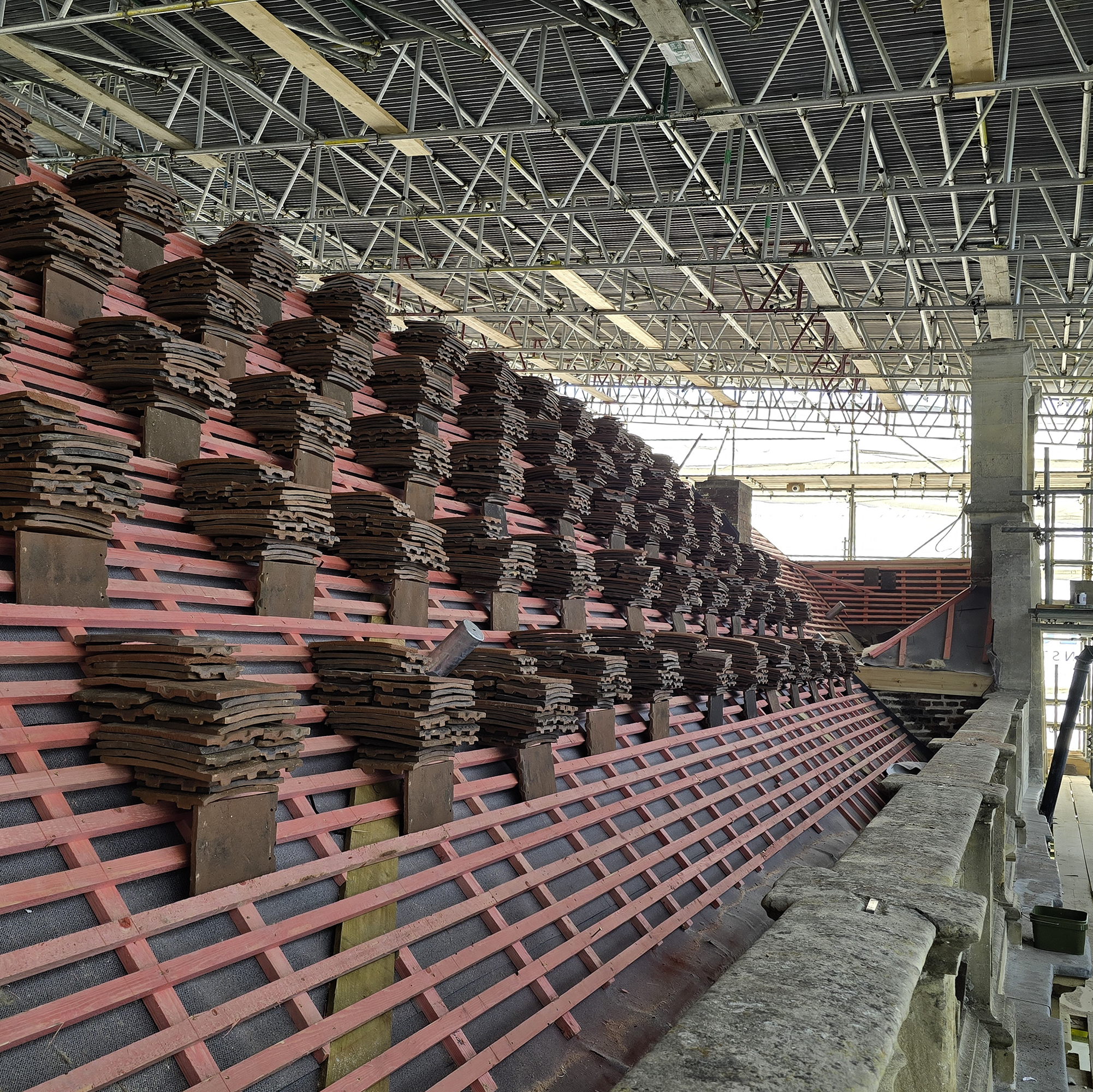

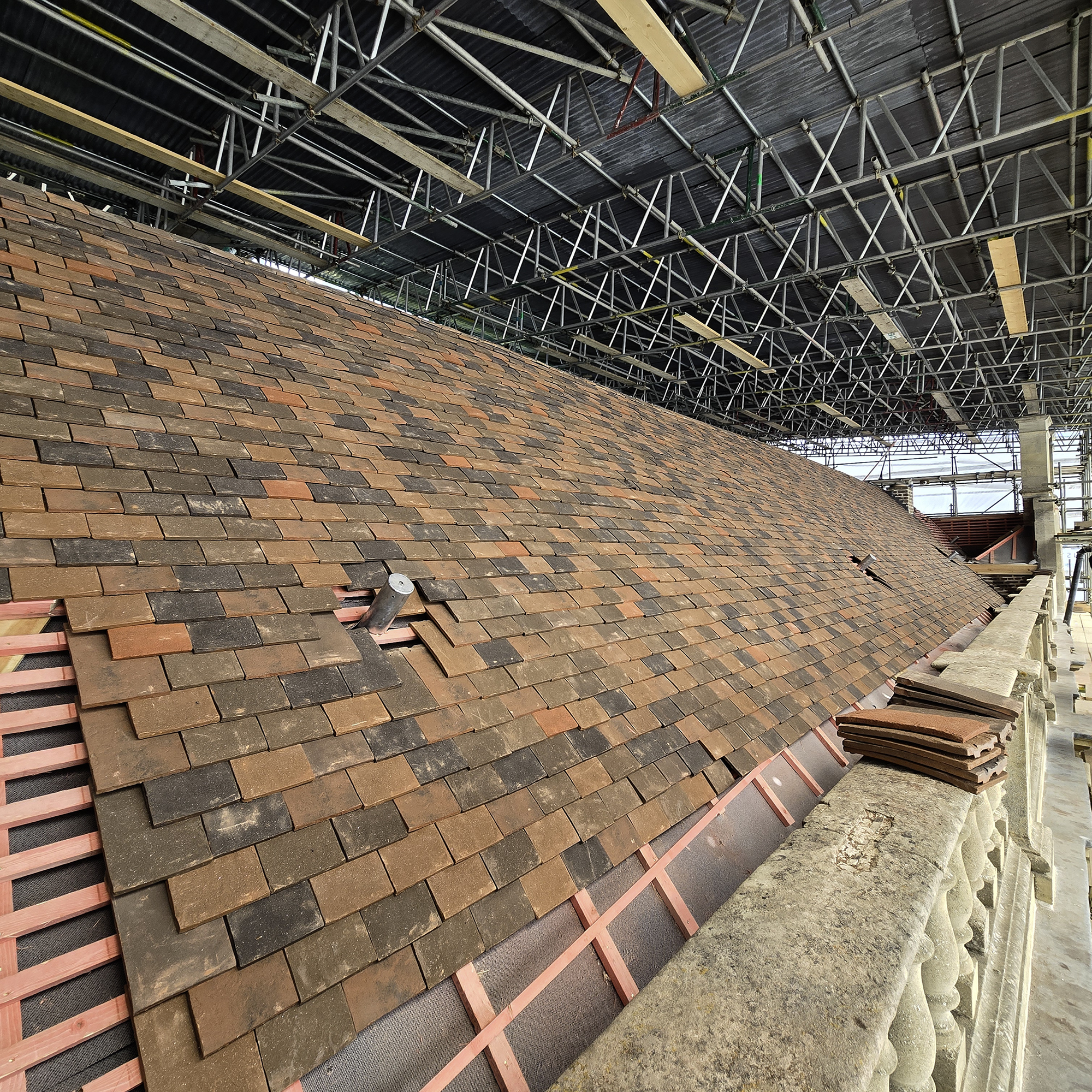

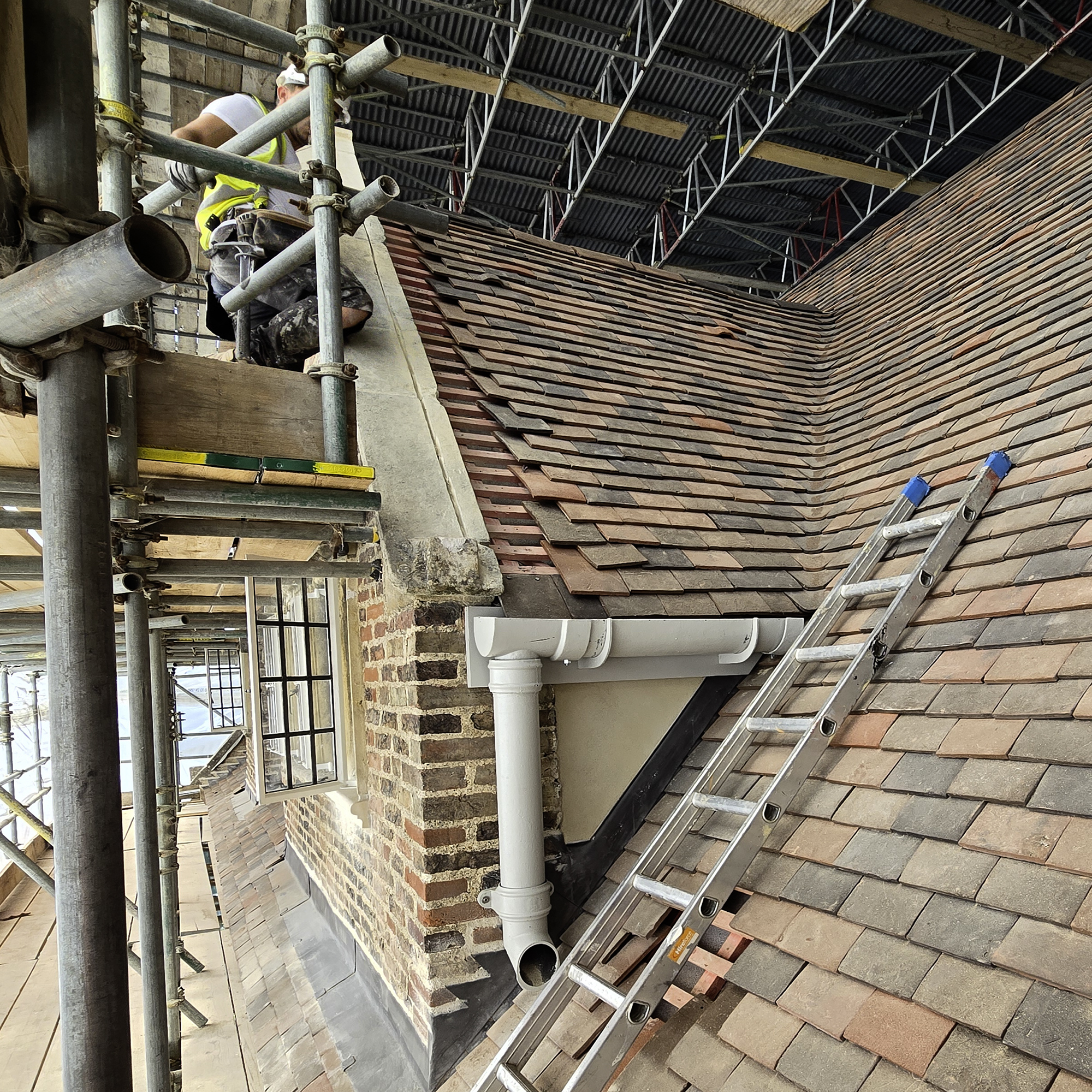

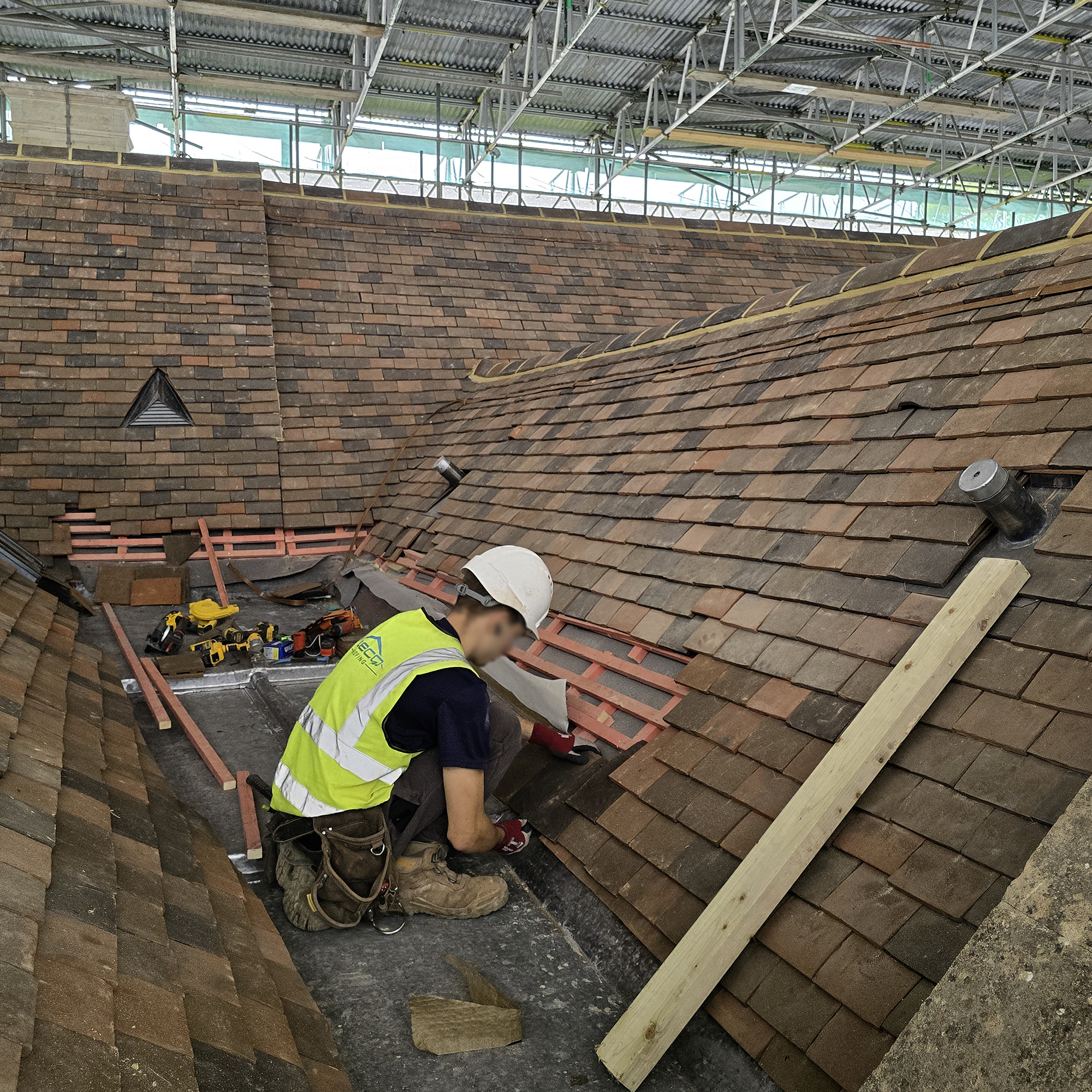

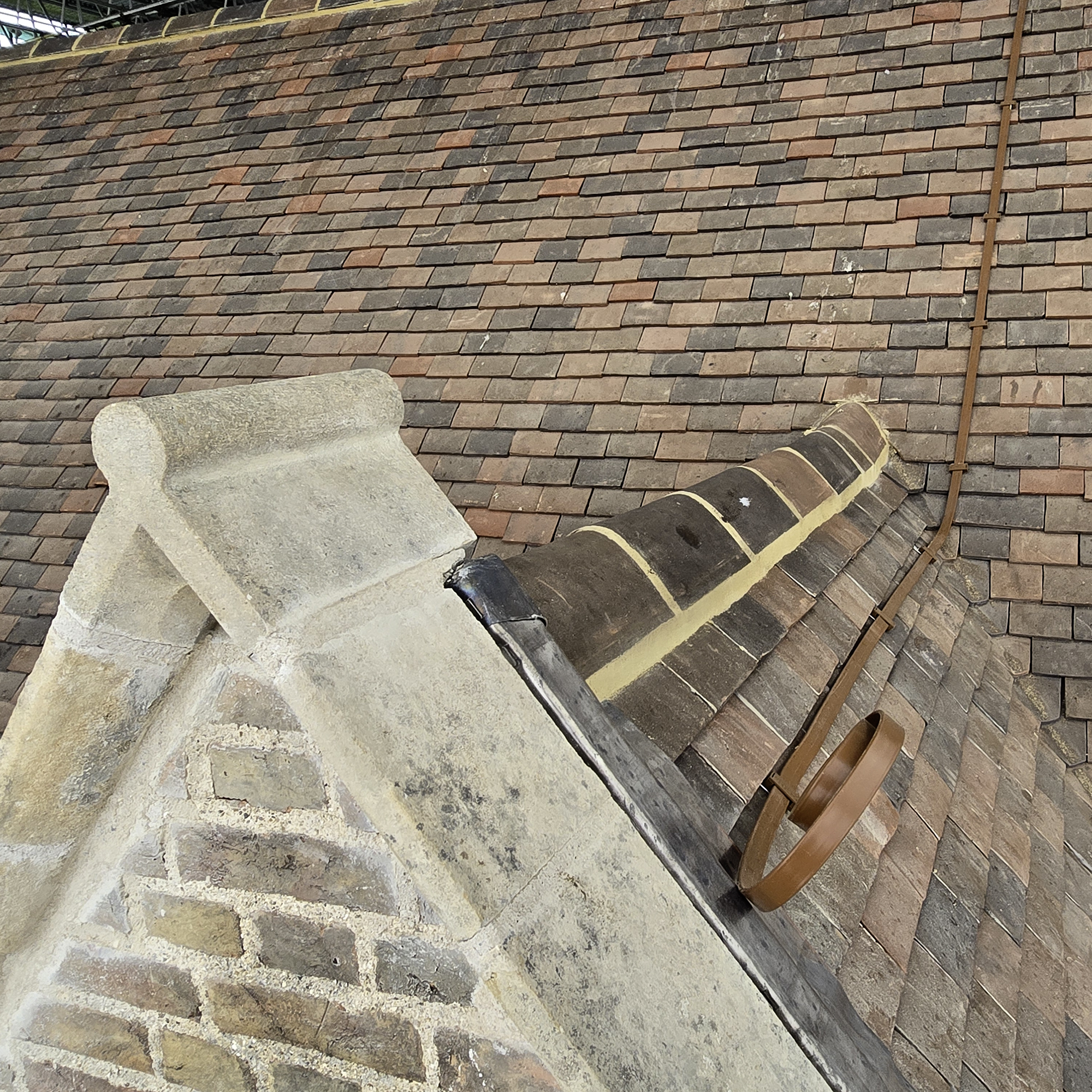

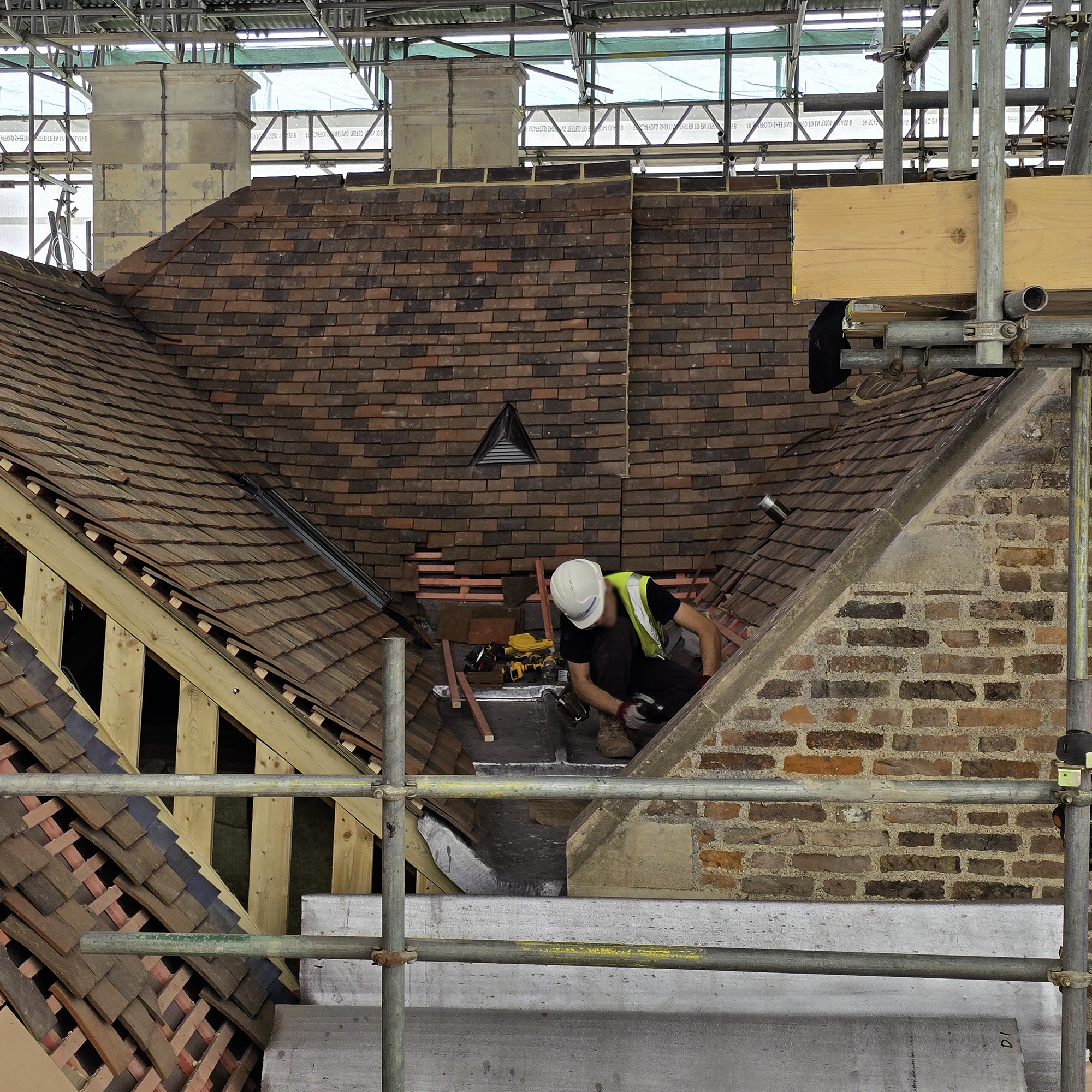

Roof tile removal is continuing, with care taken to preserve them wherever possible. Salvaged tiles are being stored for reuse, helping to maintain the building’s original character.
October 2025

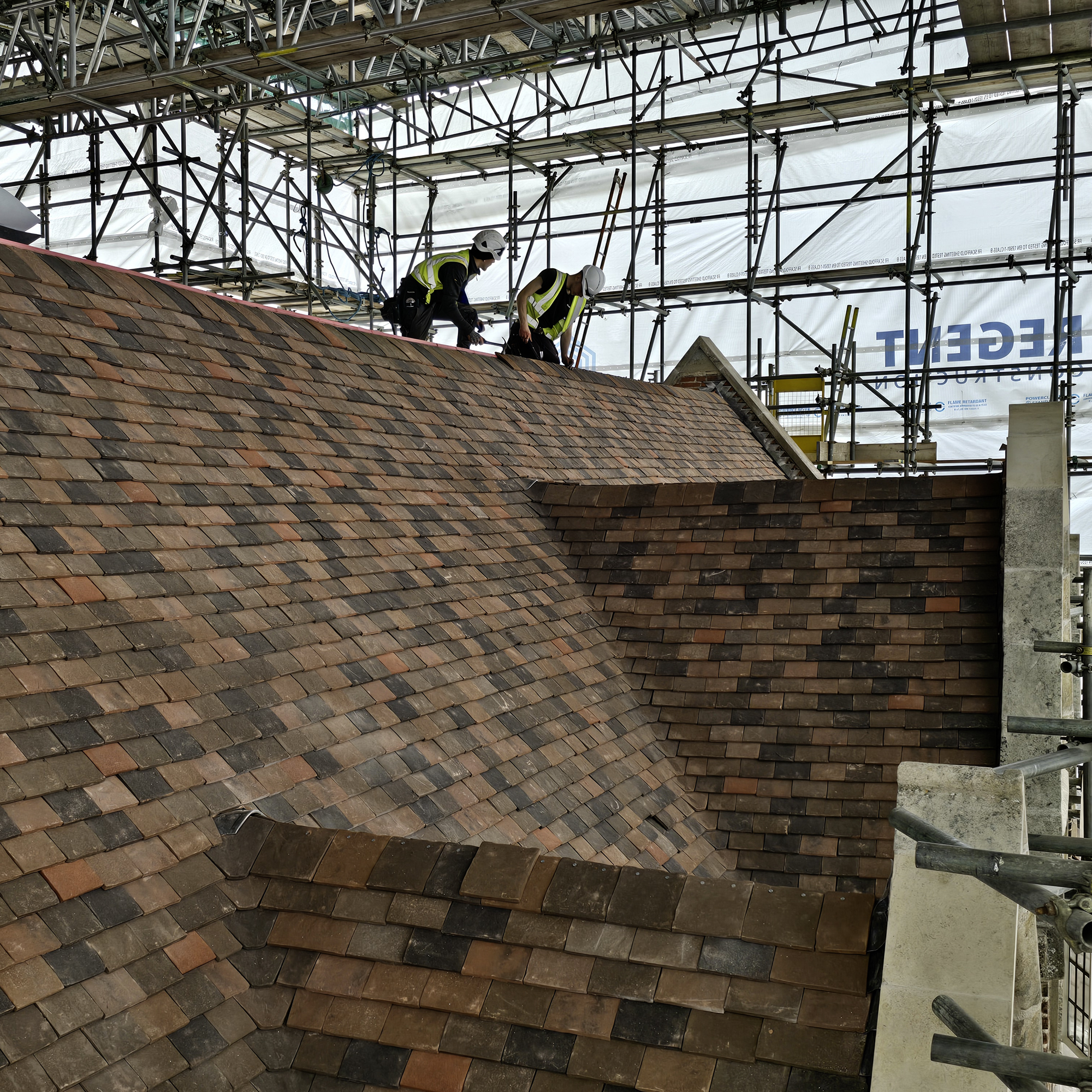

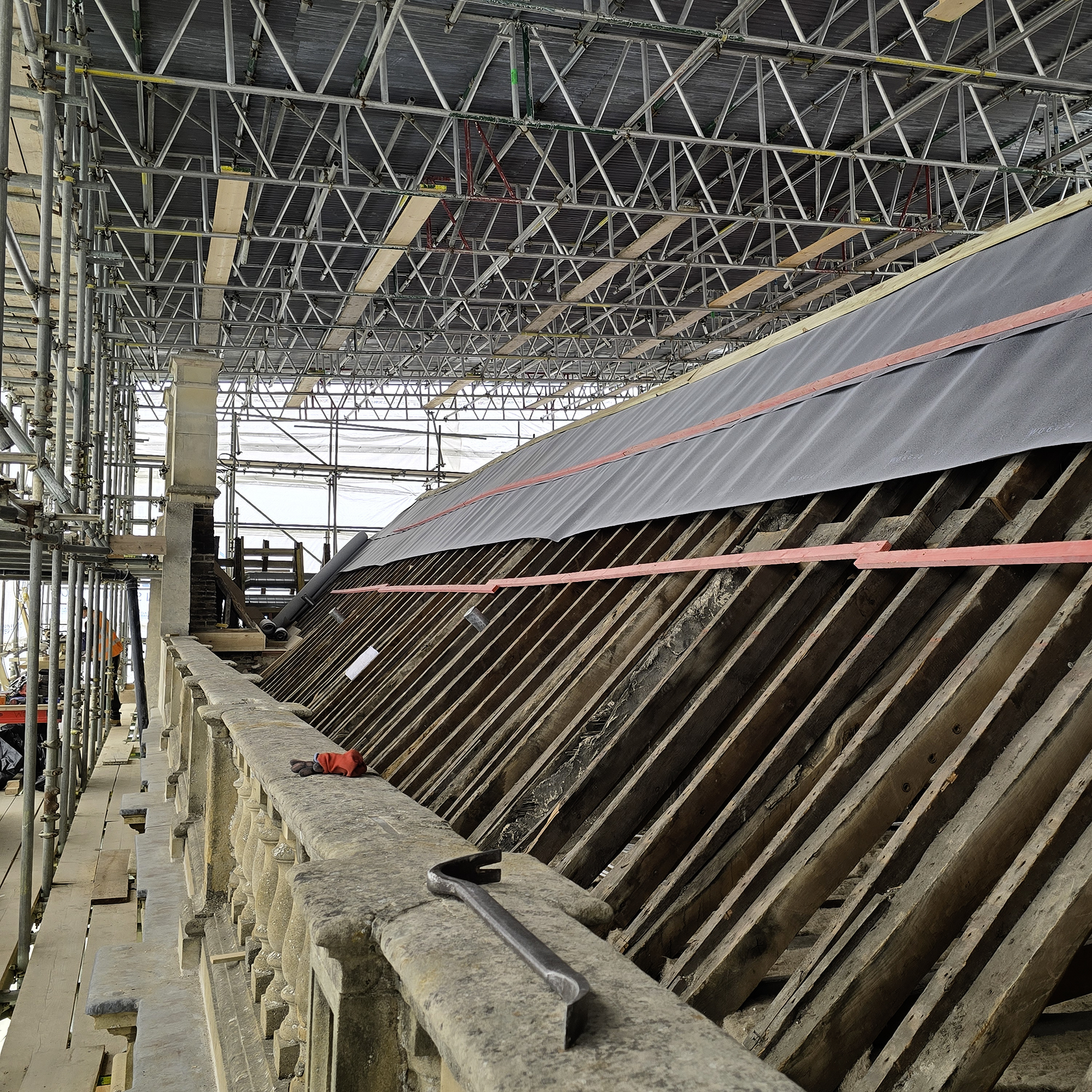

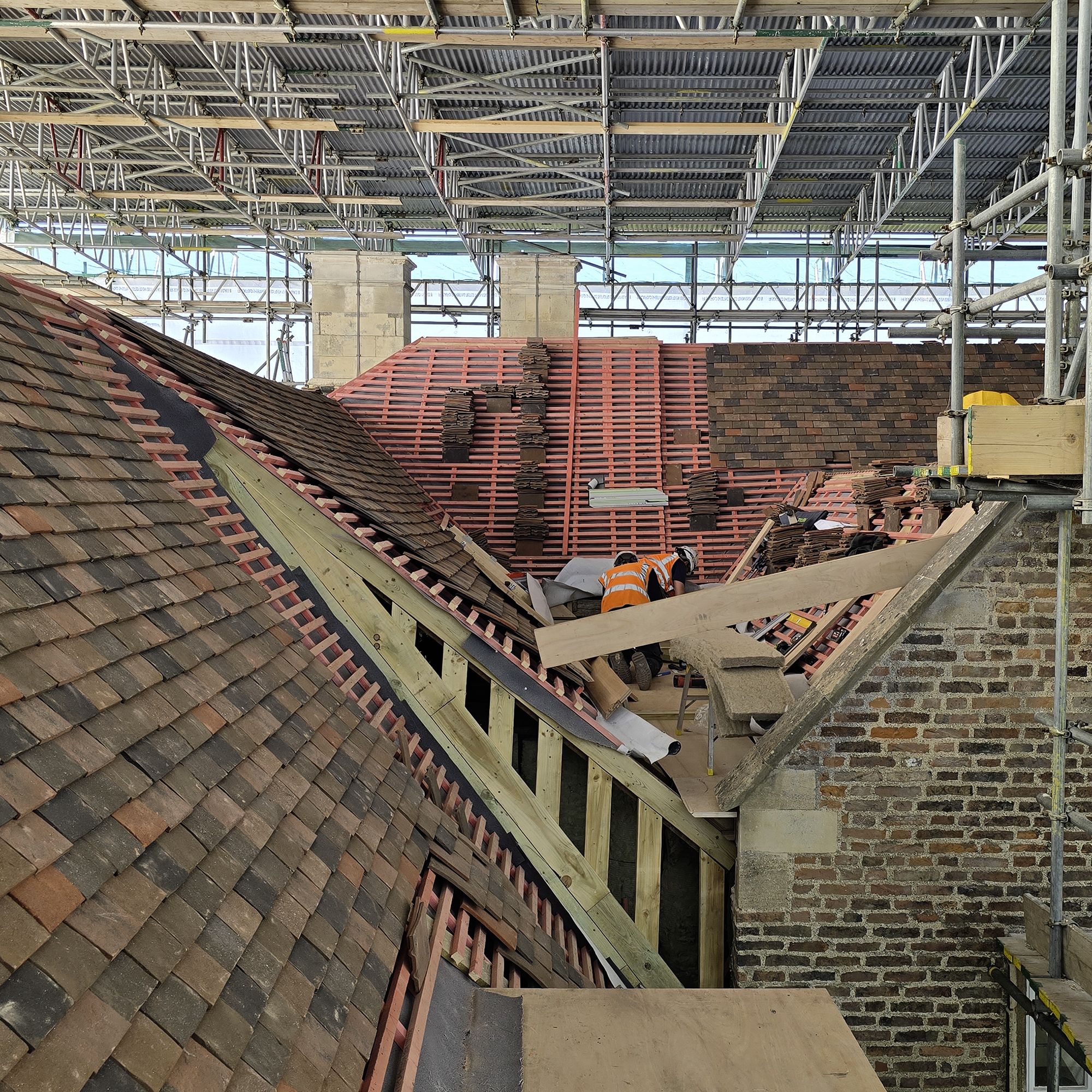

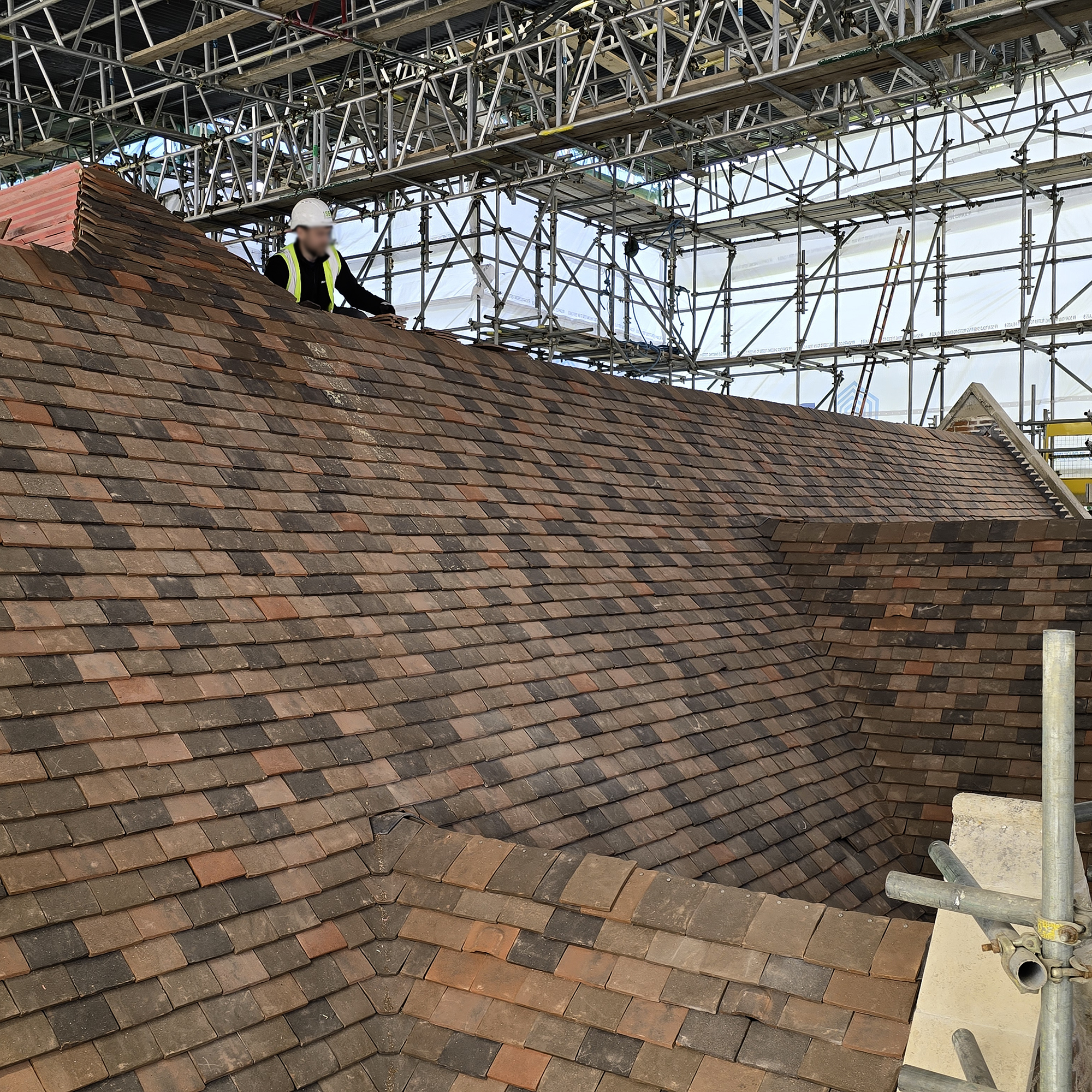

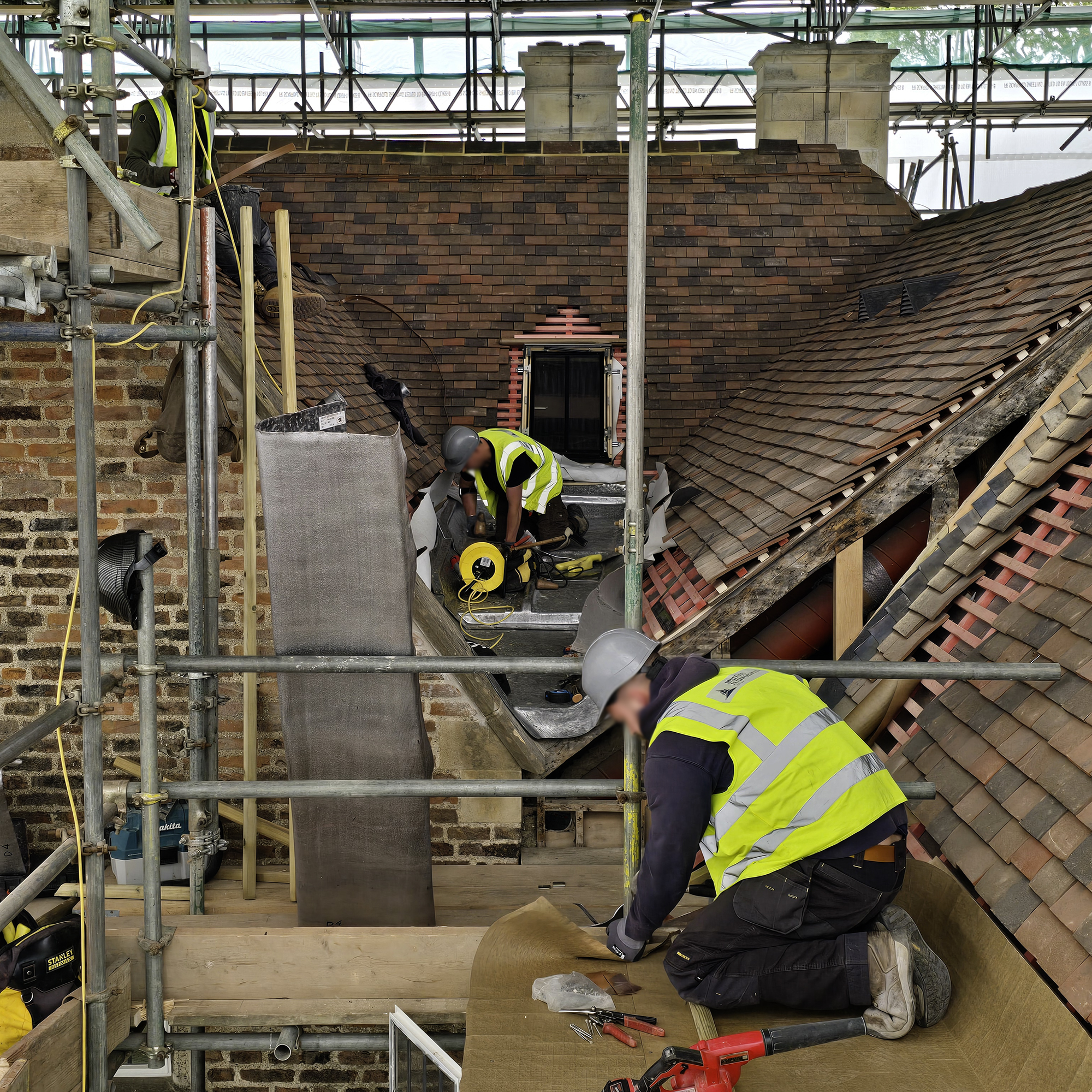

Work has begun on removing the roof tiles. With the temporary roof in place, the building remains protected and watertight while the tiles are carefully taken up. This stage marks the beginning of uncovering the original roof timbers, allowing specialists to inspect and restore the historic structure.
October 2025
During the stripping of the building, several intresting discoveries were uncovered. Among them were sections of original reed matting used in the construction of the walls and ceilings. Inside a wall on the second floor of the Right Cloister, an old shoe and a piano key were also found, offering intriguing glimpses into the building’s past.
October 2025

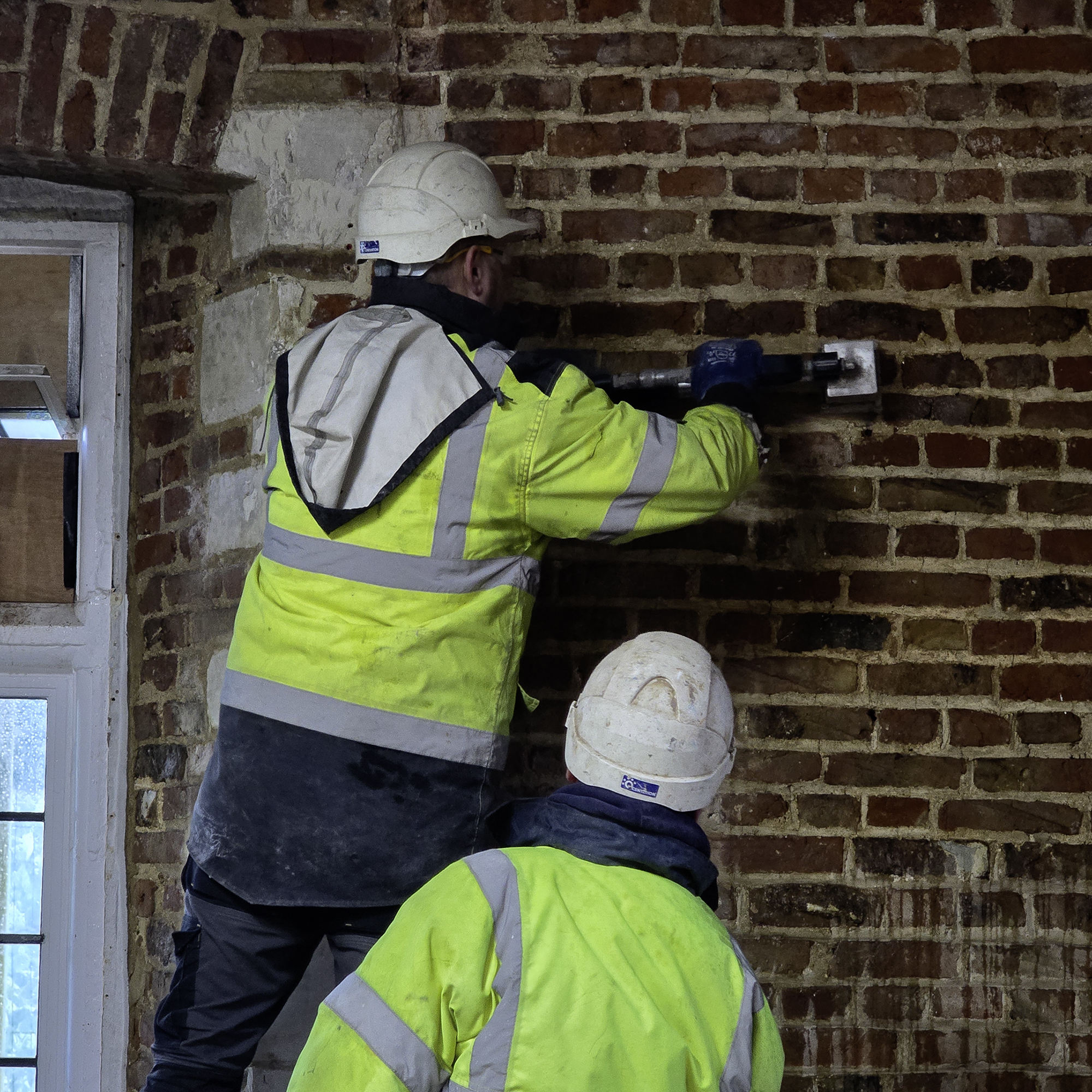

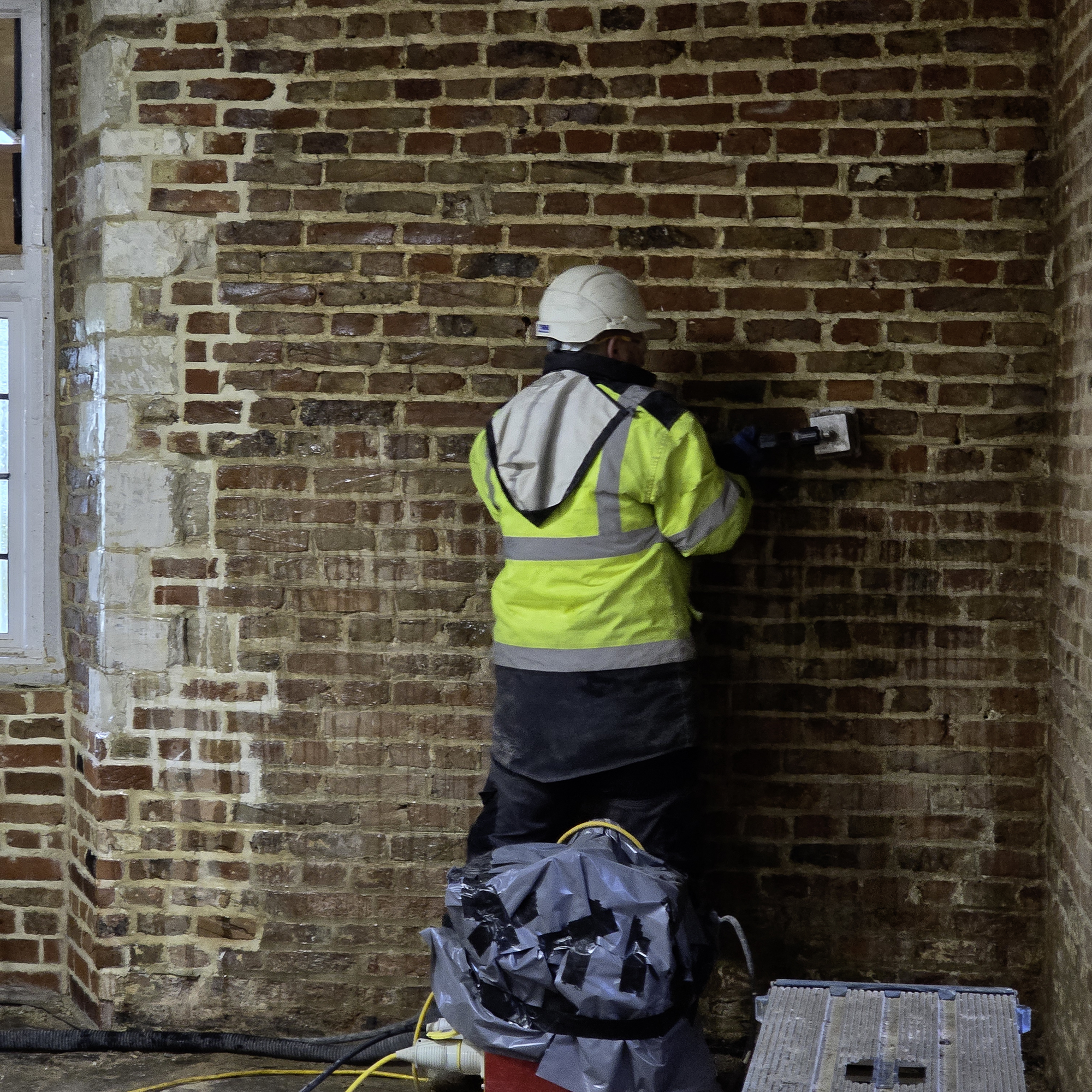

On the second floor of the Left Cloister, the space has been stripped back to reveal the original brickwork. A new opening has been created in the floor to accommodate a lift, which will provide step-free access to the historic Pepys Library, ensuring it can be enjoyed by everyone.
October 2025

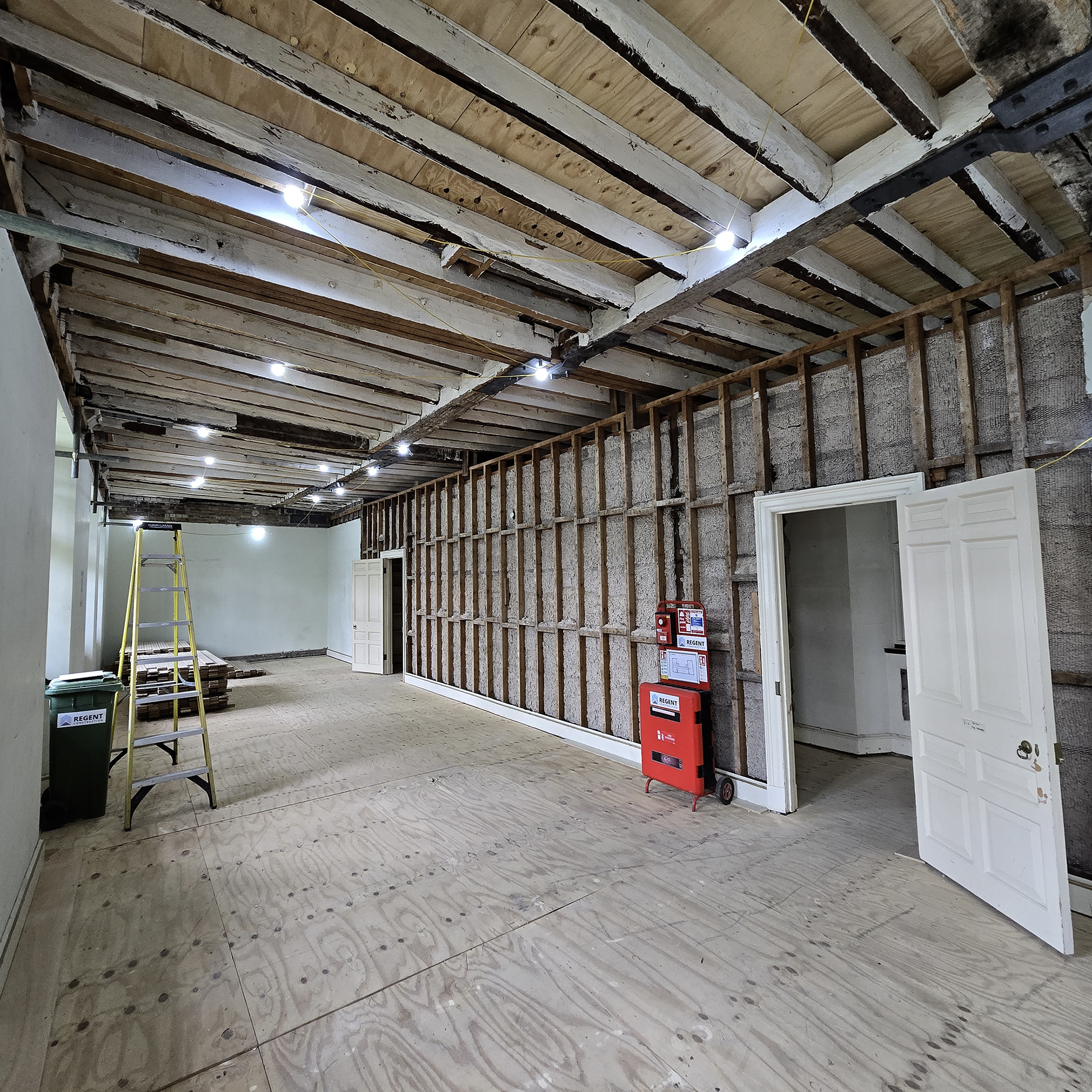

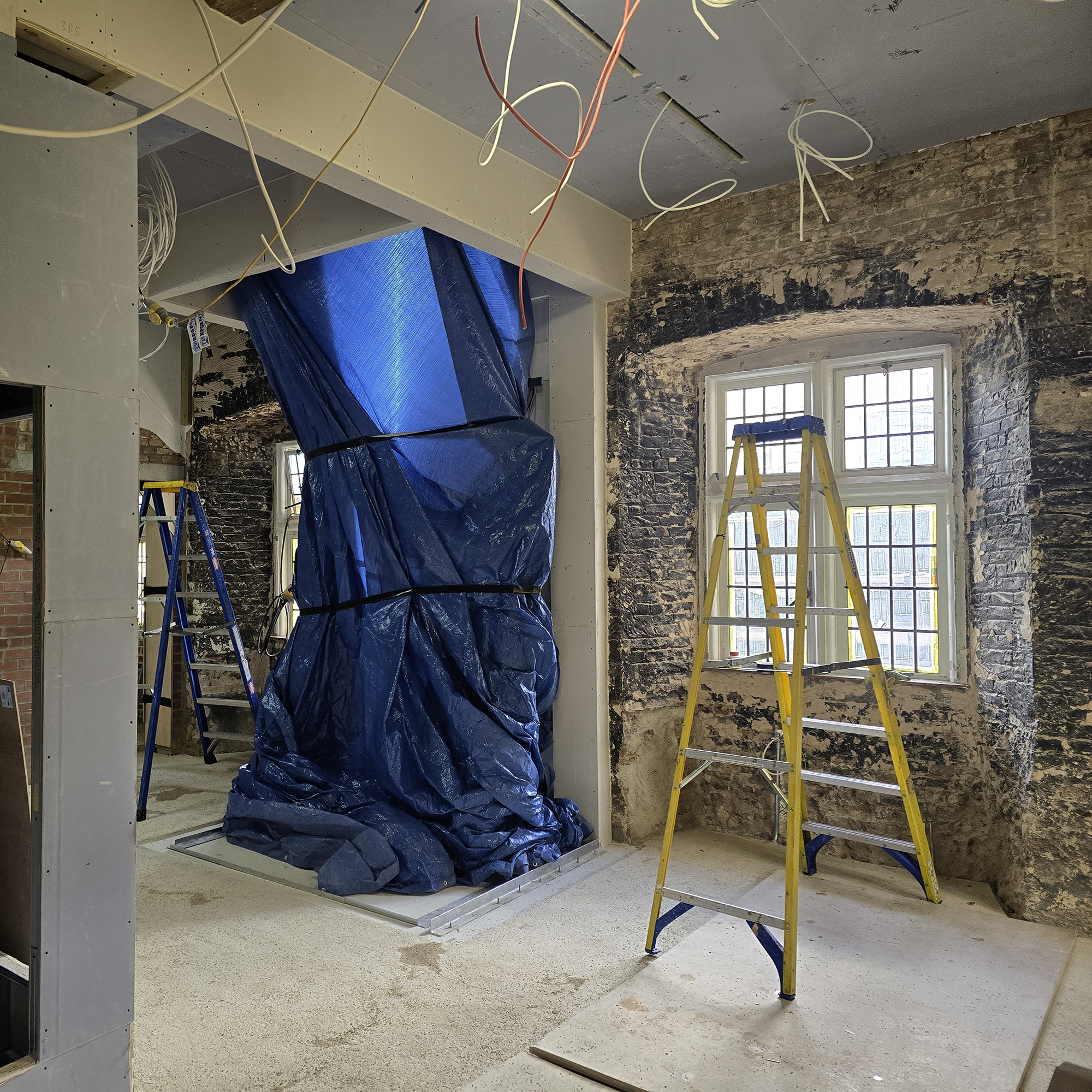

The most important room in the entire building, the Pepys Library, has now been carefully stripped back. The removal of the suspended ceiling has revealed the original timber beams, allowing for detailed assessment, conservation and a closer look at the craftsmanship and structure of this remarkable historic space.
October 2025

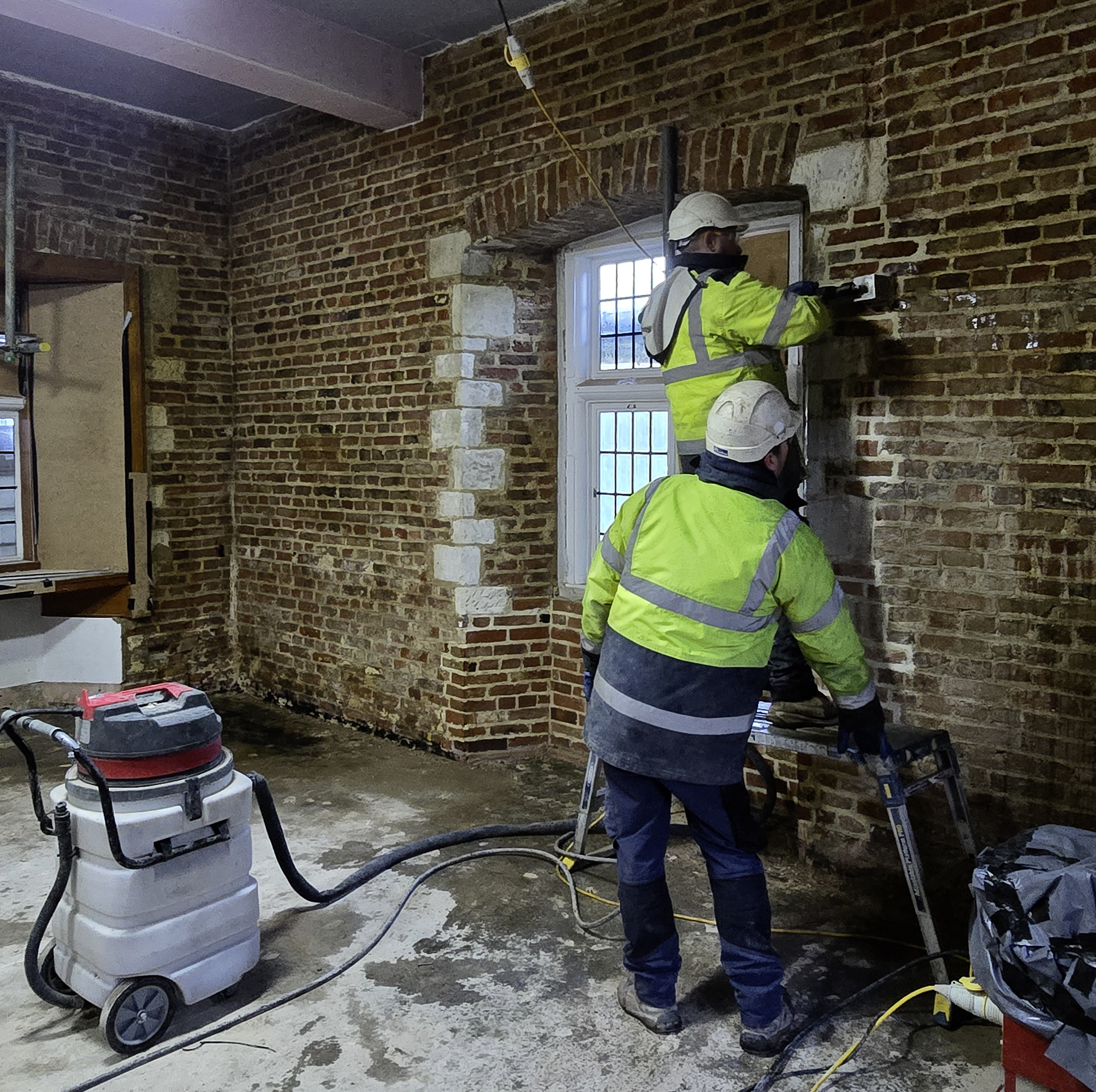

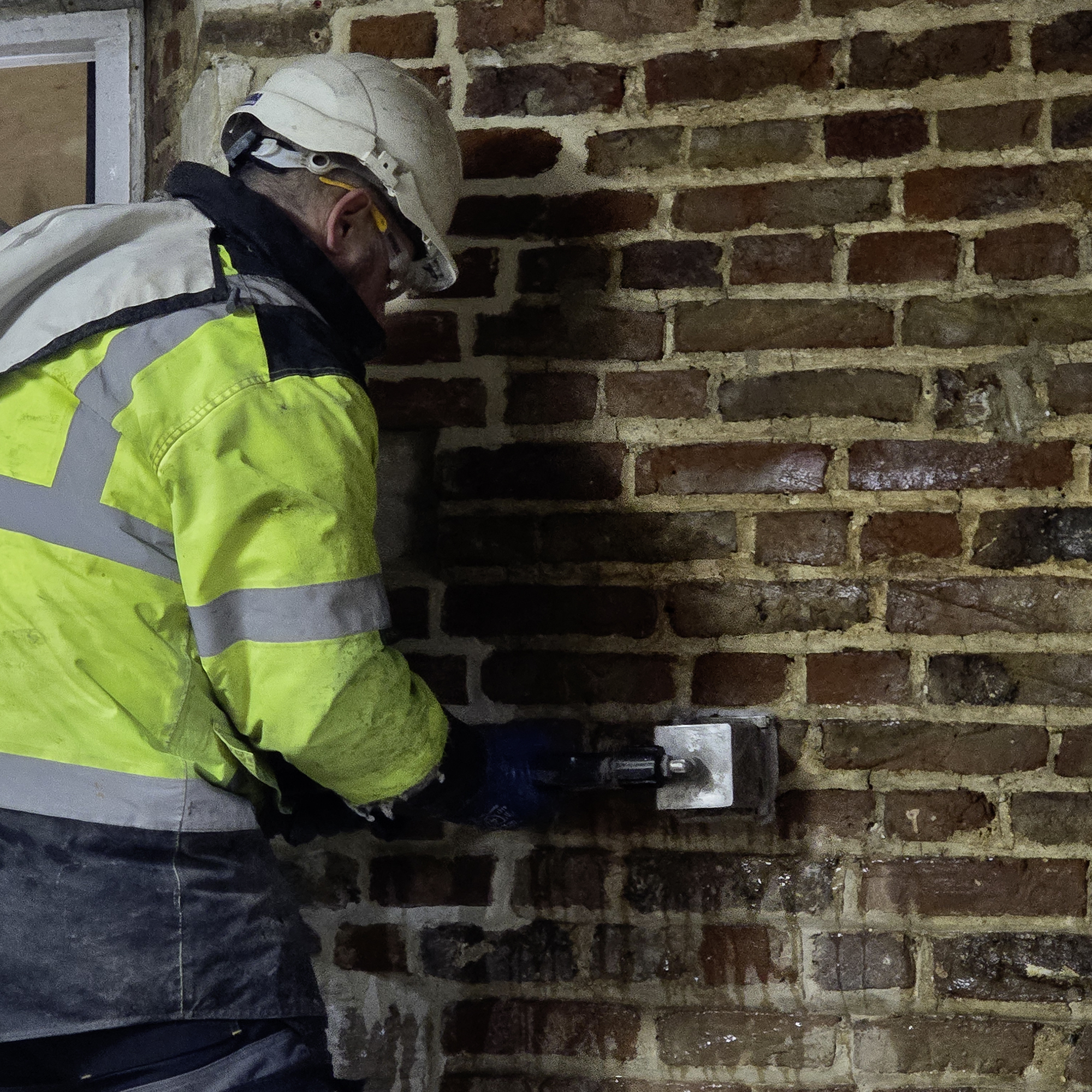

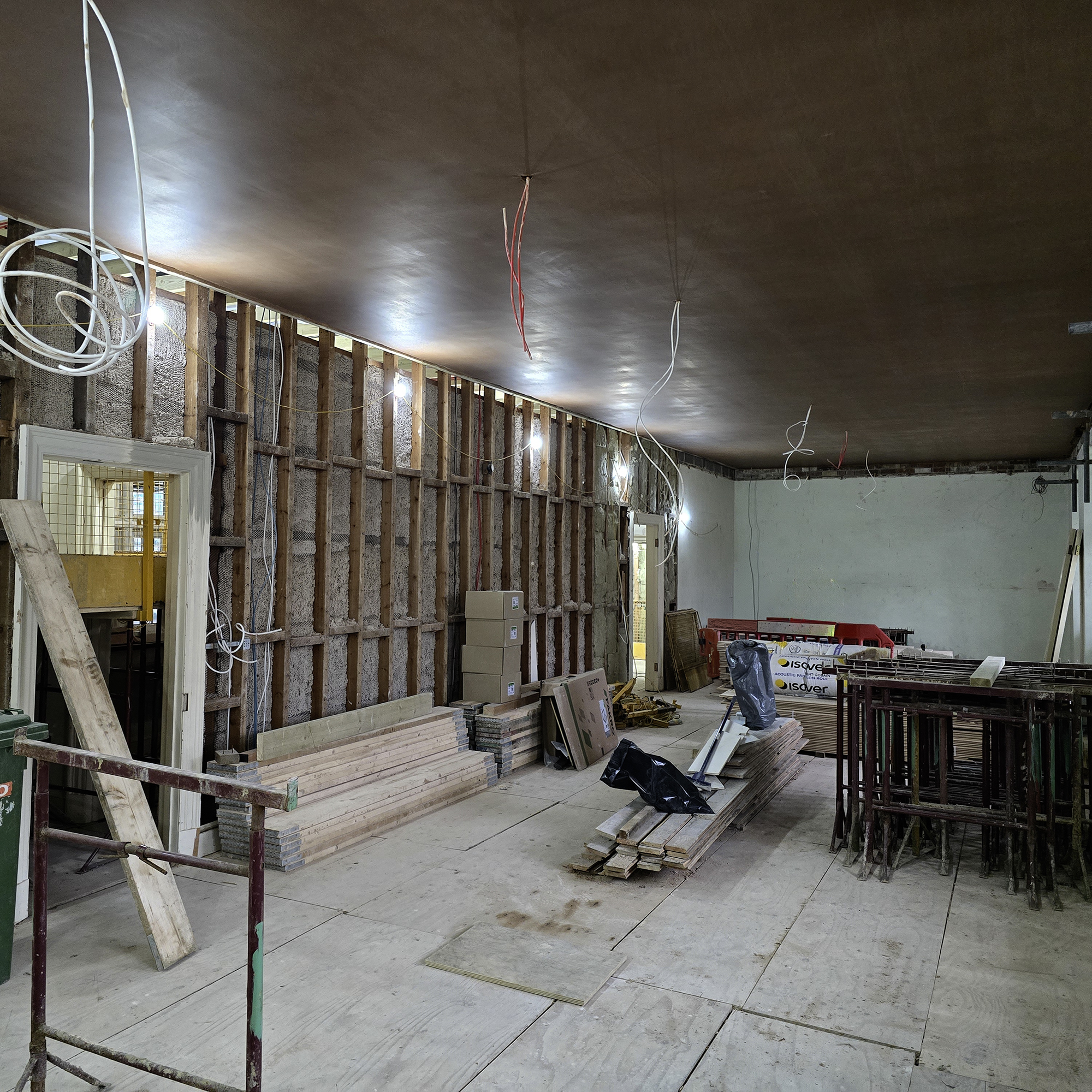

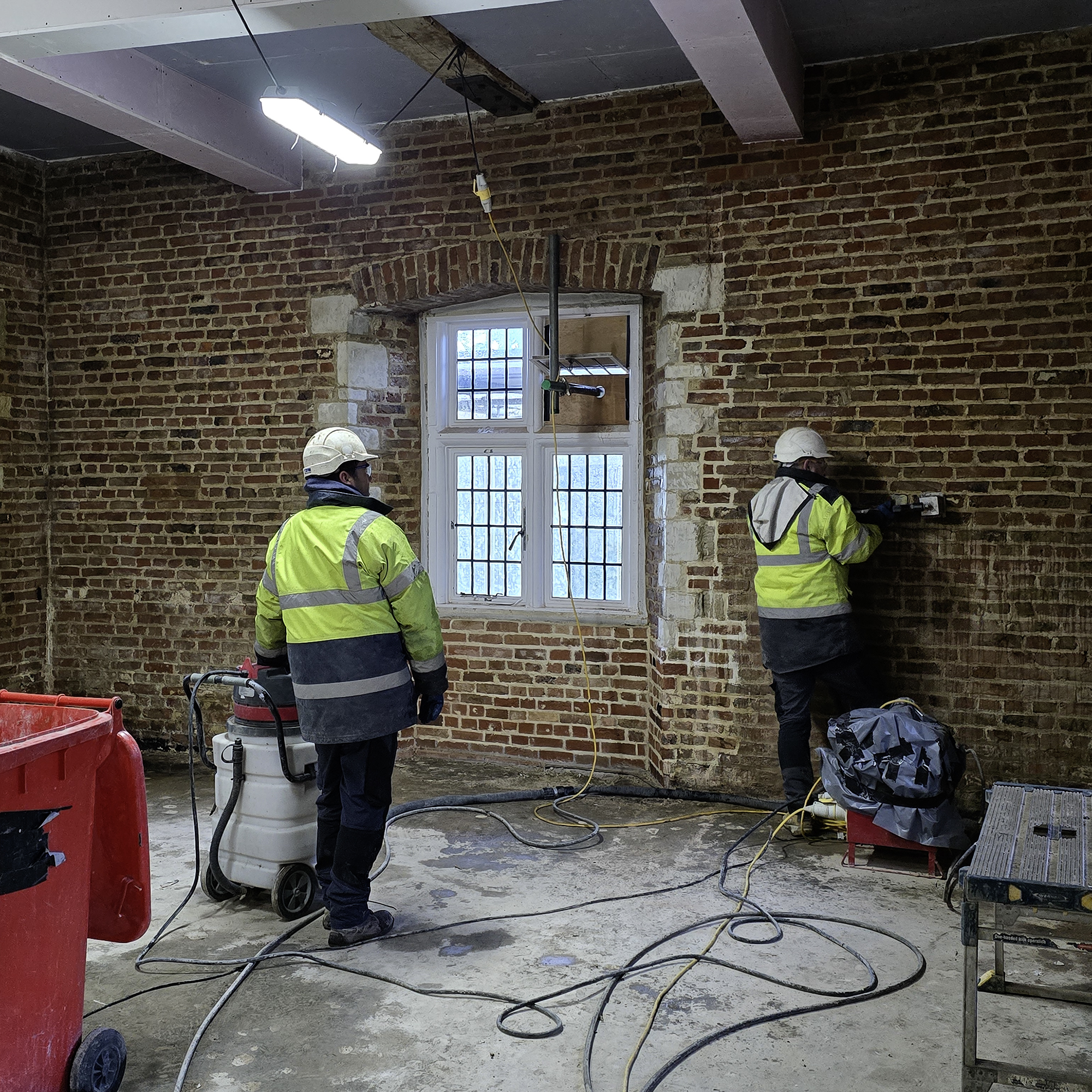

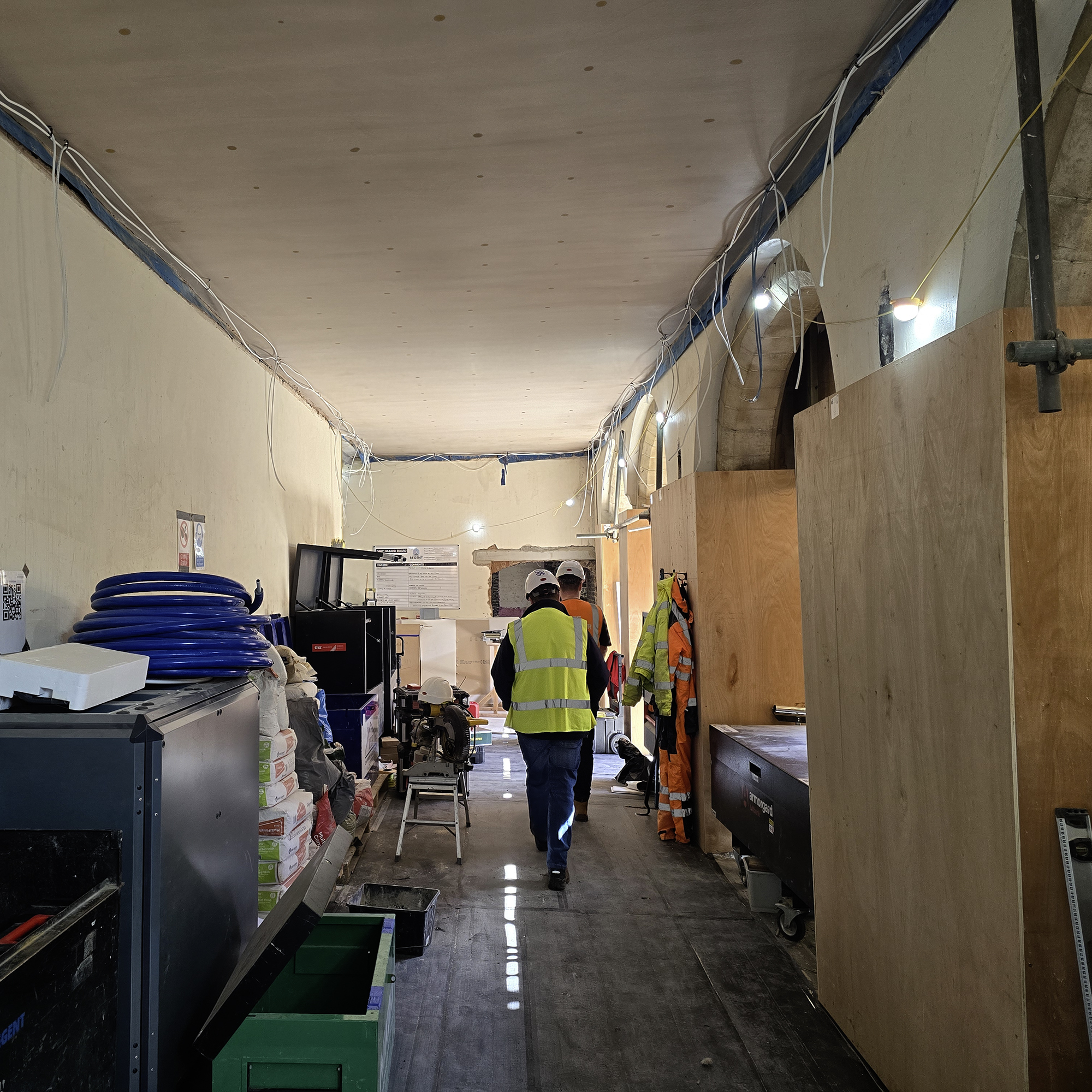

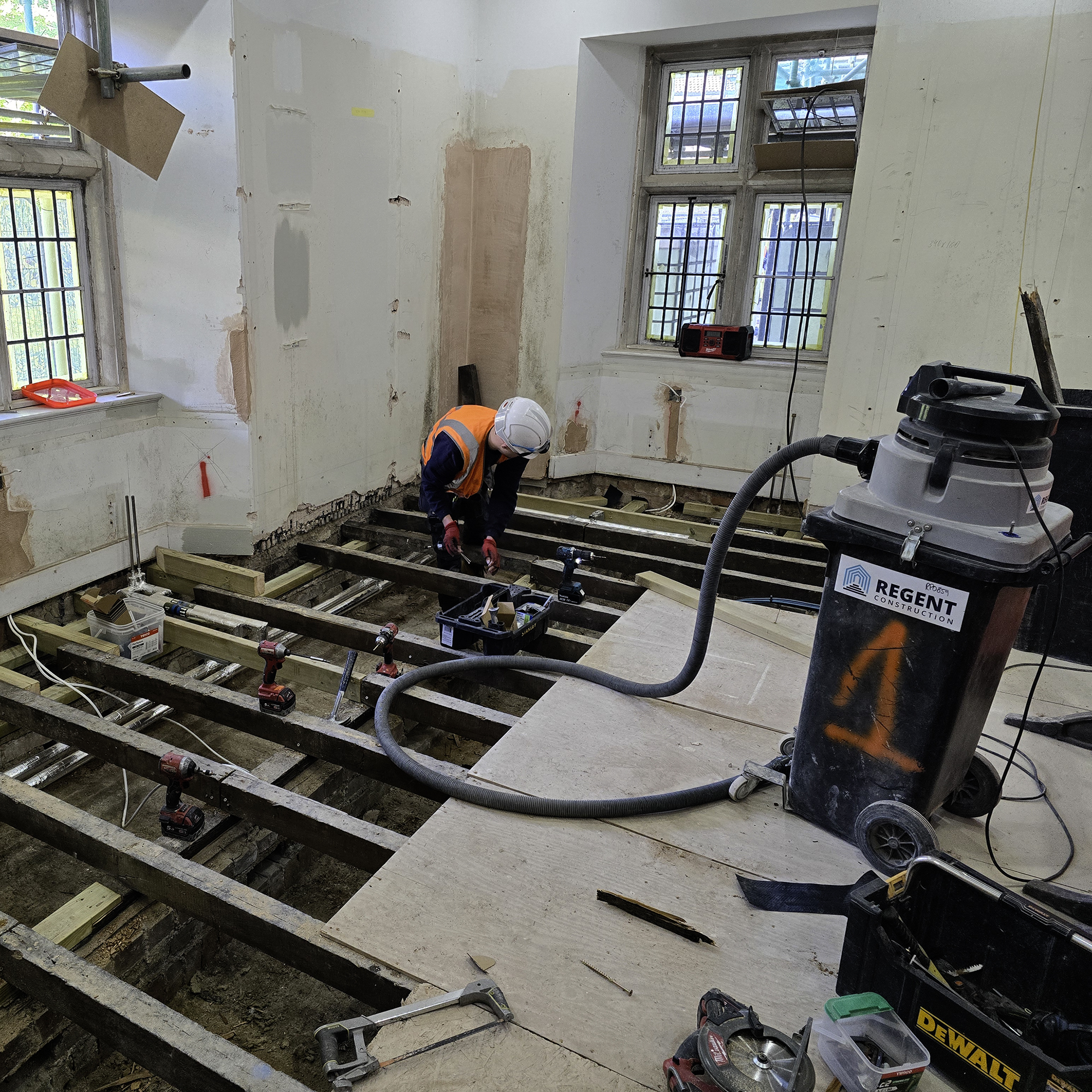

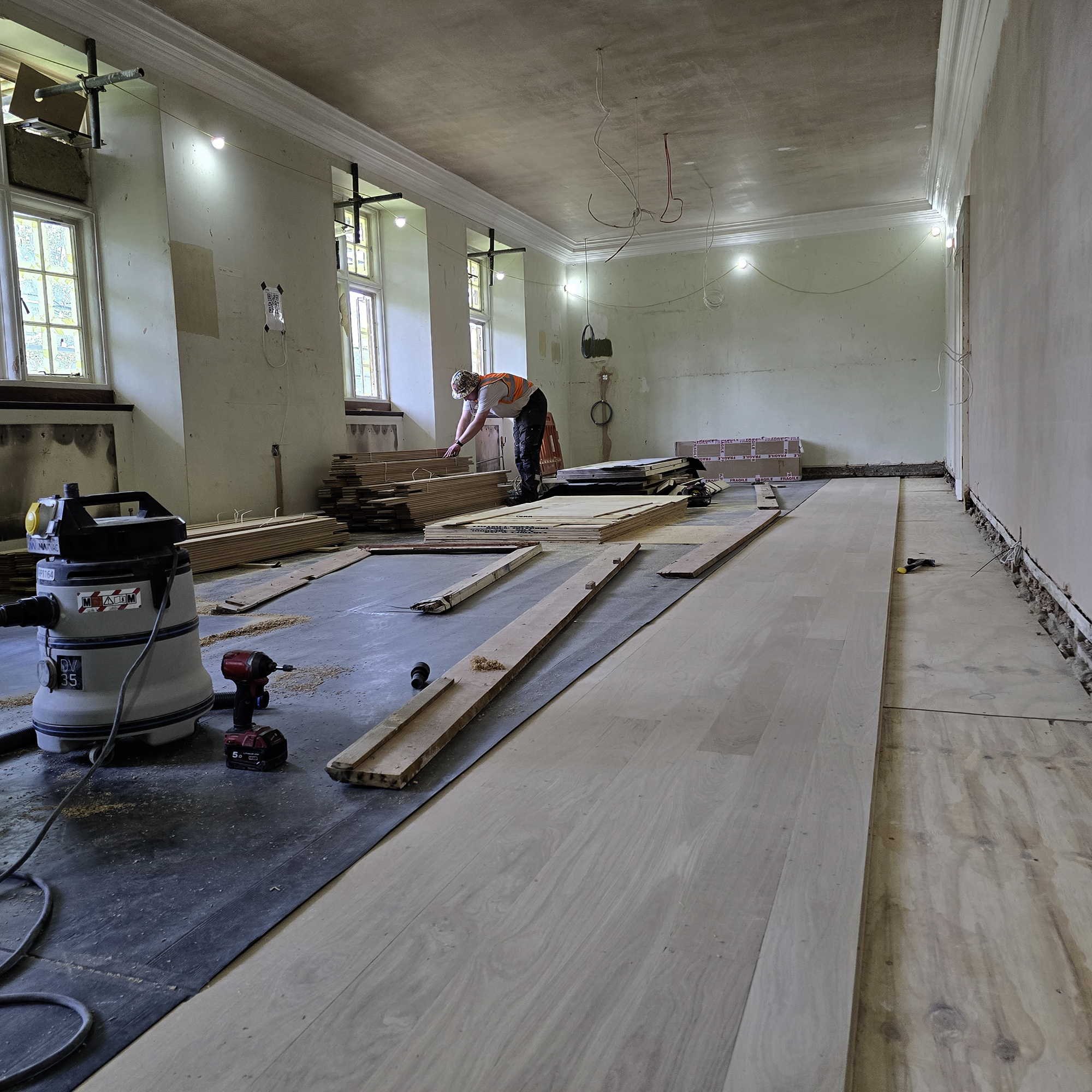

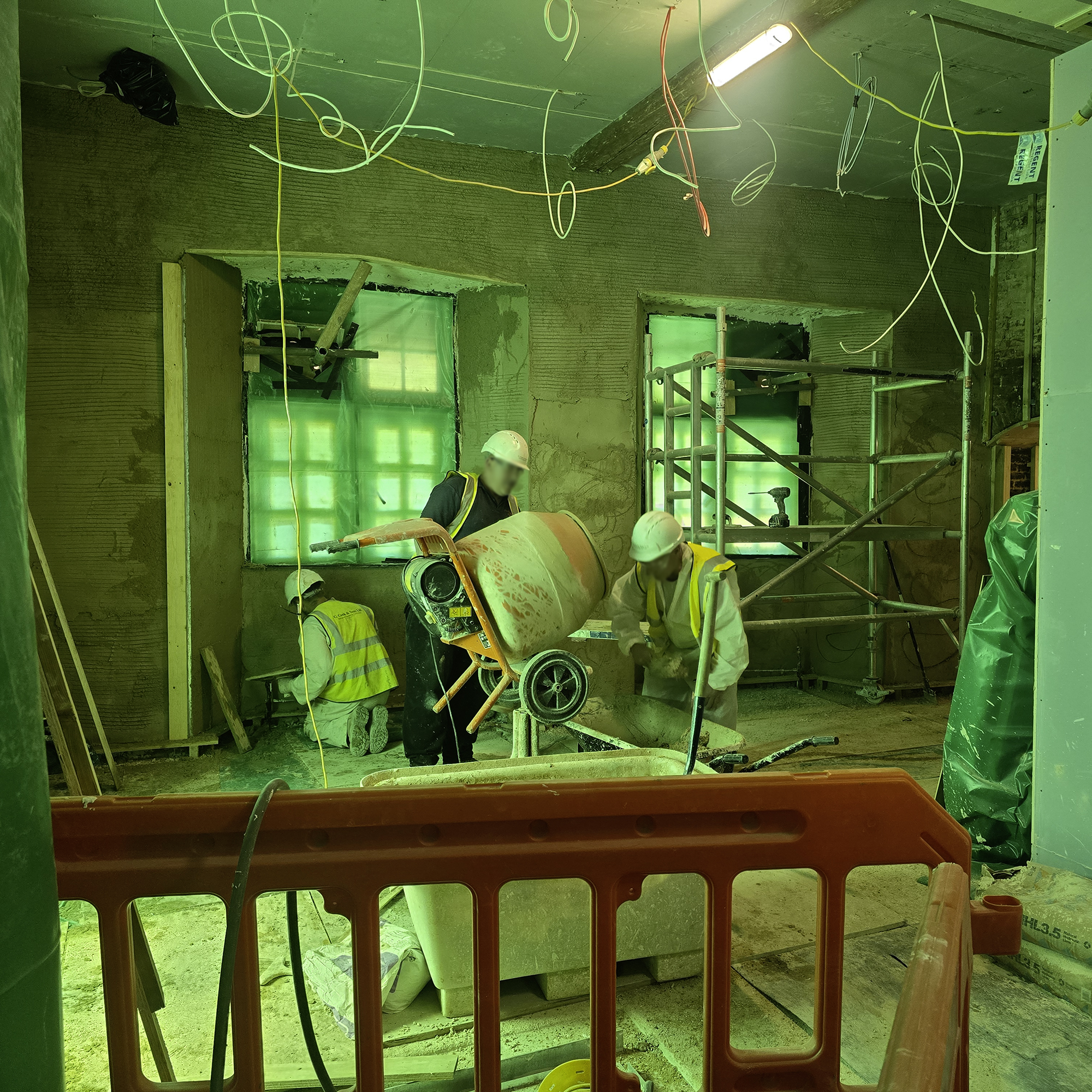

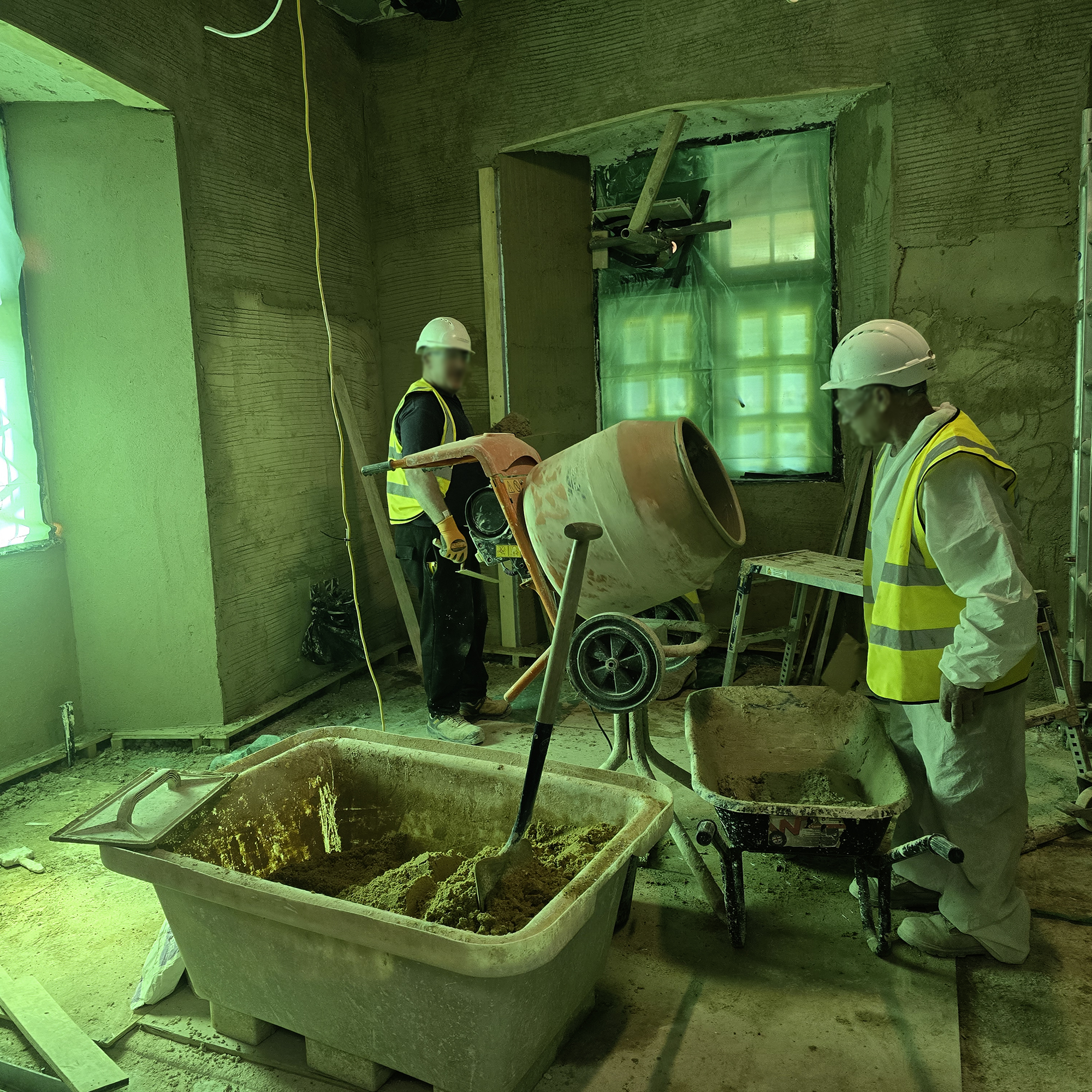

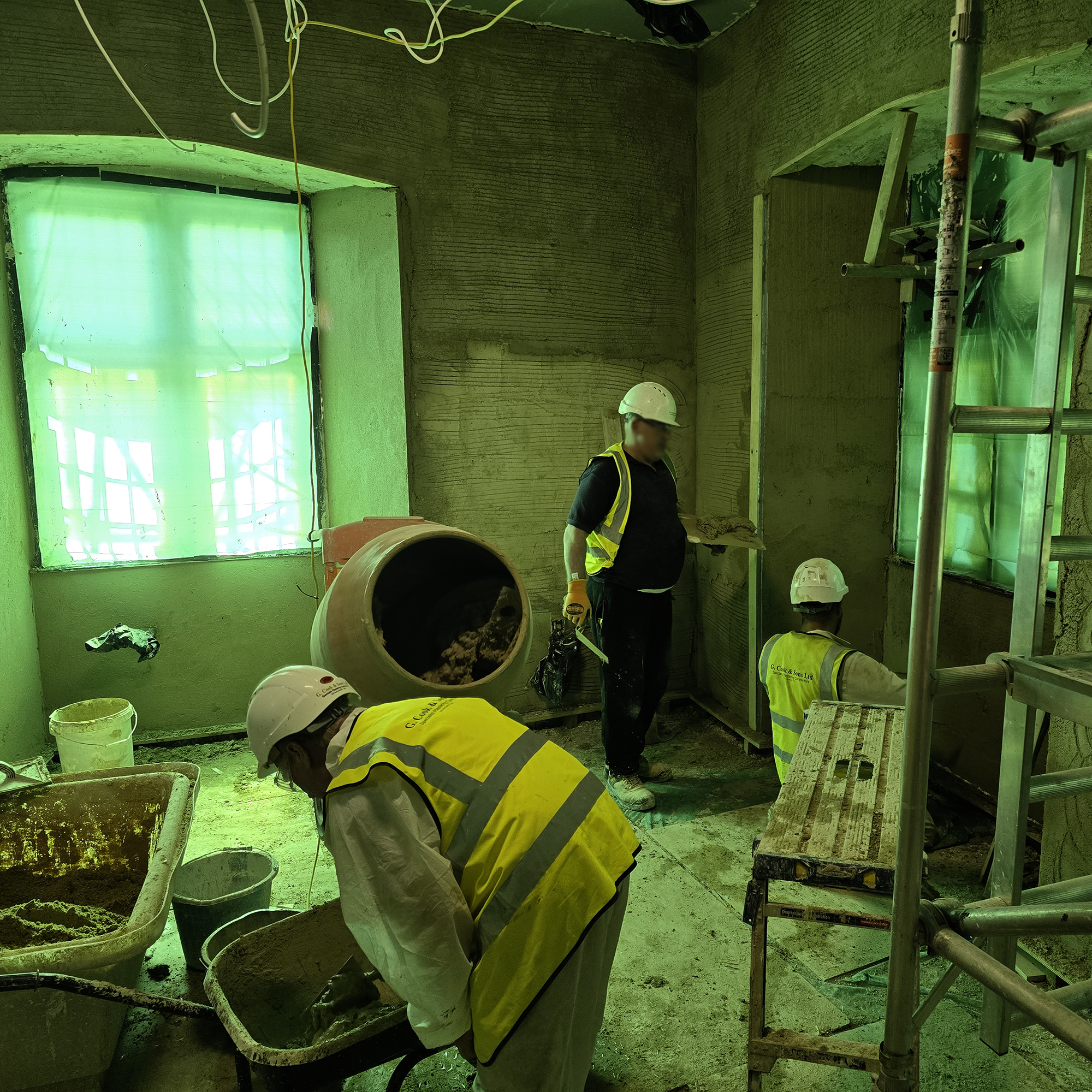

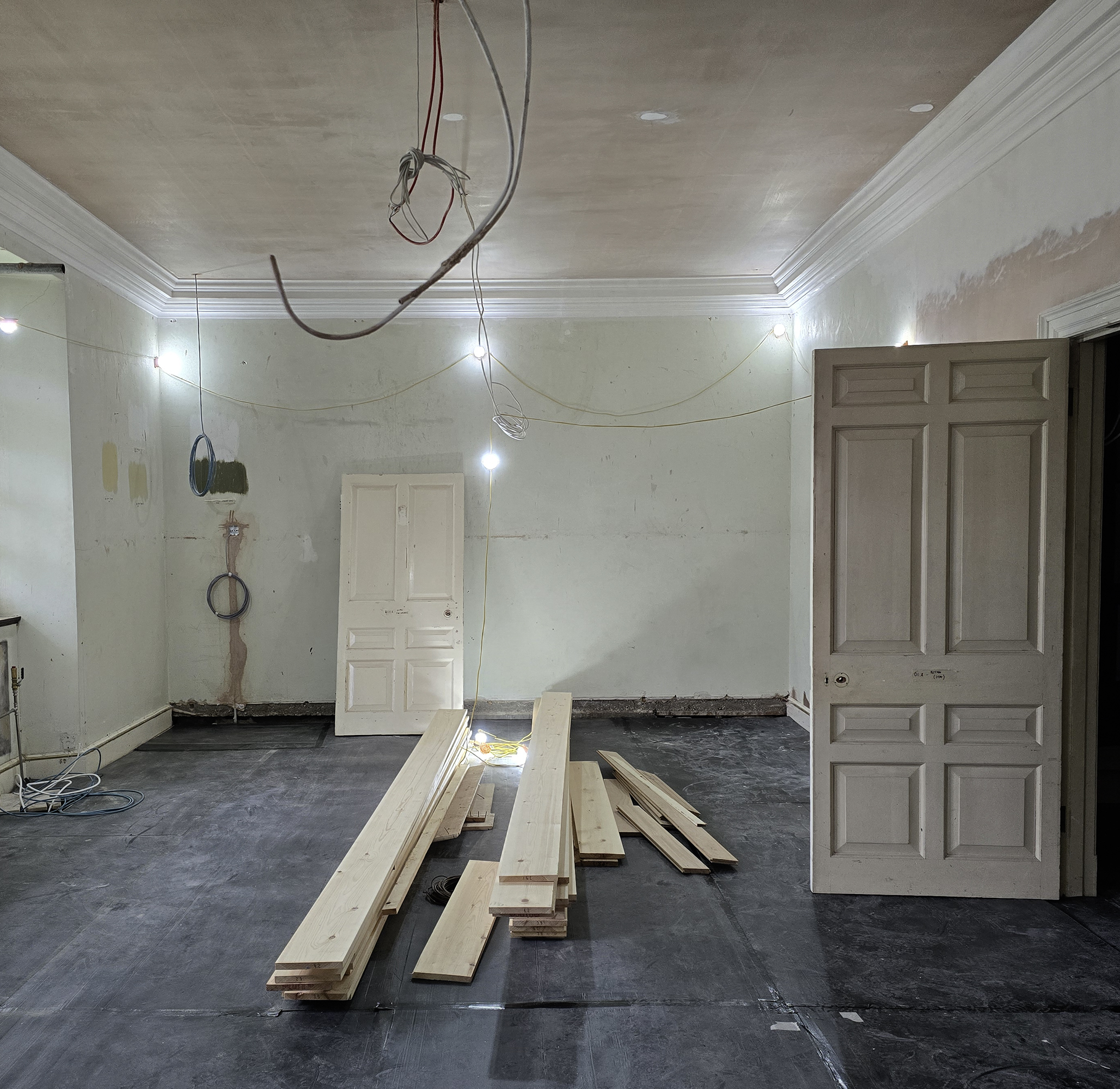

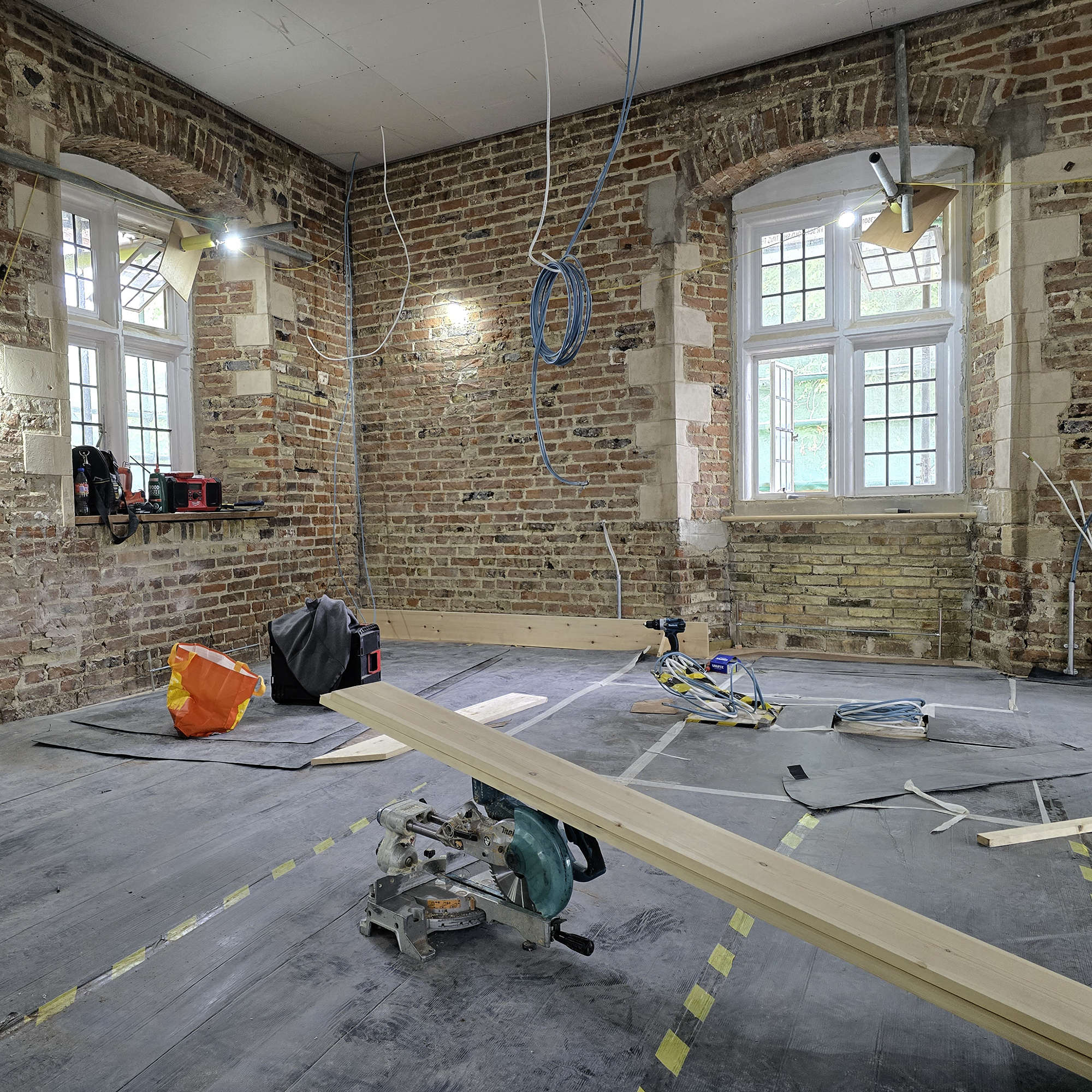

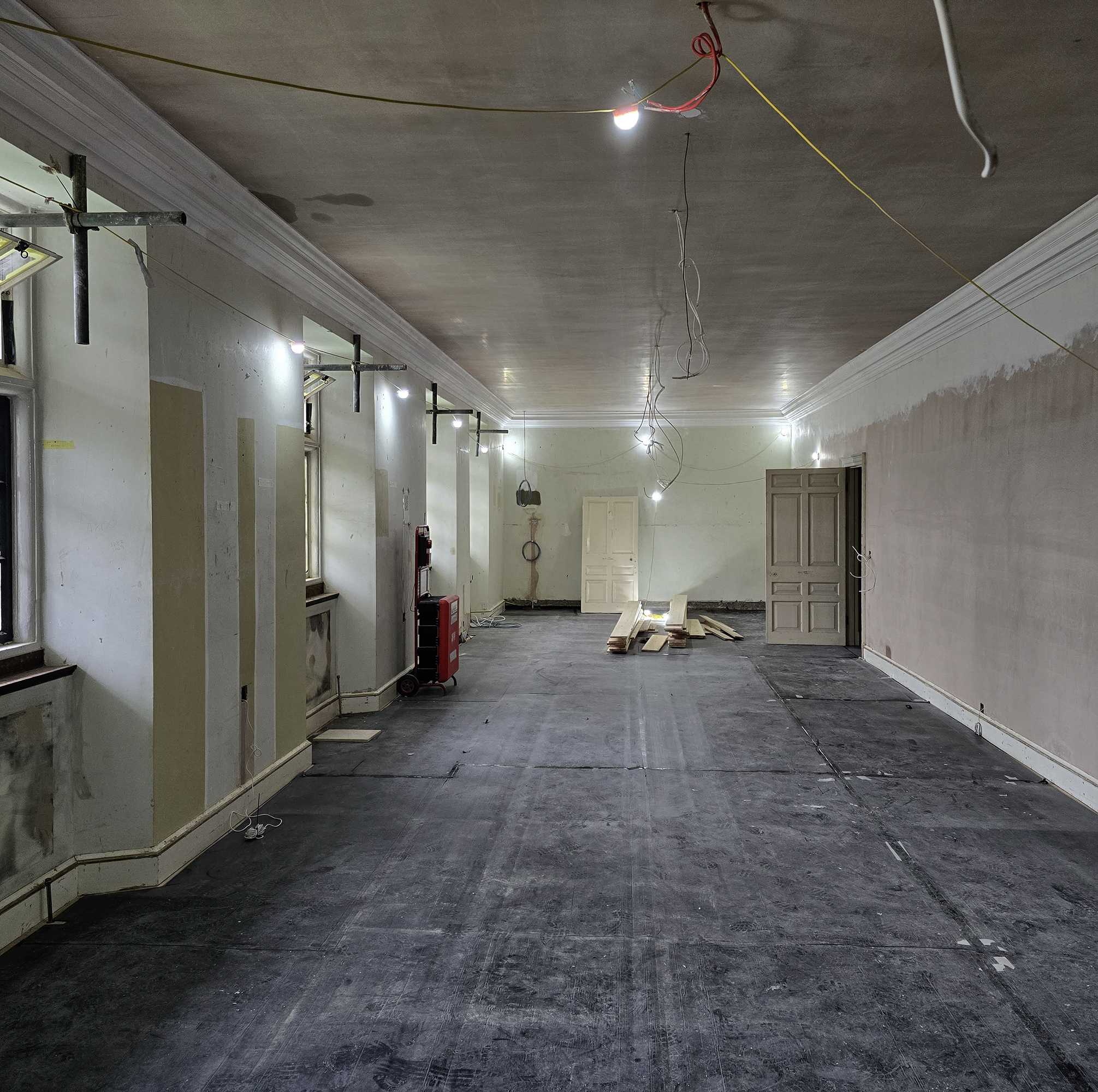

Initial enabling work on the ground floor, with interiors being carefully stripped back to the structural shell. This process prepares the space for essential repairs and future rebuilding.
September 2025

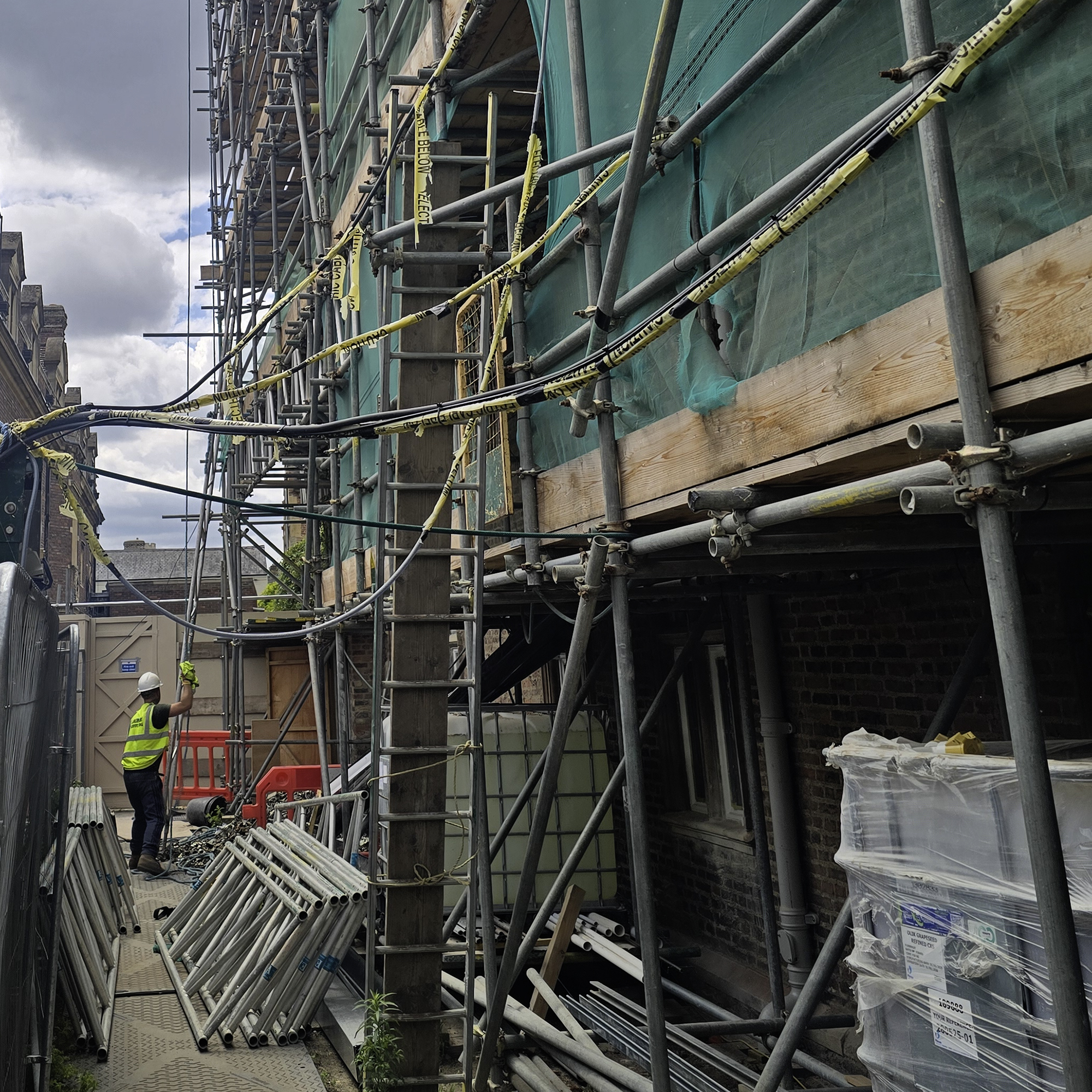

Protective netting, side panels, and a temporary roof have been fitted to the scaffolding to shield the building from weather and debris during construction. This ensures a secure, controlled environment for the restoration work.
August 2025

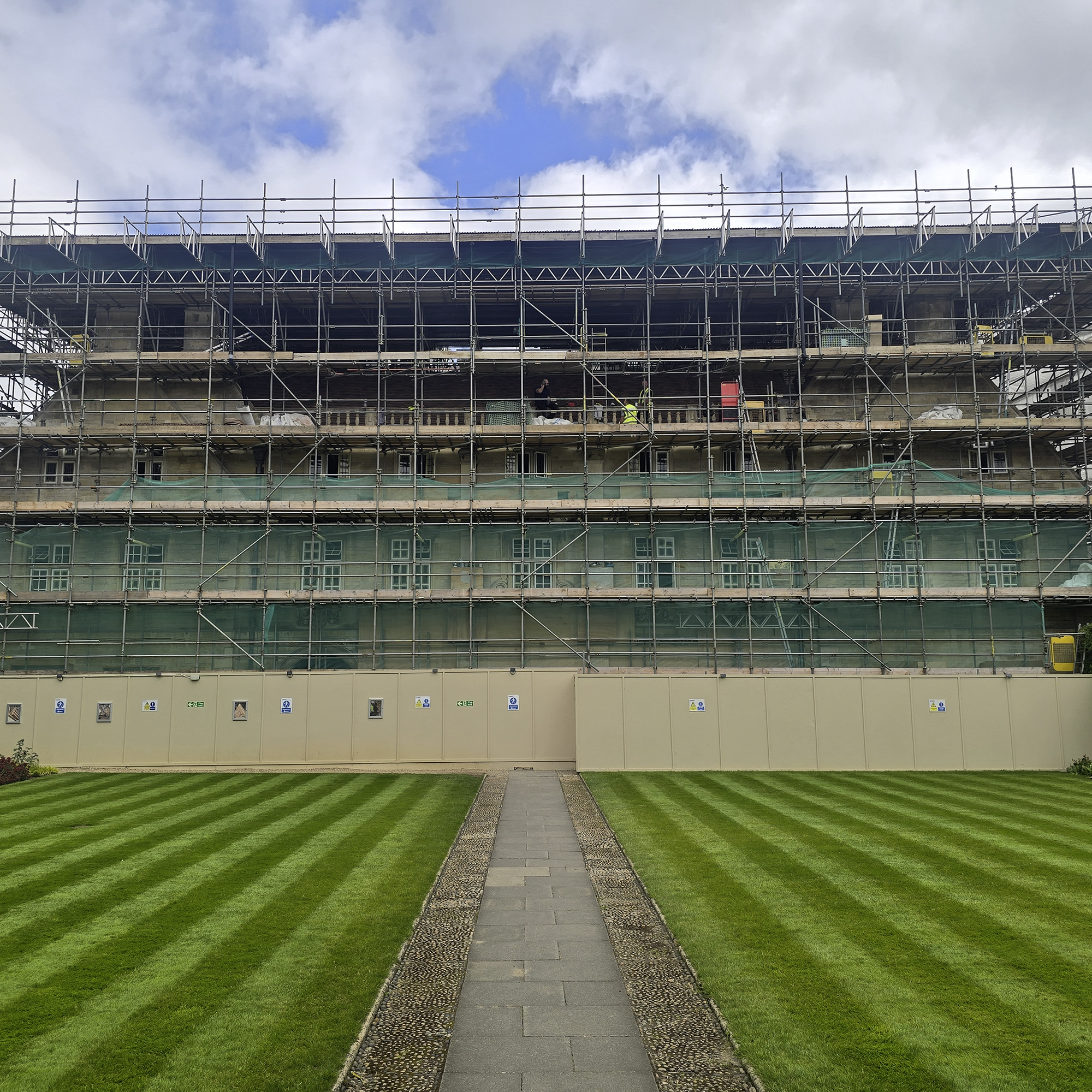

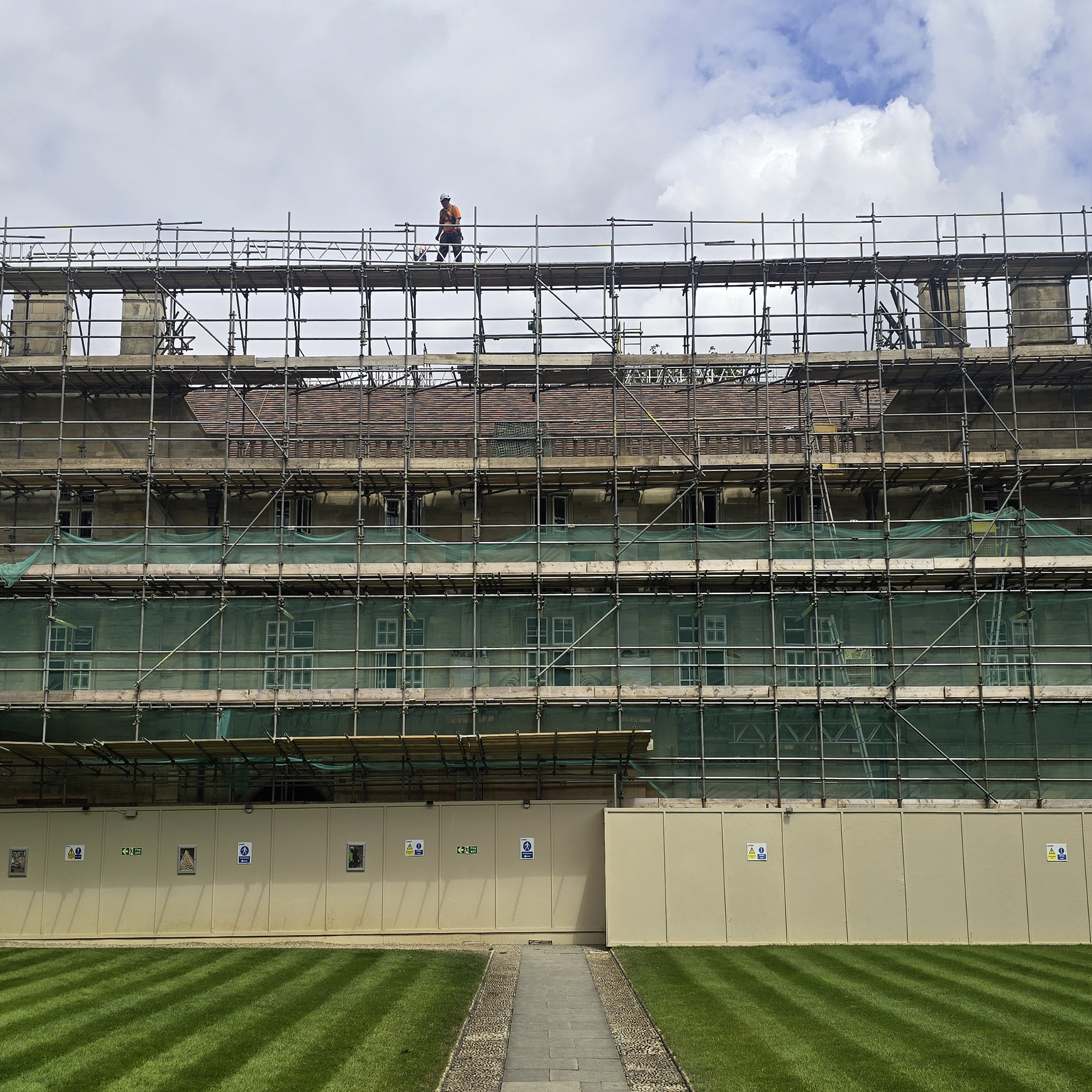

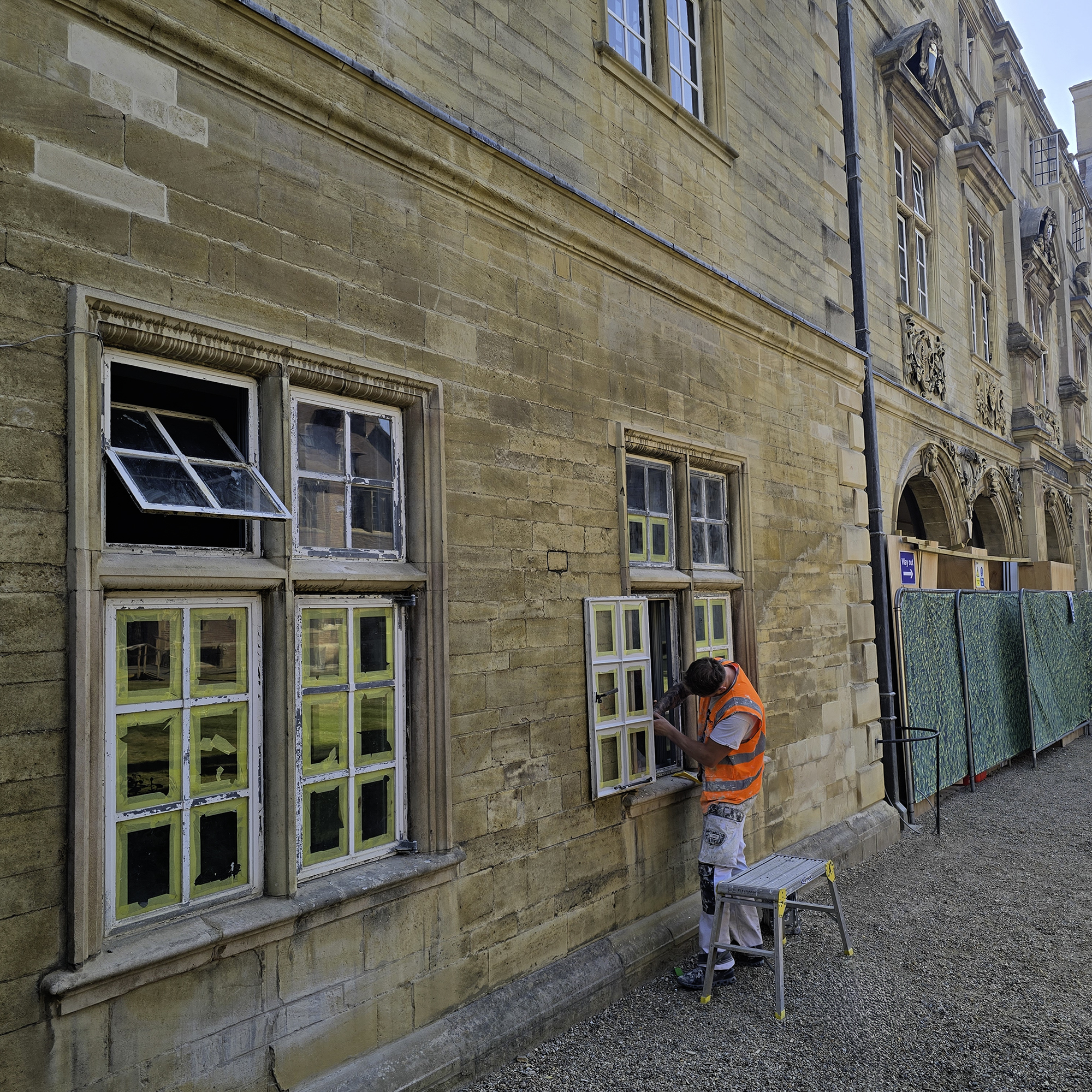

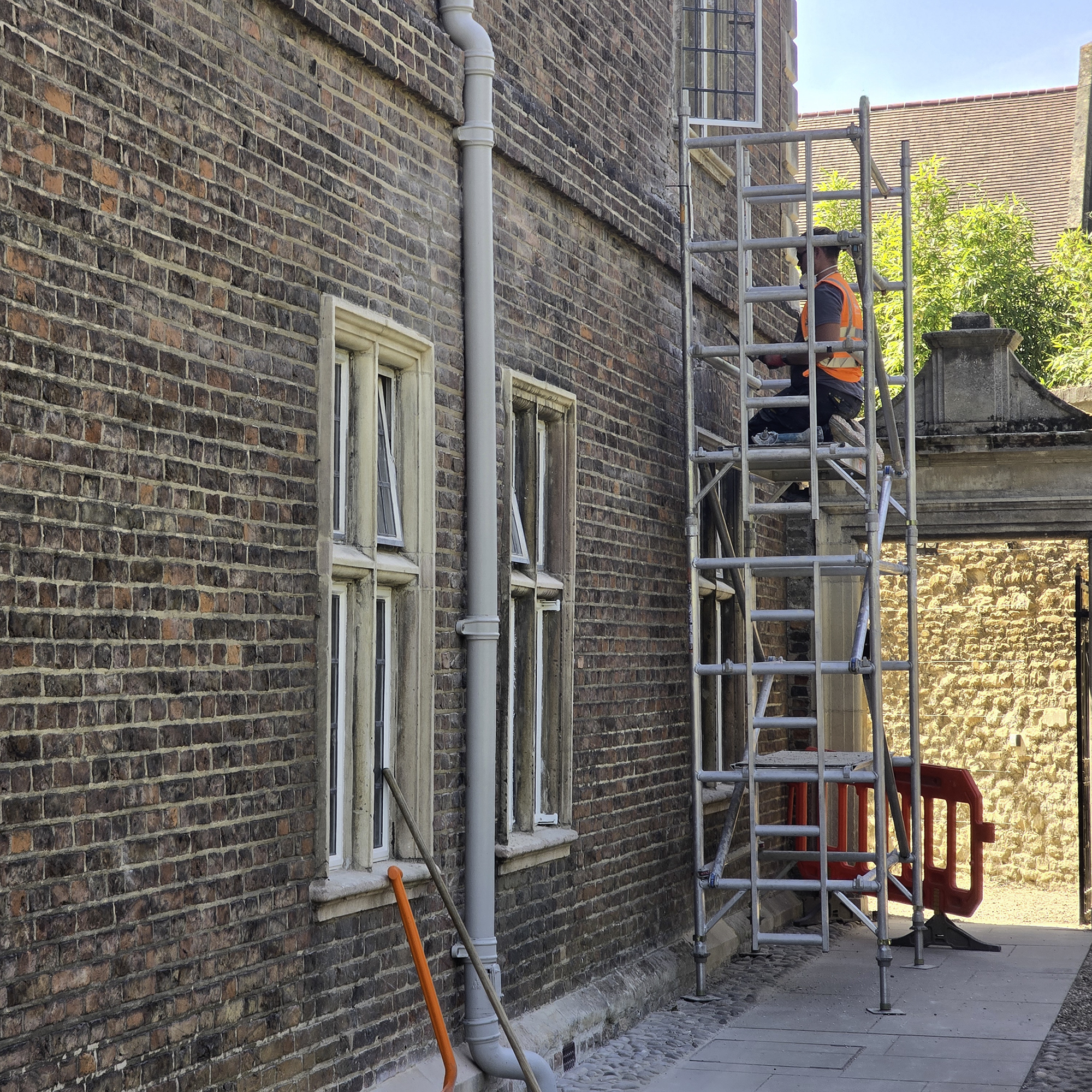

Scaffolding has been installed around the Pepys Building to provide protection to the building and safe access for workers ahead of the roof removal. This stage marks the beginning of major restoration work.
